Upper Chumstick Barrier Removal
|
    Funding |
  |
|
    Links |
  |
|
|
The objective of the Upper Chumstick Barrier Removal project is to improve migration of salmonids to and from historical spawning and rearing habitat along the upper portion of Chumstick Creek (RM 7.3-9.8). This project corrects fish passage barriers at five worksites - Saliby, Ott/Johnson, Baumann, Cann and Scheibler. This will complete a 15 year effort to remove over 30 barriers within the first 9.8 miles of Chumstick Creek. This effort will increase spatial structure, abundance, and productivity of salmonids in the Wenatchee watershed. Due to development along the creek, a high concentration of stream crossings exist, some of which are barriers to salmonid migration. Barrier removal will address two habitat limiting factors including up and downstream passage and riparian habitat.
|
General Area:
|
|
North of Leavenworth
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Chumstick
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
06
|
Sections:
|
|
31
|
Township:
|
|
T25NR18E
|
Township:
|
|
T26NR18E
|
Coordinates:
|
|
47.69542705 -120.63846147
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Saliby (#1)
|

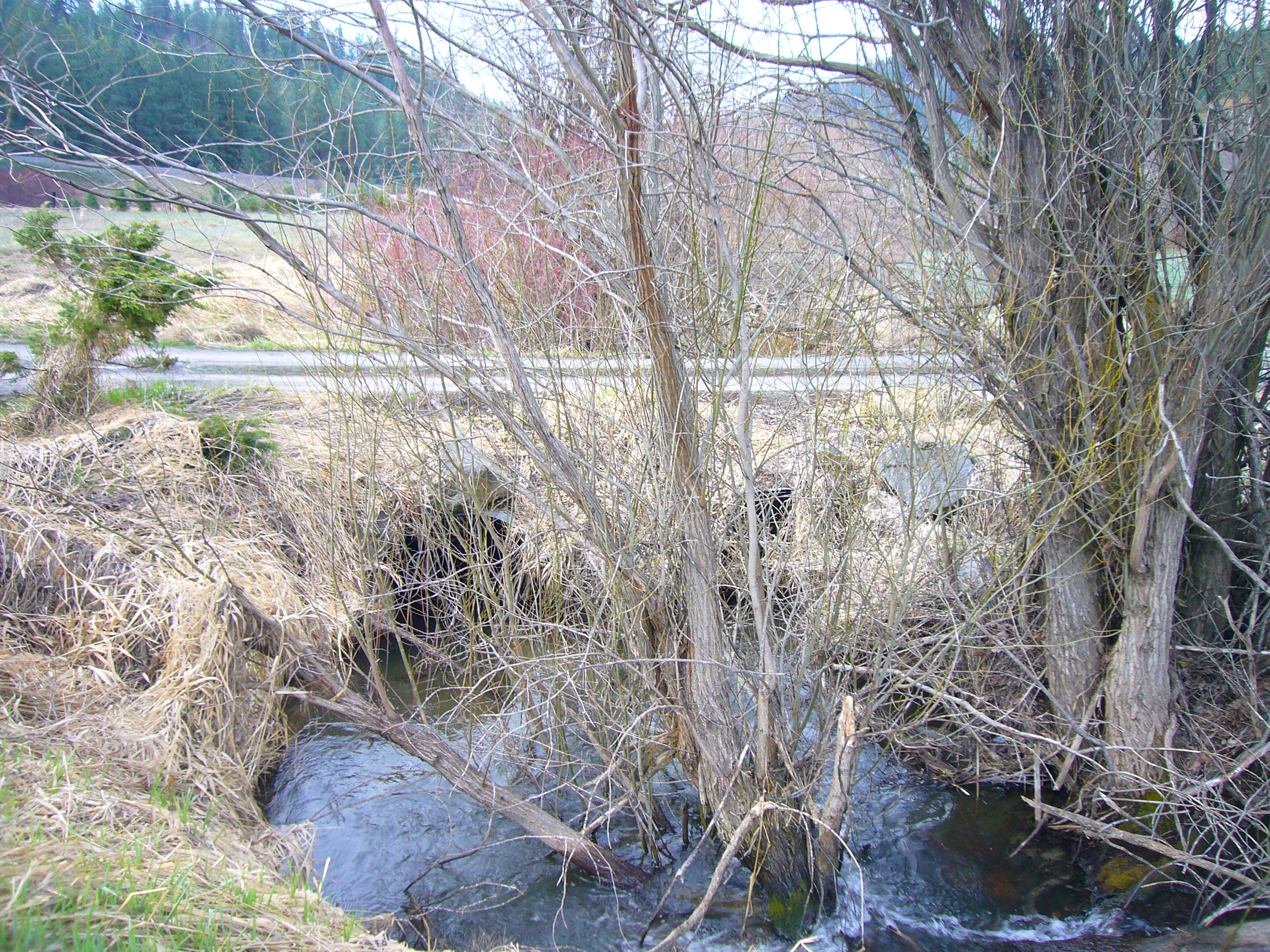

Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Cultural resources, Obtain permits, Planting (C.5.c.1), Traffic control, Utility relocation / reconnection
|
$91,796
|
Ott/Johnson (#2)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Cultural resources, Obtain permits, Planting (C.5.c.1), Traffic control, Utility relocation / reconnection
|
$93,151
|
Baumann (#3)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Cultural resources, Obtain permits, Planting (C.5.c.1), Traffic control, Utility relocation / reconnection
|
$86,457
|
Cann (#4)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Cultural resources, Obtain permits, Planting (C.5.c.1), Traffic control, Utility relocation / reconnection
|
$86,457
|
Scheibler (#5)
|

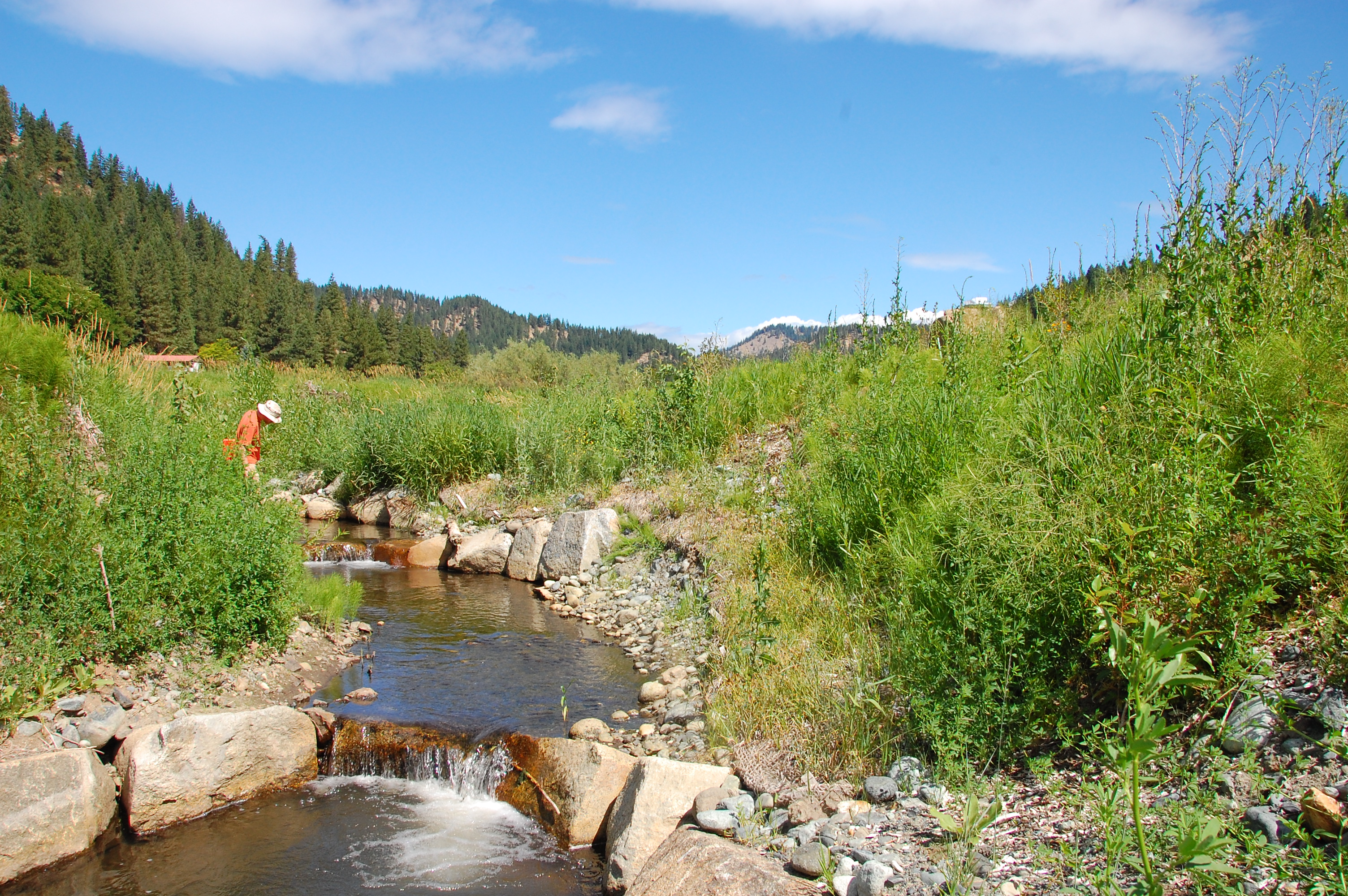

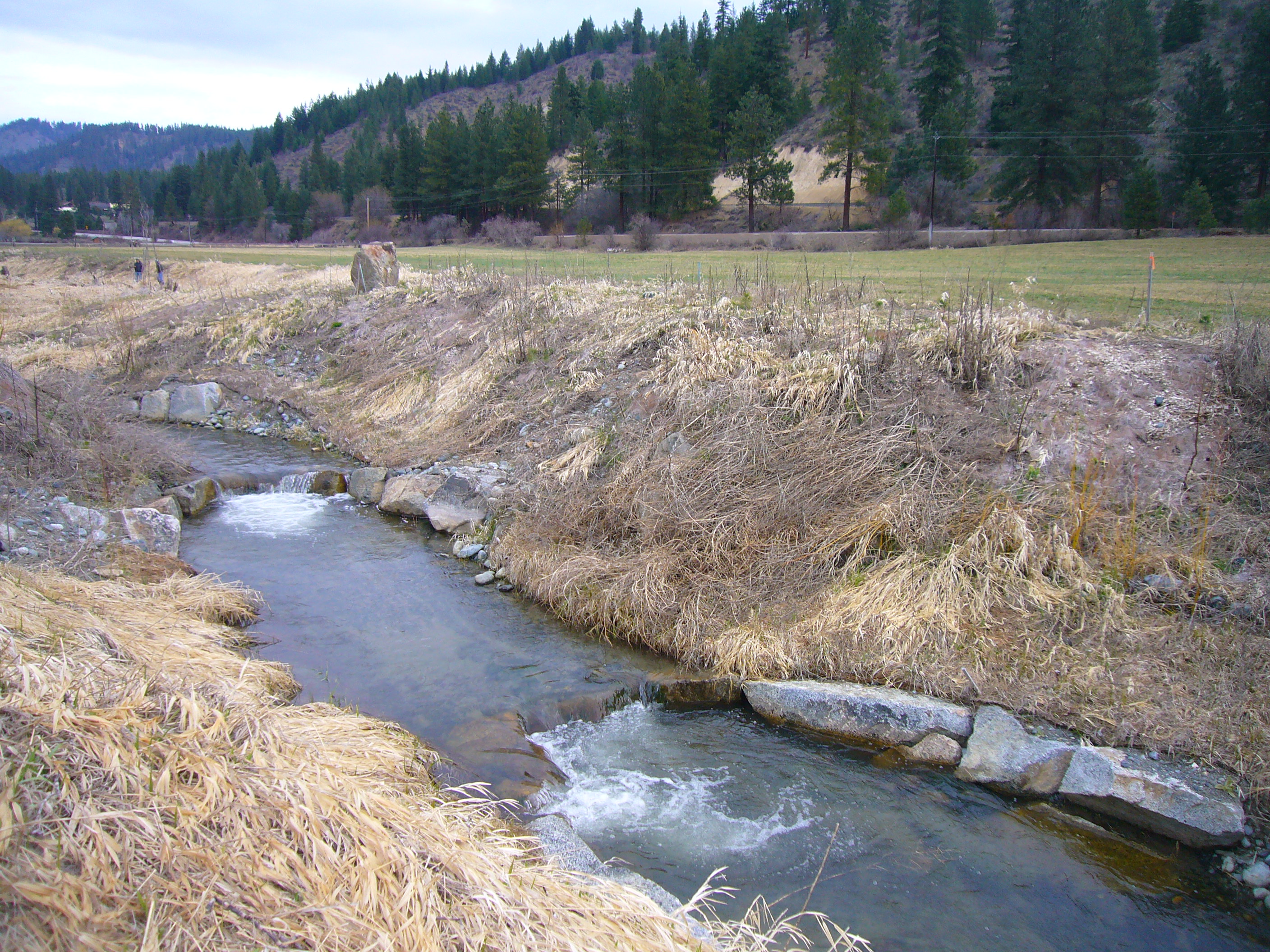

Architectural & Engineering (A&E), Channel structure placement (C.4.d.1), Fishway chutes or pools installed (C.2.d.1), Planting (C.5.c.1), Streambank stabilization (C.4.e.1)
|
$159,173
|
| Total | $517,034 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Saliby (#1)
|
|
Property 1 - Saliby
|
Private
|
Ott/Johnson (#2)
|
|
Property 2 - Johnson/Ott
|
Private
|
Baumann (#3)
|
|
Property 3 - Baumann
|
Private
|
Cann (#4)
|
|
Property 4 - Cann
|
Private
|
Scheibler (#5)
|
|
Property 5 - Scheibler
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Fishway chutes or pools installed (C.2.d.1) |
|
Number Of Fishway Chutes/Pools Installed (C.2.d.2)
|
3
|
Instream Habitat Project |
Channel structure placement (C.4.d.1) |
|
Miles of Stream Treated for channel structure placement (C.4.d.3)
|
0.02
|
|
Pools Created through channel structure placement (C.4.d.5)
|
12
|
|
Number of structures placed in channel (C.4.d.7)
|
18
|
Streambank stabilization (C.4.e.1) |
|
Miles of Streambank Stabilized (C.4.e.3)
|
0.02
|
Riparian Habitat Project |

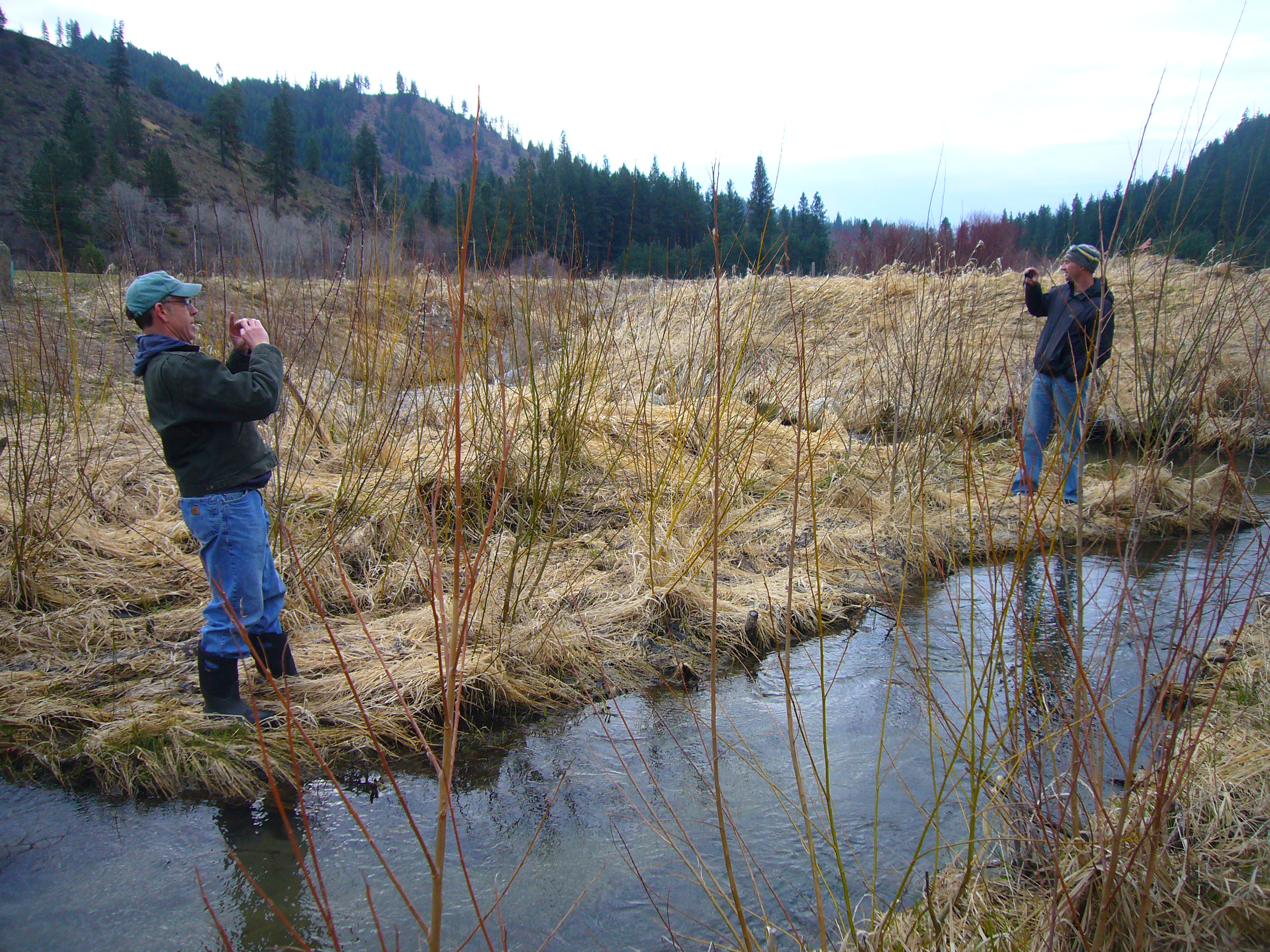

Planting (C.5.c.1) |
|
Acres Planted in riparian (C.5.c.3)
|
1.4
|
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
16
|
Fish Passage Improvement |

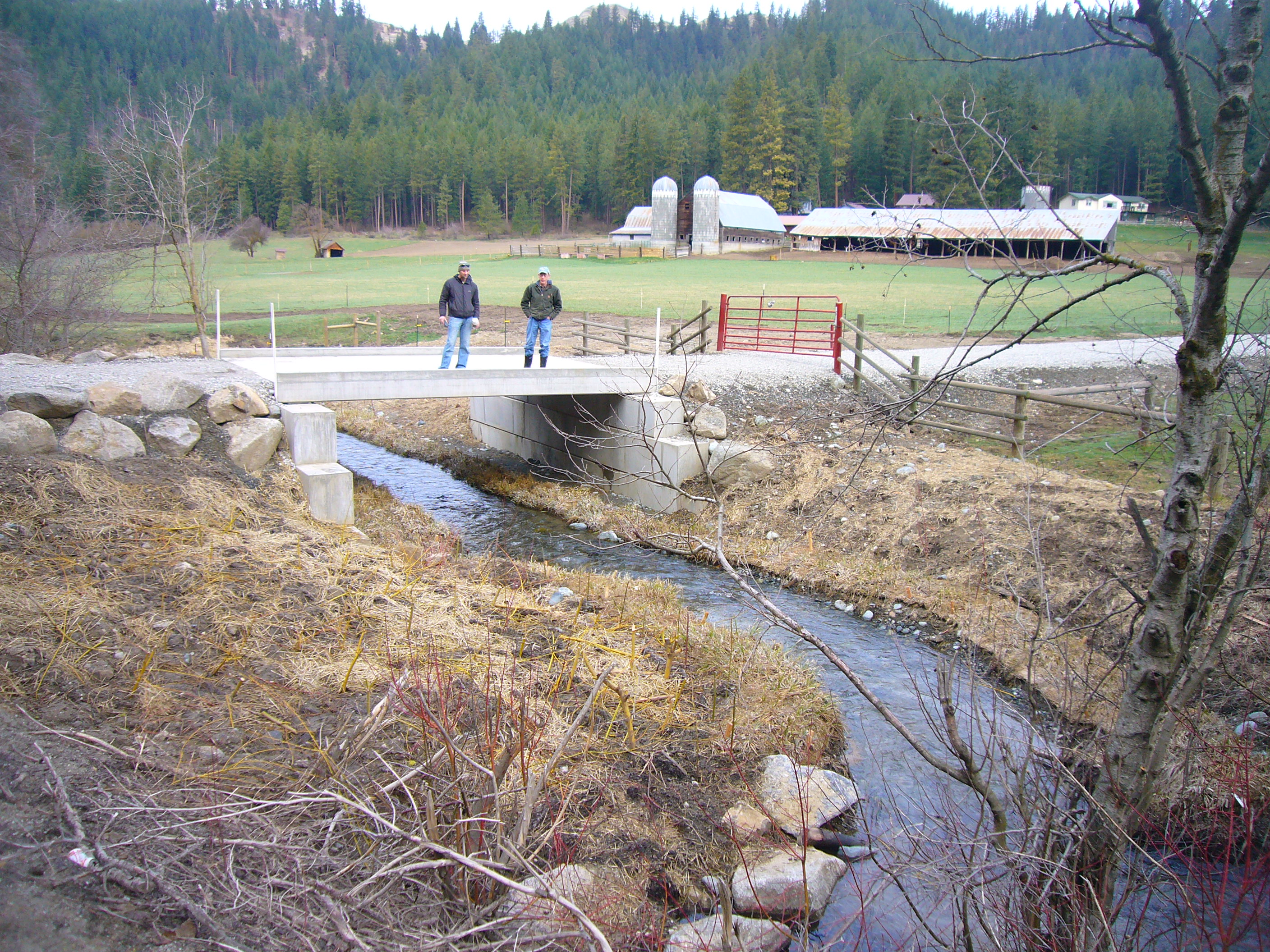

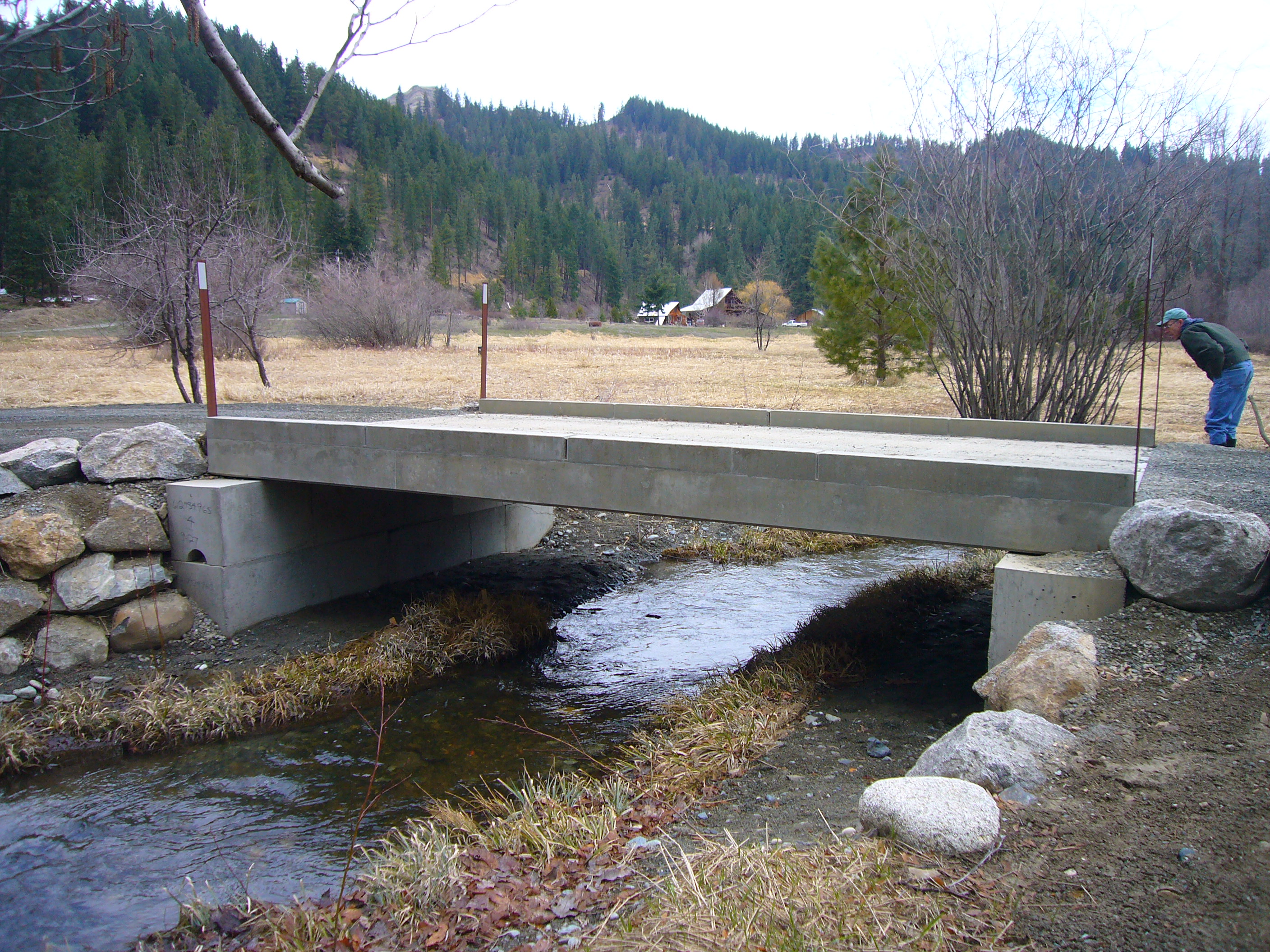

Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
2.50
|
|
Number of bridges (C.2.g.2)
|
4
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
7
|
Milestone Name | Target Date | Description |
Project Start
|
12/08/2011
|
|
Applied for Permits
|
06/08/2012
|
|
Cultural Resources Complete
|
07/31/2012
|
|
Preliminary Design to RCO
|
09/21/2012
|
|
Progress Report Due
|
09/21/2012
|
|
Landowner Agreement to RCO
|
10/01/2012
|
|

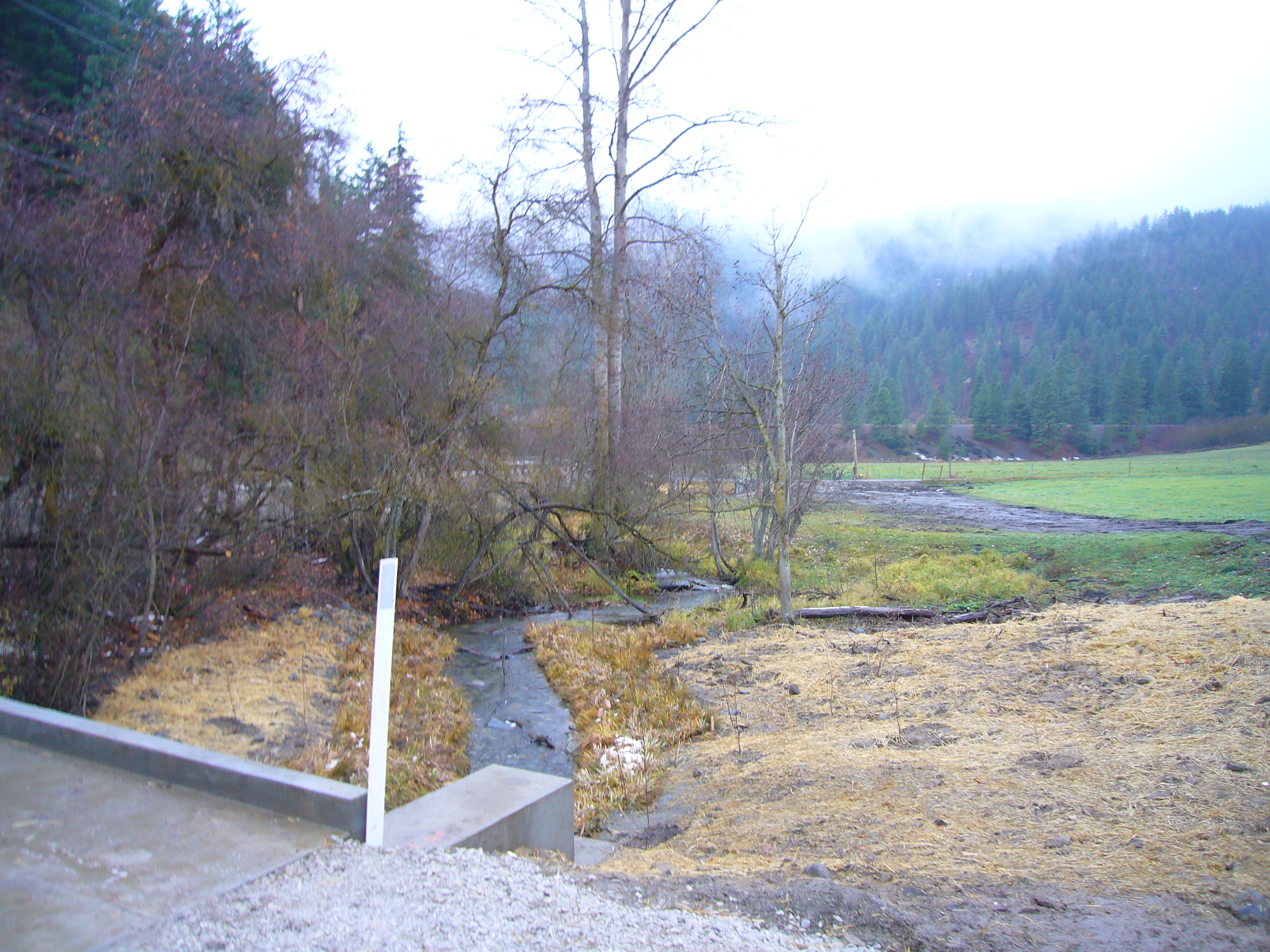

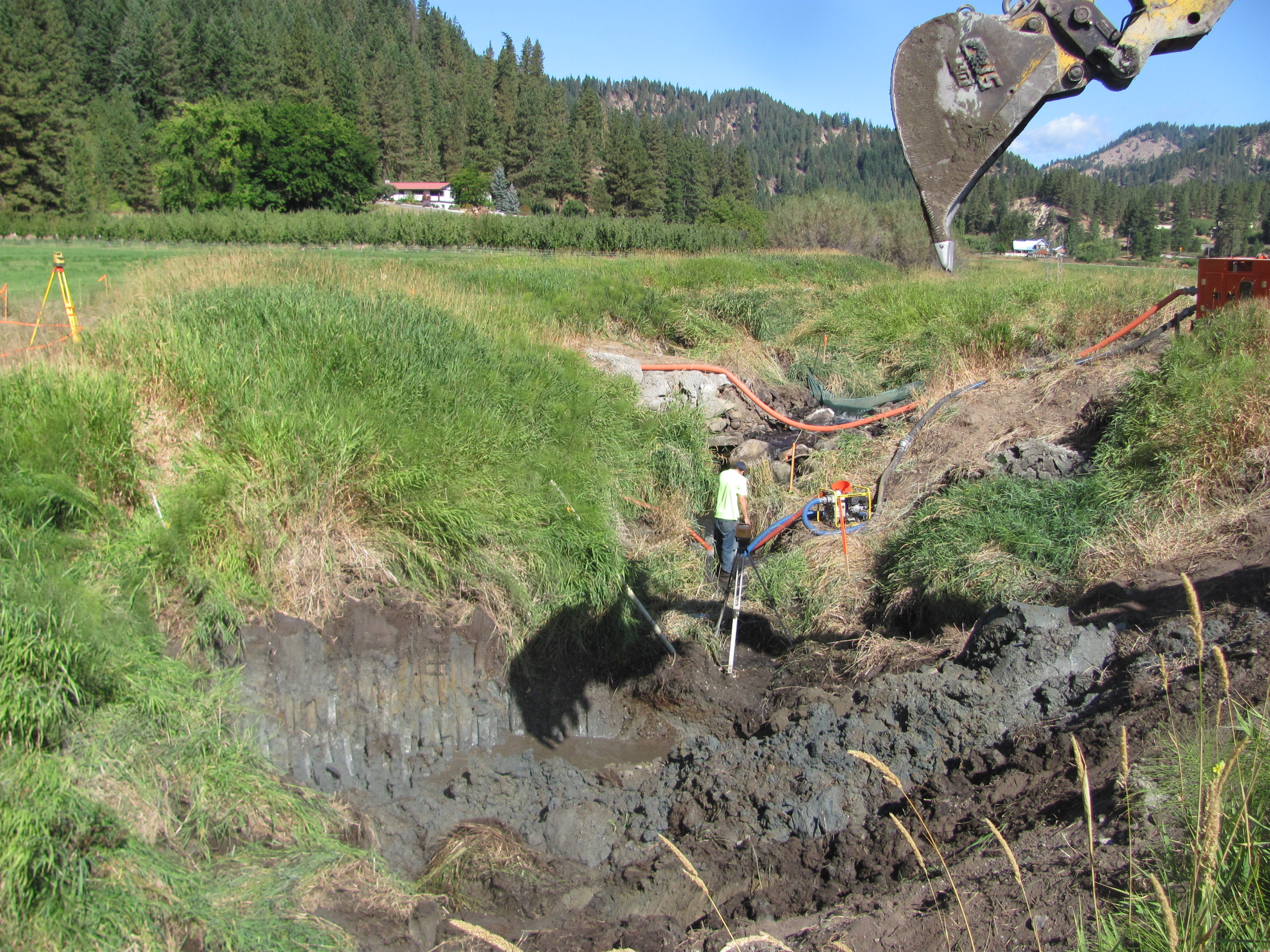

Restoration Started
|
10/01/2012
|
|
Annual Project Billing Due
|
10/31/2012
|
|
Progress Report Due
|
12/31/2012
|
|
Progress Report Due
|
06/30/2013
|
|
Annual Project Billing Due
|
07/31/2013
|
|
Progress Report Due
|
12/31/2013
|
|
Permits Complete
|
04/30/2014
|
|
Progress Report Due
|
06/30/2014
|
|
Bid Awarded/Contractor Hired
|
07/31/2014
|
Final barrier project.
|
Annual Project Billing Due
|
07/31/2014
|
|
RCO Final Inspection
|
11/30/2014
|
|

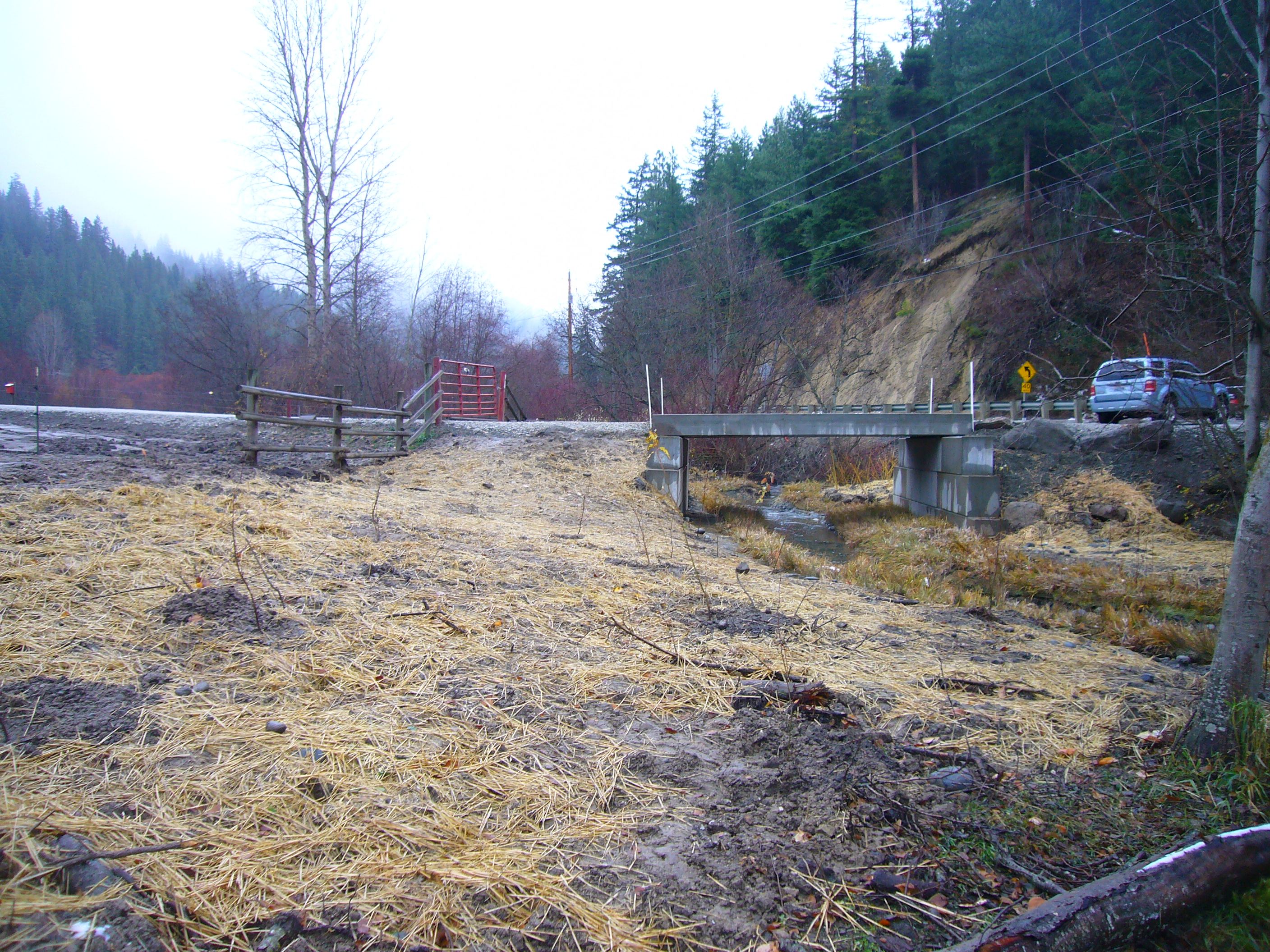

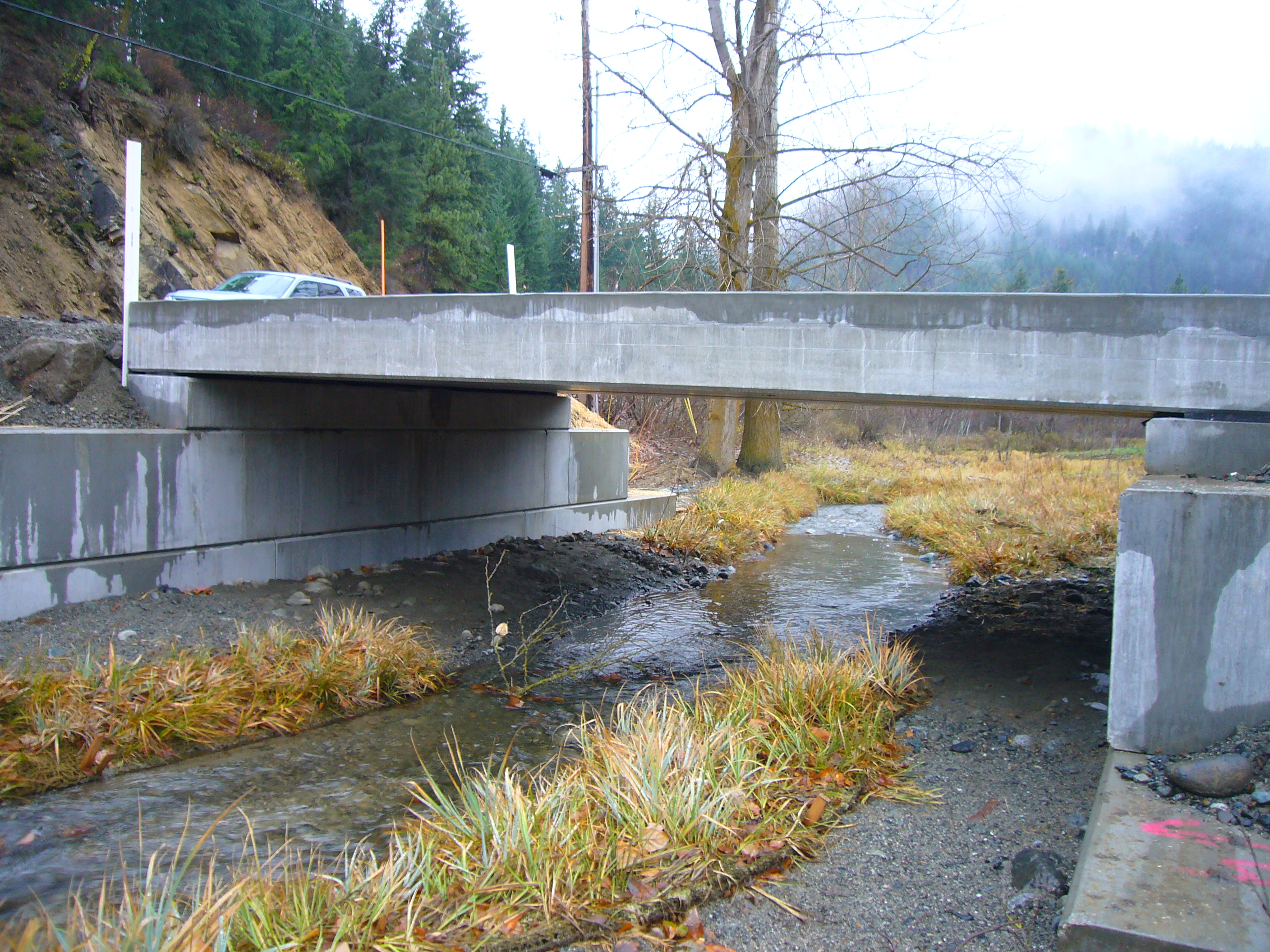

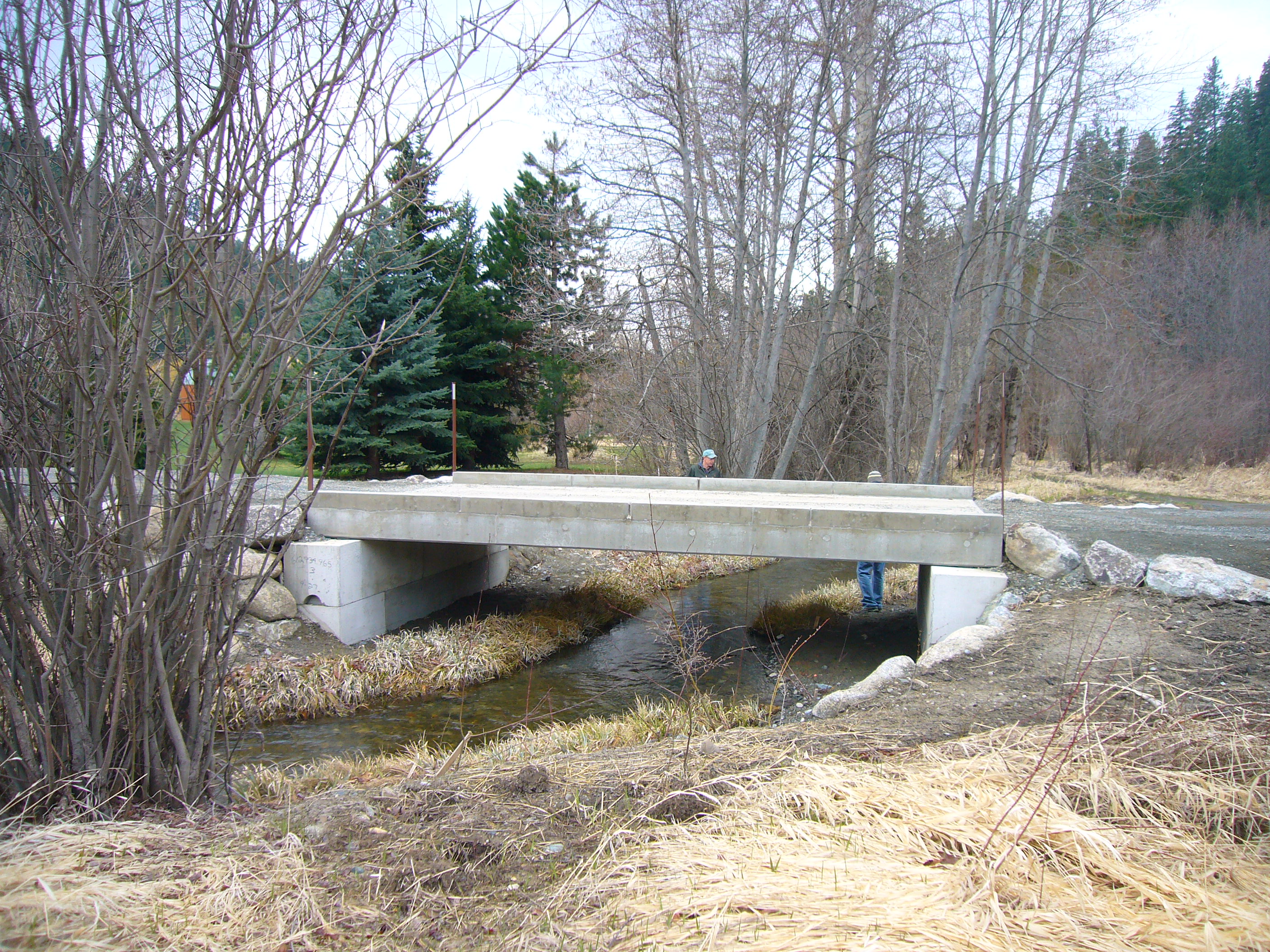

Restoration Complete
|
11/30/2014
|
|
Stewardship Plan to RCO
|
11/30/2014
|
|
Agreement End Date
|
12/31/2014
|
|
Final Design to RCO
|
12/31/2014
|
As-built drawings.
|
Final Report Due
|
03/31/2015
|
|
Final Billing Due
|
03/31/2015
|
|
