Coulter Creek Barrier Replacement
|
Chelan Co Natural Resource; Coulter Creek Barrier Replacement (#11-1347)
05/01/2011, Attachment #125210, Coulter Creek Culverts
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
The project area is within WRIA 45 in the Lower White Pine Reach of Nason Creek as defined in the Lower White Pine Reach Assessment (USBR 2009). The replacement of the barrier culverts at RM 0.4 with a bottomless arch structure would improve Chinook and Steelhead access to 1.6 miles of potential spawning habitat, of which the first 0.3 miles is low gradient rearing habitat. The goal of this action is to increase access to rearing habitat steelhead in Nason Creek and the Wenatchee Subbasin. This project will complement the larger Nason Creek Lower White Pine (LWP) Reconnection that will reconnect 14.9% of the Upper Nason Creek Basin including the reestablishment of hydraulic connectivity to the Coulter Creek drainage to the mainstem Nason Creek.
|
General Area:
|
|
Nason Creek
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Lower Nason
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
11
|
Township:
|
|
T26NR16E
|

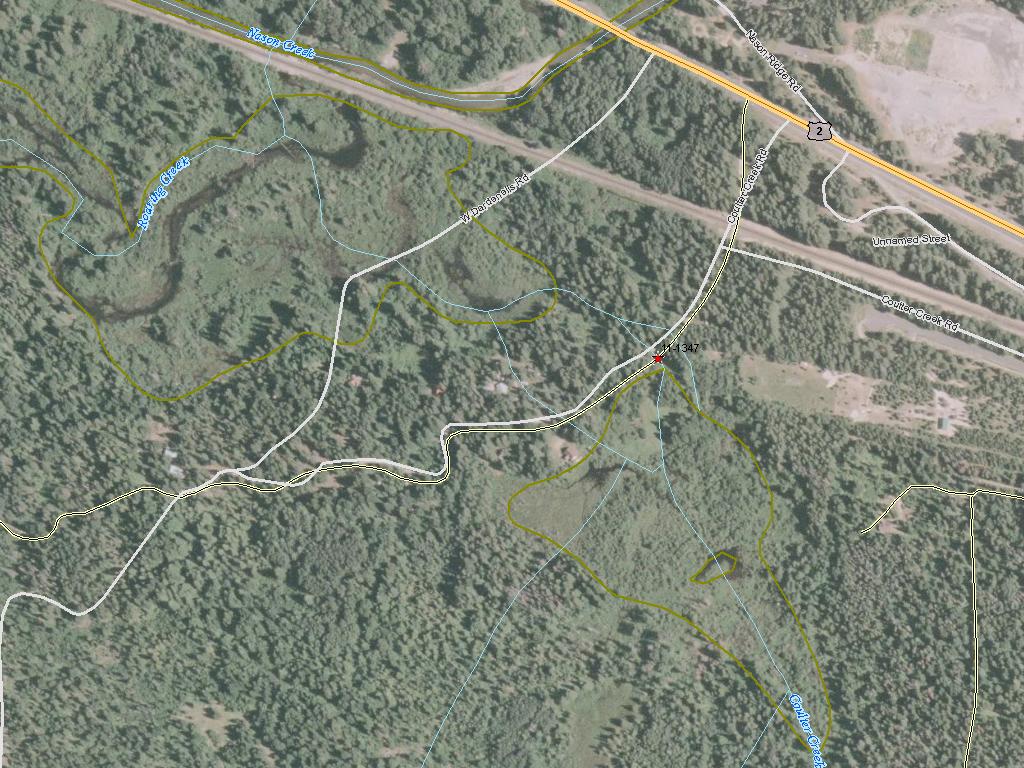

Coordinates:
|
|
47.76567839 -120.80205562
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |

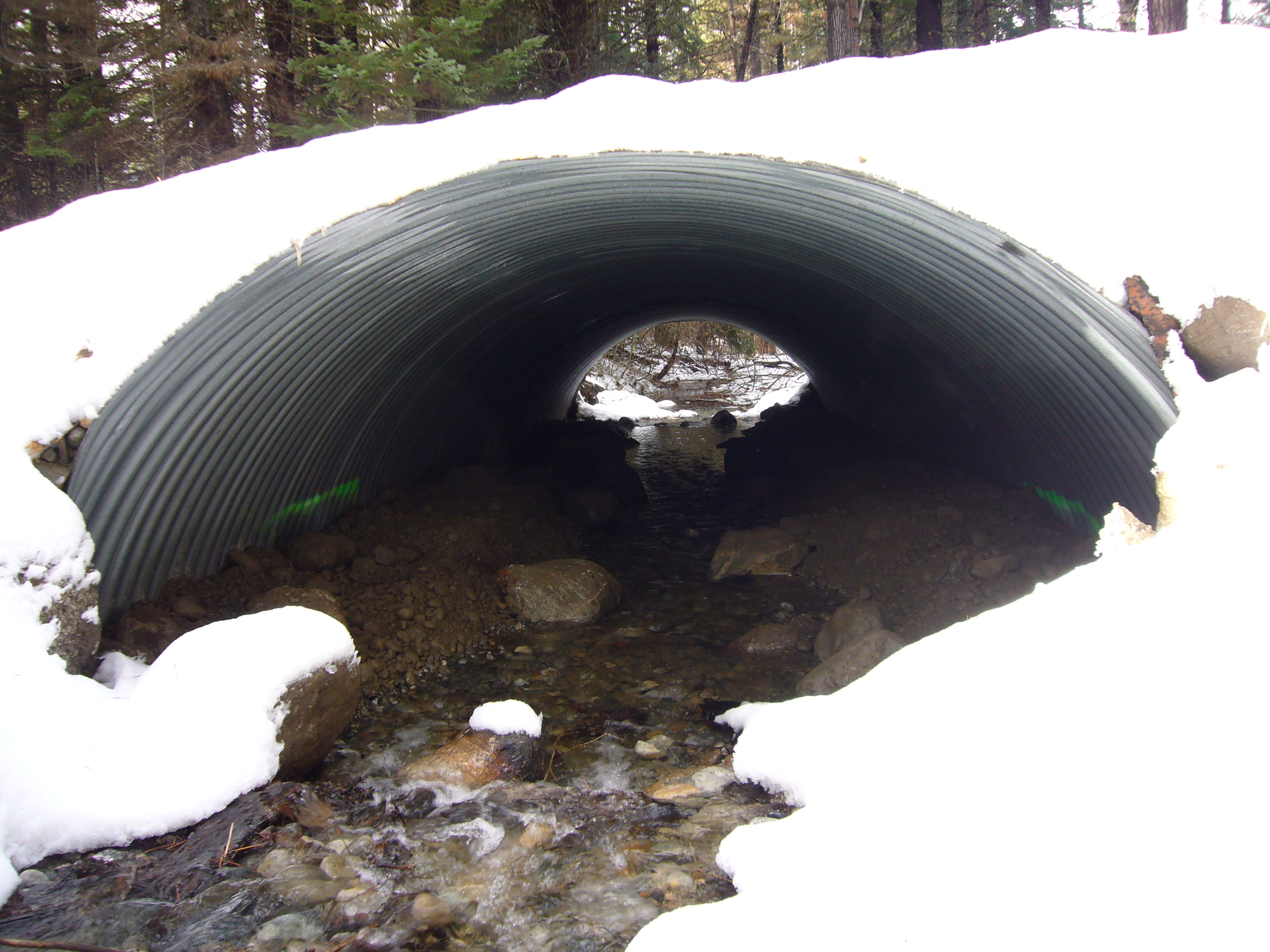

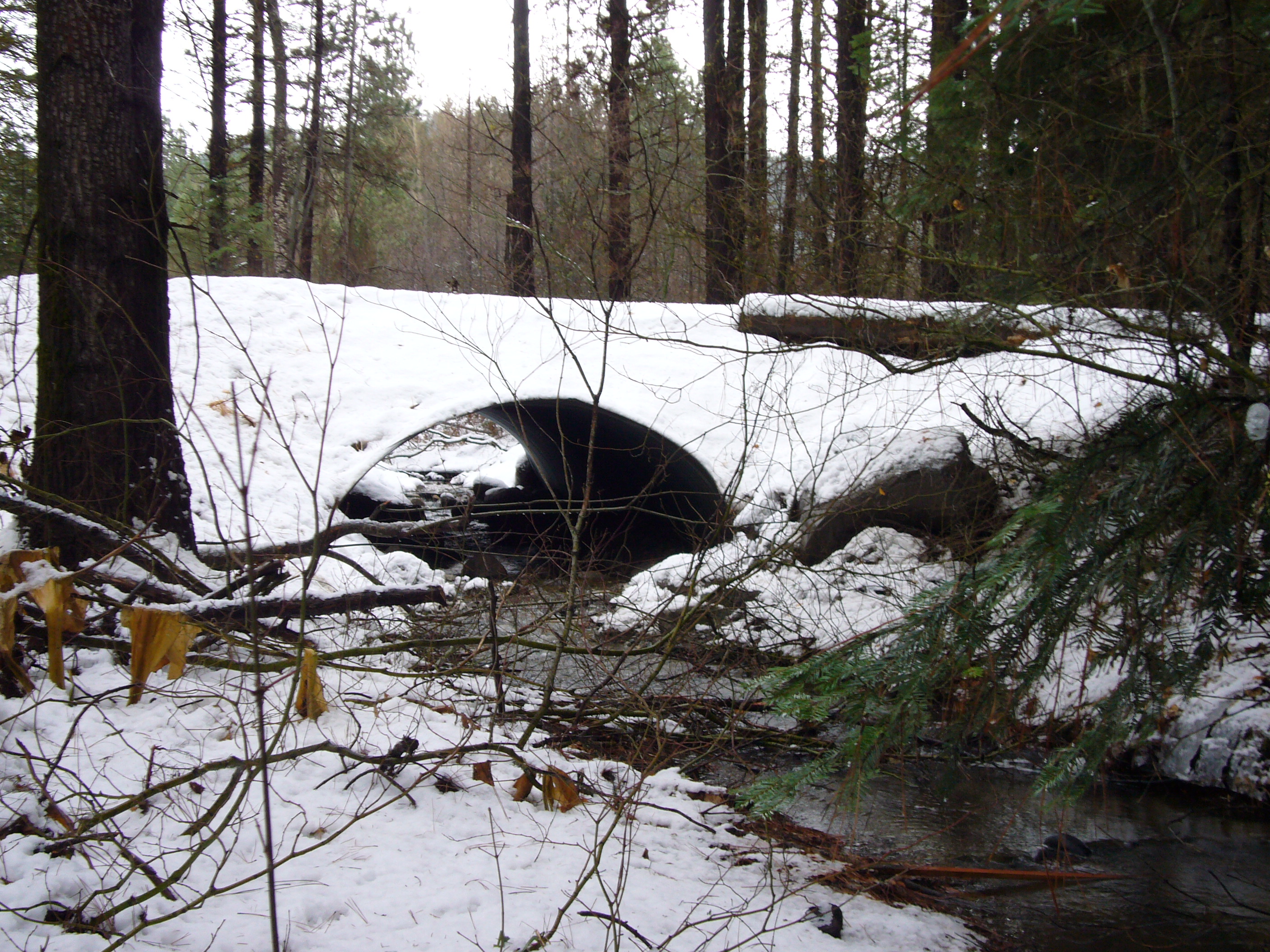

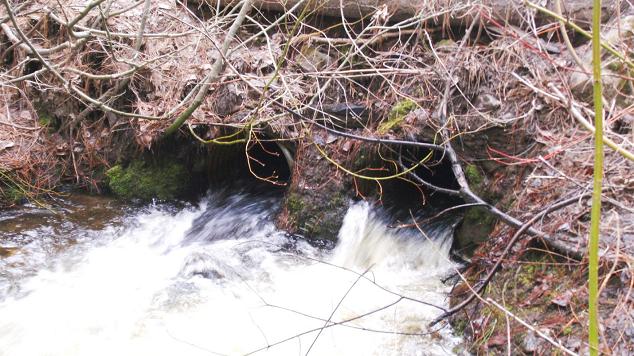

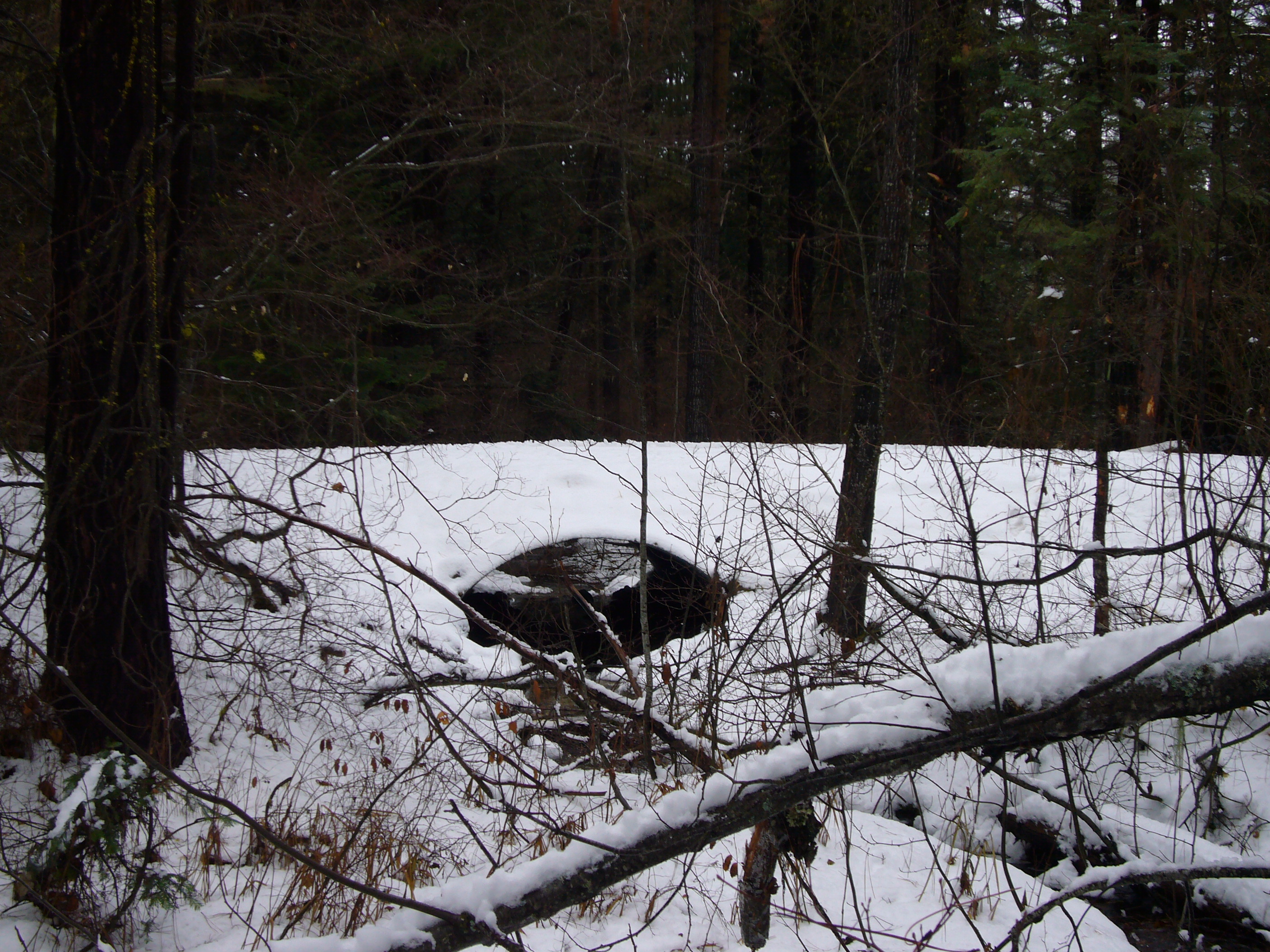

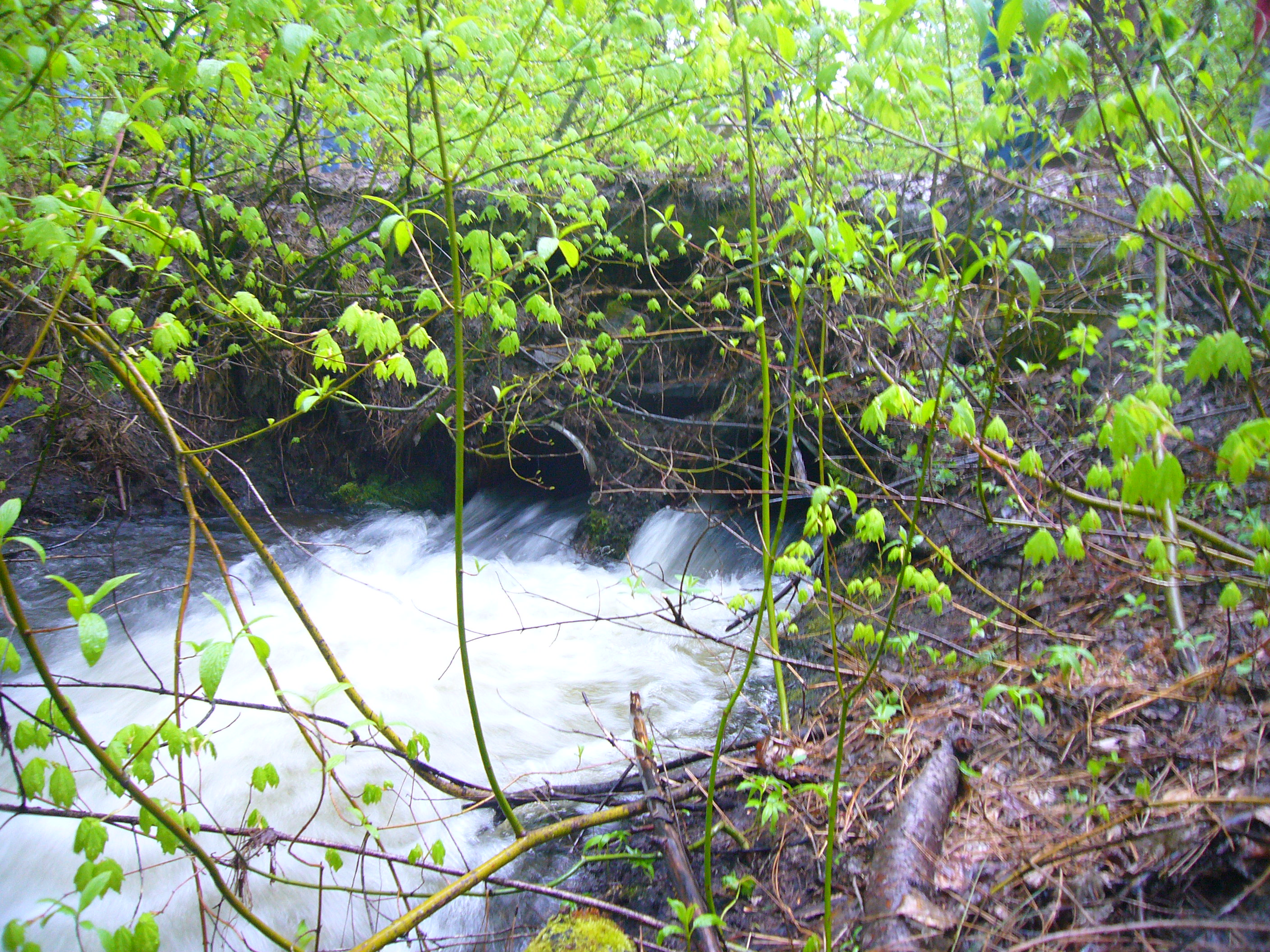

Coulter Creek Culverts (#1)
|
Architectural & Engineering (A&E), Cultural resources, Culvert installed or improved (C.2.f.1), Obtain permits
|
$98,035
|
| Total | $98,035 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Coulter Creek Culverts (#1)
|
|
Property 1 - West Dardenelles Road.
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
6
|
Fish Passage Improvement |
Culvert installed or improved (C.2.f.1) |
|
Miles of stream made accessible by culvert installation/repair (C.2.f.3)
|
1.60
|
|
Number of culverts (C.2.f.2)
|
2
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
1
|
Milestone Name | Target Date | Description |
Project Start
|
12/08/2011
|
|
Progress Report Due
|
06/30/2012
|
|
Annual Project Billing Due
|
10/31/2012
|
|
Progress Report Due
|
12/31/2012
|
|
Progress Report Due
|
06/30/2013
|
|
Annual Project Billing Due
|
07/31/2013
|
|
Progress Report Due
|
12/31/2013
|
|
Progress Report Due
|
06/30/2014
|
|
Applied for Permits
|
07/31/2014
|
|
Permits Complete
|
07/31/2014
|
|
Annual Project Billing Due
|
07/31/2014
|
|
Bid Awarded/Contractor Hired
|
09/30/2014
|
|
Preliminary Design to RCO
|
10/03/2014
|
|
Cultural Resources Complete
|
10/03/2014
|
|
Restoration Started
|
10/20/2014
|
|
RCO Final Inspection
|
11/30/2014
|
|
Restoration Complete
|
11/30/2014
|
|
Landowner Agreement to RCO
|
12/31/2014
|
|
Agreement End Date
|
12/31/2014
|
|
Progress Report Due
|
12/31/2014
|
|
Stewardship Plan to RCO
|
03/31/2015
|
|
Final Report Due
|
03/31/2015
|
|
Final Billing Due
|
03/31/2015
|
|
Final Design to RCO
|
03/31/2015
|
|
