Increase Wood Densities in Asotin IMW Restoration
|
Asotin Co Conservation Dist; Increase Wood Densities in Asotin IMW Restoration (#19-1499)

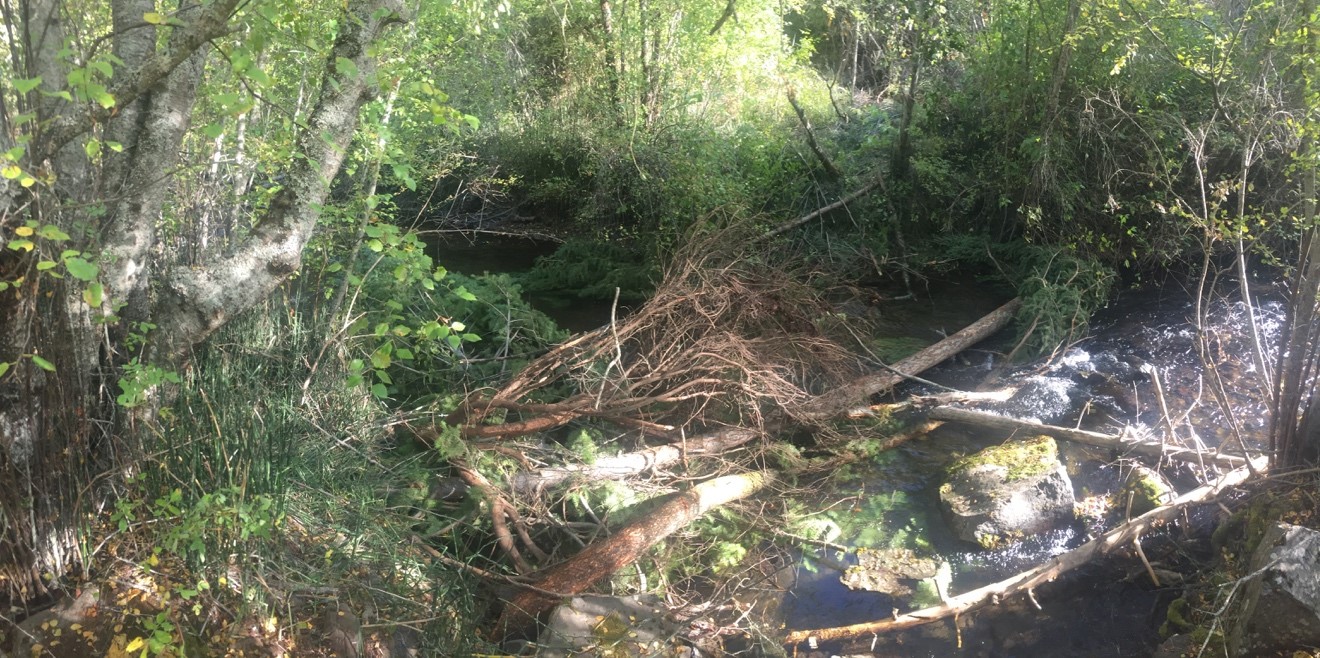

Attachment #389690, PALS_partly intact_postsonly.JPG
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
The Asotin County Conservation District is sponsoring this restoration project to add more wood to sections of Charley Creek, North Fork Asotin Creek, and South Fork Asotin Creek. These creeks are in the Asotin Creek watershed approximately 6 miles south of Clarkston, WA and are part of an Intensively Monitored Watershed project (IMW). The goal of the project is to increase wood density, instream habitat complexity, and floodplain connection which will improve rearing and spawning conditions for wild summer run steelhead. This restoration project should also result in an increase in steelhead productivity and lead to greater understanding of how to improve the efficiency of wood-based stream restoration in small wadeable streams. The project will use monitoring data from the IMW to identify areas where wood density is low and/or where habitat change is limited and target those areas to add more wood. The total area is 9 miles long and we anticipate adding several hundred pieces of wood to each stream using the low-tech process-based restoration method develop in this IMW using post-assisted log structures (PALS) and beaver dam analogs (BDAs).
|
General Area:
|
|
Asotin Creek, Asotin County, WA
|
County:
|
|
Asotin
|
Legislative District:
|
|
09
|
Congressional District 2022:
|
|
05
|
Salmon Recovery Regions:
|
|
Snake River
|
Watershed Administrative Unit:
|
|
NF Asotin Creek
|
Watershed Administrative Unit:
|
|
SF Asotin
|
HUC8:
|
|
Lower Snake-Asotin (17060103)
|
WRIA:
|
|
Middle Snake
|
Sections:
|
|
04
|
Sections:
|
|
15
|
Sections:
|
|
16
|
Township:
|
|
T09NR44E
|
Coordinates:
|
|
46.28616703 -117.30971798
|
|
|
Amounts may not be complete

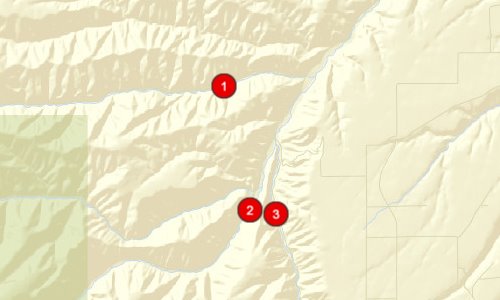

Worksite Name | | Property Name | Landowner Type |
Charley Creek river mile 2.5-5.0 (#1)
|
|
Property 1 - Asotin Wildlife Area 1
|
State Government
|
North Fork Asotin Creek River mile 0.0-2.5 (#2)
|
|
Property 2 - Asotin Wildlife Area 2
|
State Government
|
South Fork Asotin Creek River mile 1.3-5.0 (#3)
|
|
Property 3 - Asotin Wildlife Area 3
|
State Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Instream Habitat Project |
Channel structure placement (C.4.d.1) |
|
Miles of Stream Treated for channel structure placement (C.4.d.3)
|
4.35
|
|
Pools Created through channel structure placement (C.4.d.5)
|
45
|
|
Number of structures placed in channel (C.4.d.7)
|
158
|
Milestone Name | Target Date | Description |
Project Start
|
12/12/2019
|
|
Applied for Permits
|
05/01/2020
|
|
Landowner Agreement to RCO
|
07/01/2020
|
|
Restoration Started
|
07/15/2020
|
|
Progress Report Due
|
07/27/2020
|
|
Preliminary Design to RCO
|
07/31/2020
|
site selection complete and maps attached to PRISM identifying where new structures will be installed and where existing structures need repairs.
|
Cultural Resources Complete
|
07/31/2020
|
State Agency Lead (WDFW Land): Evidence of cultural resources compliance must be submitted to your grants manager, see special condition #1.
|
Annual Project Billing Due
|
07/31/2020
|
|
Permits Complete
|
07/31/2020
|
|
Progress Report Due
|
12/31/2020
|
|
Progress Report Due
|
06/30/2021
|
|
Annual Project Billing Due
|
06/30/2021
|
|
Funding Acknowl Sign Posted
|
09/30/2021
|
|
Progress Report Due
|
12/31/2021
|
|
Progress Report Due
|
06/30/2022
|
|
Annual Project Billing Due
|
06/30/2022
|
|
Progress Report Due
|
12/31/2022
|
|
Progress Report Due
|
06/30/2023
|
|
Annual Project Billing Due
|
06/30/2023
|
|
RCO Final Inspection
|
09/15/2023
|
|
Restoration Complete
|
09/30/2023
|
|
Special Conditions Met
|
12/01/2023
|
as-built designs and maps attached to PRISM. Maps include new structure locations and types, and restored structure location and type.
|
Final Report Due
|
12/31/2023
|
Sponsor completes and submits the RCO PRISM final report.
|
Agreement End Date
|
12/31/2023
|
|
Final Billing Due
|
03/31/2024
|
|
