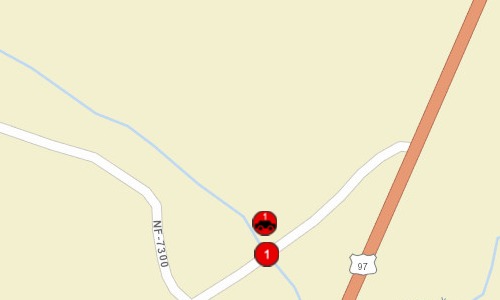

Mill Creek Fish Passage Improvement
|
Chelan Co Natural Resource; Mill Creek Fish Passage Improvement (#18-1824)
Attachment #352219, Fromm matress-Mill Cr 056.jpg
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
This project will complete design, permitting and replace a fish passage barrier culvert on Mill Creek, a tributary to Peshastin Creek, just off U.S. Highway 97. The proposed project is located at approximately RM 5.2 on Peshastin Creek and will open 2.2 miles of perennial stream providing access to spawning and rearing habitat for ESA-listed steelhead trout. The proposal is to replace the existing 4'x5' box culvert with a 21' span arch culvert. The proposed match is from the Washington State Brian Abbott Fish Barrier Removal Board.
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Mt Stuart
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
06
|
Township:
|
|
T23NR18E
|
Coordinates:
|
|
47.51101817 -120.63228230
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Mill Creek crossing (#1)
|
Agency Indirect, Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Obtain permits
|
$614,980
|
| Total | $614,980 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Mill Creek crossing (#1)
|
|
Property 1 - Mill Creek crossing
|
Local Government
|
Mill Creek crossing (#1)
|
|
Property 2 - John Smith
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
2
|
Fish Passage Improvement |
Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
2.20
|
|
Number of bridges (C.2.g.2)
|
1
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
2
|
Milestone Name | Target Date | Description |
Project Start
|
12/05/2018
|
|
Annual Project Billing Due
|
07/31/2019
|
|
Progress Report Due
|
08/01/2019
|
|
Applied for Permits
|
09/30/2019
|
|
Preliminary Design to RCO
|
11/30/2019
|
RCO will coordinate design review with WDFW, per Manual 18, Appendix D-2, and Manual 22, Appendix C-2.
|
Progress Report Due
|
02/01/2020
|
|
Cultural Resources Complete
|
04/30/2020
|
Evidence of compliance with Section 106 required.
|
Bid Awarded/Contractor Hired
|
05/31/2020
|
|
Final Design to RCO
|
06/01/2020
|
Per Manual 18, Appendix D-3, and Manual 22, Appendix C-3.
|
Landowner Agreement to RCO
|
06/15/2020
|
|
Restoration Started
|
07/20/2020
|
|
Annual Project Billing Due
|
07/31/2020
|
|
Progress Report Due
|
08/01/2020
|
|
Restoration Complete
|
08/31/2020
|
50%
|
Restoration Complete
|
09/30/2020
|
90%
|
RCO Final Inspection
|
10/12/2020
|
10-12-2020
|
RCO Final Inspection
|
10/31/2020
|
|
Restoration Complete
|
11/30/2020
|
100%
|
Progress Report Due
|
02/01/2021
|
|
Annual Project Billing Due
|
07/31/2021
|
|
Progress Report Due
|
08/01/2021
|
|
Funding Acknowl Sign Posted
|
10/31/2021
|
|
Stewardship Plan to RCO
|
10/31/2021
|
|
Agreement End Date
|
12/31/2021
|
|
Final Report Due
|
03/31/2022
|
|
Final Design to RCO
|
03/31/2022
|
As-built
|
Final Billing Due
|
03/31/2022
|
|
Attachment Type | Attachment Title | Attach Date |
Agreement - State
|
18-1824 Agreement.pdf
|
04/02/2019
|
Amendment - State
|
18-1824 Amend #1 Cost Change.pdf
|
07/22/2019
|
Amendment request
|
Final Mill Creek 18-1824 Cost Increase Approved TPJ.pdf.pdf
|
09/08/2020
|
Applicant Resolution/Authorizations
|
SRFB application authorization form[44501].pdf.pdf
|
08/07/2018
|
Application Review Report
|
Application Review Report, 18-1824R(compl 08/27/18 08:15:09).pdf
|
08/27/2018
|
Correspondence
|
Signature Authority per OGM.pdf
|
03/21/2019
|
Cost Estimate
|
Final Construction Cost Estimate.pdf.pdf
|
04/27/2020
|
Cost Estimate
|
MillCr_fbrb cost estimate spreadsheet_102218_revised_final(4.xlsx
|
10/22/2018
|
Cost Estimate
|
MillCr_fbrb cost estimate spreadsheet_062718_final.xlsx.xlsx
|
06/29/2018
|
Design document
|
CCNRD - Smith Fall 2021_Final Order.pdf.pdf
|
07/02/2021
|
Design document
|
2673-Contech Mill Creek BridgeCor Submittal.pdf.pdf
|
06/24/2020
|
Design document
|
Mill_Cr_BoD_Final.pdf.pdf
|
04/27/2020
|
Design document
|
Mill Creek Culvert - Final Plans - Stamped.pdf.pdf
|
04/27/2020
|
Design document
|
Mill Creek Restoration 05-08-2019.pdf.pdf
|
02/11/2020
|
Design document
|
Mill Creek - Upstream Weir Images.docx.docx
|
02/11/2020
|
Design document
|
Appendix C - Draft Geotechnical Report 07-09-19.pdf
|
08/05/2019
|
Design document
|
Appendix B - 60% Construct Cost Estimate 08-01-19.pdf
|
08/05/2019
|
Design document
|
Appendix D - Barrier Assessment Forms 04-15-19.pdf
|
08/05/2019
|
Design document
|
Appendix E - Bankfull Width Measurements 08-01-19.pdf
|
08/05/2019
|
Design document
|
60% Basis of Design Report - August 2019.pdf
|
08/05/2019
|
Design document
|
Appendix A - 60% Design Drawings 07-31-19.pdf
|
08/05/2019
|
Design document
|
Mill_Creek_30%_Plans[37415].pdf.pdf
|
06/29/2018
|
Design document (as built)
|
Mill Creek Culvert - As Builts.pdf.pdf
|
11/13/2020
|
Final project report
|
Final Report, 18-1824 (accepted 12/13/21 09:10:18).pdf
|
12/13/2021
|
Inspection Photos
|
MillCk RepeatPhotos-PostCon_July2021.pdf.pdf
|
08/06/2021
|
Inspection Photos
|
10-12-2020 Final Inspection Photos.pdf.pdf
|
10/21/2020
|
Inspection Photos
|
MillCk RepeatPhotos-PostCon.pdf.pdf
|
09/30/2020
|
Inspection Photos
|
MillCk RepeatPhotos-PreCon-reduced.pdf.pdf
|
06/18/2020
|
Inspection Report
|
Inspection Report, #2525 (Accepted 10/21/20 13:15:19).pdf
|
10/21/2020
|
Map: Restoration Worksite
|
site map.pdf.pdf
|
06/29/2018
|
Permit
|
NWS-2019-1055_11.13.4.2.NWP-VerifLtr-v20200617.pdf.pdf
|
09/15/2020
|
|

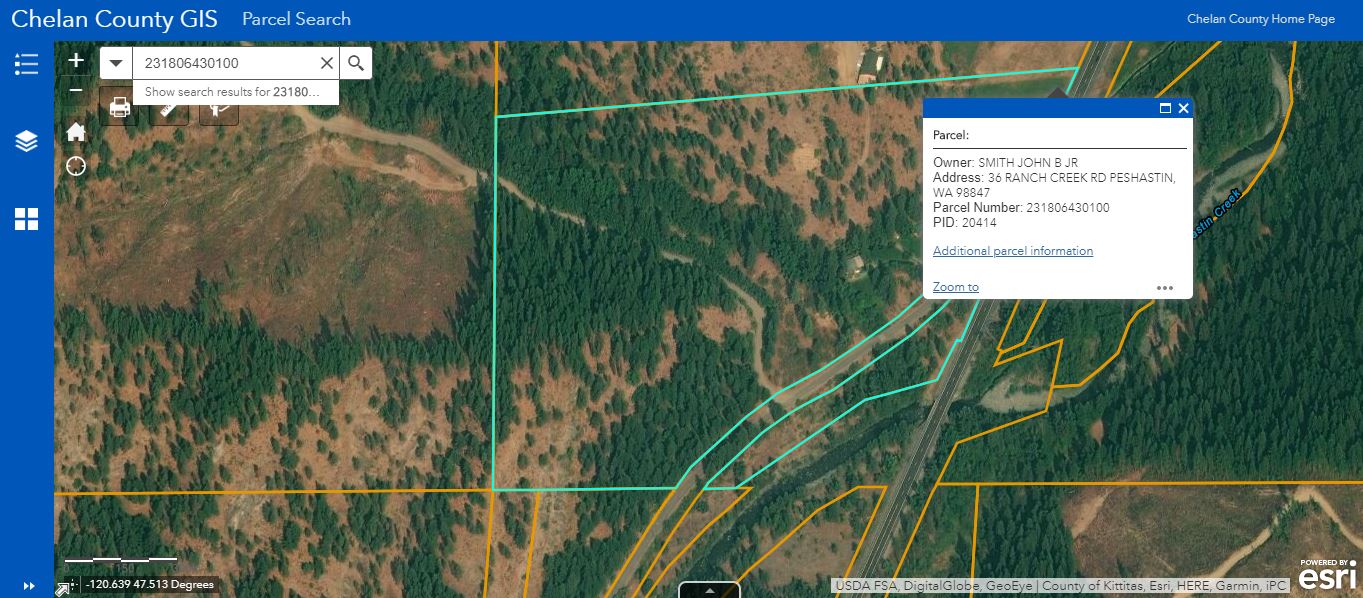

Smith - Mill Creek Parcel.jpg
|
02/28/2020
|
|
Fromm matress-Mill Cr 051.jpg.jpg
|
06/29/2018
|
|
Fromm matress-Mill Cr 056.jpg.jpg
|
06/29/2018
|
Progress report
|
Progress Report, 18-1824 (accepted 07/12/21 08:29:49).pdf
|
07/12/2021
|
Progress report
|
Progress Report, 18-1824 (accepted 03/12/21 07:20:05).pdf
|
03/12/2021
|
Progress report
|
Progress Report, 18-1824 (accepted 07/07/20 20:35:34).pdf
|
07/07/2020
|
Progress report
|
Progress Report, 18-1824 (accepted 01/27/20 12:46:16).pdf
|
01/27/2020
|
Progress report
|
Progress Report, 18-1824 (accepted 07/23/19 15:39:13).pdf
|
07/23/2019
|
Progress report
|
Progress Report, 18-1824 (accepted 04/23/19 13:29:31).pdf
|
04/23/2019
|
Project Application Report
|
Application Report, 18-1824R (submitted 08/07/18 15:24:42).pdf
|
08/07/2018
|
Salmon Project Proposal
|
FBRB Final App. Mill Creek Fish Passage[41360].pdf
|
05/30/2019
|
Salmon Project Proposal
|
MillCreekFinal_Proposal_NMI_withTrack 10-11-18.pdf
|
10/22/2018
|
Salmon Project Proposal
|
MillCreekFinal_Proposal_without_track_compilied[42669].pdf.pdf
|
06/29/2018
|
Salmon Project Proposal
|
MillCreekFInal_Proposal_WITH_track_compiled[42668].pdf.pdf
|
06/29/2018
|
SRFB Review Panel Comment Form
|
Final SRFB Review Panel Comment Form.pdf
|
12/28/2018
|
SRFB Review Panel Comment Form
|
Response to NMI_RP Comment Form 10-11-18 MK (1).docx
|
10/22/2018
|
WDFW barrier & screening forms
|
602260_Report_FBRB_barrier_survey.pdf.pdf
|
06/29/2018
|
WDFW barrier & screening forms
|
040089[41362].pdf.pdf
|
06/29/2018
|
WDFW barrier & screening forms
|
Correction Analysis Form_Mill_Creek.docx.docx
|
06/29/2018
|
