Riparian Restoration - IMW Study Area
|
    Funding |
  |
|
    Links |
  |
|
|

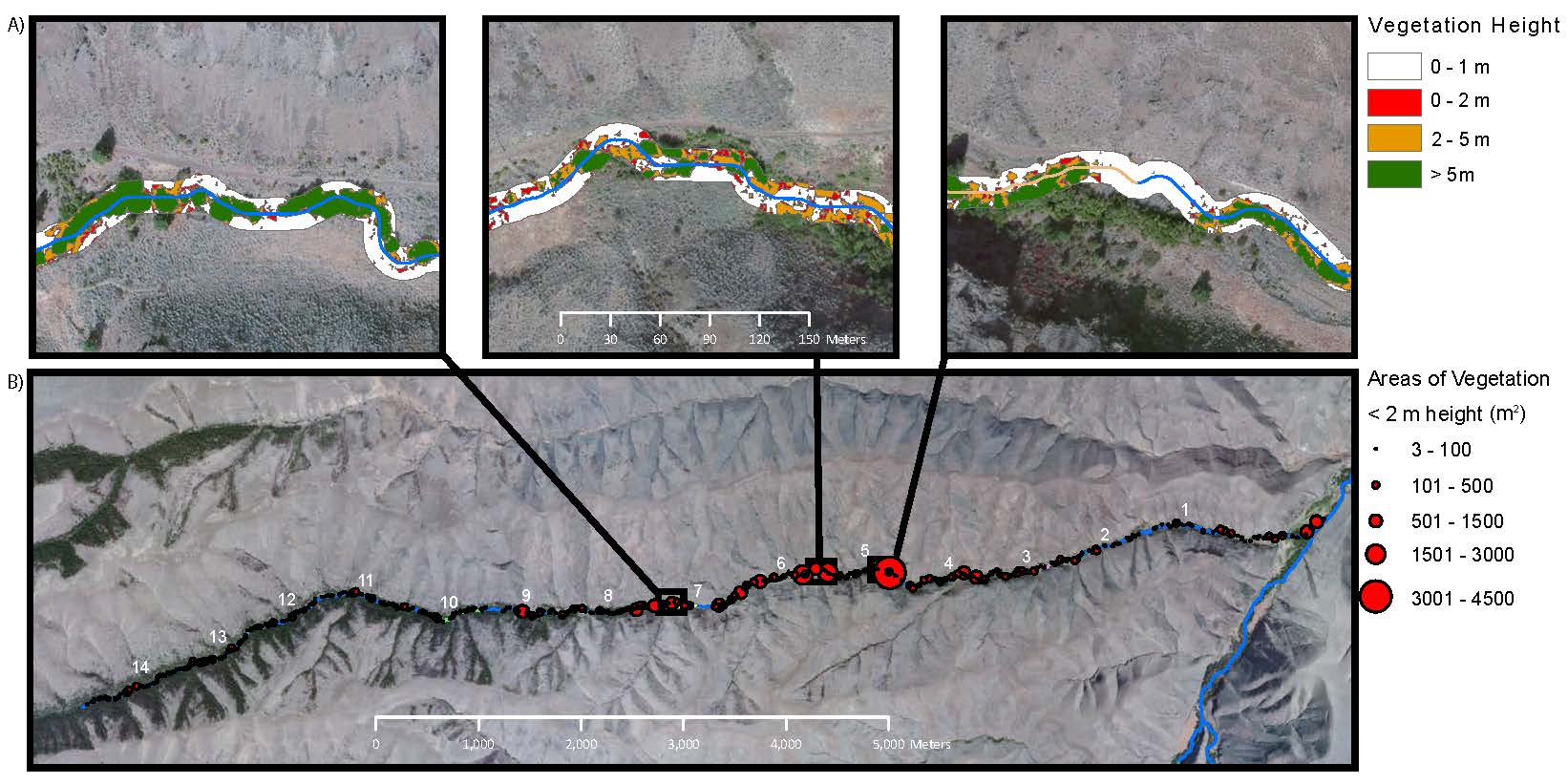

The Asotin Co Conservation District propose to complete a riparian restoration plan on 17 km of Asotin Creek and its tributaries and plant ~ 8.9 km of the highest priority acres. The stream supports wild steelhead and is located within the Asotin Creek Intensively Monitored Watershed (IMW). The project focuses on 3 tributaries in the upper watershed: Charley, North Fk Asotin & South Fk Asotin. The primary limiting factor identified in the IMW is limited riparian function (e.g., temperature, habitat quantity and quality). The goal of other restoration work being conducted in the IMW is to improve riparian function by increasing channel-floodplain connectivity. This project supports that goal by speeding the recovery of a more natural and native vegetation community as riparian conditions improve. The focus areas will be the lower 8 km of Charley, the lower 3 km of North Fk Asotin, and 6 km of South Fk Asotin. This project will identify priority riparian planting areas, develop a riparian restoration plan, and promote long-term riparian function by controlling weeds and planting native tree species. Target tree species include Douglas-fir, ponderosa pine, and cottonwood that achieve a large enough size that, when they fall into the stream or floodplain area, have the ability to influence channel dynamics and increase the diversity of habitats available for all freshwater life stages of steelhead and other fish species using Asotin Creek. This is the final phase of the IMW Restoration.
|
General Area:
|
|
The focus areas will be the lower 8 km of Charley, the lower 3 km of NF Asotin, and 6 km of SF Asotin Cr.
|
County:
|
|
Asotin
|
Legislative District:
|
|
09
|
Congressional District 2022:
|
|
05
|
Salmon Recovery Regions:
|
|
Snake River
|
Watershed Administrative Unit:
|
|
NF Asotin Creek
|
HUC8:
|
|
Lower Snake-Asotin (17060103)
|
WRIA:
|
|
Middle Snake
|
Sections:
|
|
09
|
Township:
|
|
T09NR44E
|
Coordinates:
|
|
46.27814503 -117.29415198
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Asotin Cr IMW (#1)
|
Architectural & Engineering (A&E), Cultural resources, Planting (C.5.c.1), Riparian Plant removal / control (C.5.h.1)
|
$71,252
|
| Total | $71,252 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Asotin Cr IMW (#1)
|
|
Property 1 - Charley Creek
|
State Government
|
Asotin Cr IMW (#1)
|
|
Property 2 - South Fork Asotin
|
State Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Riparian Habitat Project |
Planting (C.5.c.1) |
|
Acres Planted in riparian (C.5.c.3)
|
7.3
|
Riparian Plant removal / control (C.5.h.1) |
|
Acres of riparian treated for plant removal/control (C.5.h.3)
|
20.0
|
Planting (C.5.c.1) |
|
Miles of streambank planted (C.5.c.4)
|
1.16
|
Riparian Plant removal / control (C.5.h.1) |
|
Miles of streambank treated for plant removal/control (C.5.h.4)
|
1.16
|
Planting (C.5.c.1) |
|
Average Riparian Width
|
170
|
Milestone Name | Target Date | Description |
Project Start
|
12/04/2013
|
|
Special Conditions Met
|
04/30/2014
|
Review Panel Condition, as per agreement special condition #1
|
Progress Report Due
|
06/30/2014
|
entered directly into PRISM
|
Annual Project Billing Due
|
07/31/2014
|
and at least once per year, thereafter
|
Progress Report Due
|
02/12/2015
|
entered directly into PRISM
|
Preliminary Design to RCO
|
02/13/2015
|
Refer to agreement special condition #3 for minimum design deliverables
|
Final Design to RCO
|
05/01/2015
|
Refer to agreement special condition #3 for minimum design deliverables
|
Cultural Resources Complete
|
06/09/2015
|
RCO to complete consultation through EO-05-05. Consultation must be complete prior to initiating ground disturbance.
|
Progress Report Due
|
06/30/2015
|
entered directly into PRISM
|
Landowner Agreement to RCO
|
07/15/2015
|
|
Annual Project Billing Due
|
07/31/2015
|
|
Restoration Started
|
09/01/2015
|
Site prep including rototilling, laying fabric
|
Bid Awarded/Contractor Hired
|
11/15/2015
|
spring 2016 planting
|
Progress Report Due
|
11/30/2015
|
entered directly into PRISM
|
Restoration Started
|
03/15/2016
|
spring planting
|
Restoration Complete
|
04/15/2016
|
spring planting
|
Progress Report Due
|
07/31/2016
|
entered directly into PRISM
|
Annual Project Billing Due
|
07/31/2016
|
|
Final Design to RCO
|
08/31/2016
|
Including as-built planting documentation (as per agreement special condition #3), weed management plan, and watering plan.
|
Funding Acknowl Sign Posted
|
12/31/2016
|
RCO has small metal signs available for use upon request
|
Progress Report Due
|
06/30/2017
|
entered directly into PRISM
|
Annual Project Billing Due
|
07/31/2017
|
|
RCO Final Inspection
|
09/30/2017
|
|
Agreement End Date
|
01/31/2018
|
Maintenance complete. PROJECT CLOSING. All expenditures must be prior to this date.
|
Final Billing Due
|
02/28/2018
|
|
Final Report Due
|
03/31/2018
|
|
