Mill Creek Culvert Replacement Mtn Home Ranch Rd
|
Chelan Co Natural Resource; Mill Creek Culvert Replacement Mtn Home Ranch Rd (#12-1620)
Attachment #149756, Mill Creek Culvert
|
|
|
    Funding |
  |
Salmon Federal Projects:
|
$34,286
|
|
Total RCO Grant:
|
$34,286
|
(69%)
|
Sponsor Match:
|
$15,184
|
(31%)
|
Total Agreement:
|
$49,470
|
(100%)
|
|
    Links |
  |
|
|

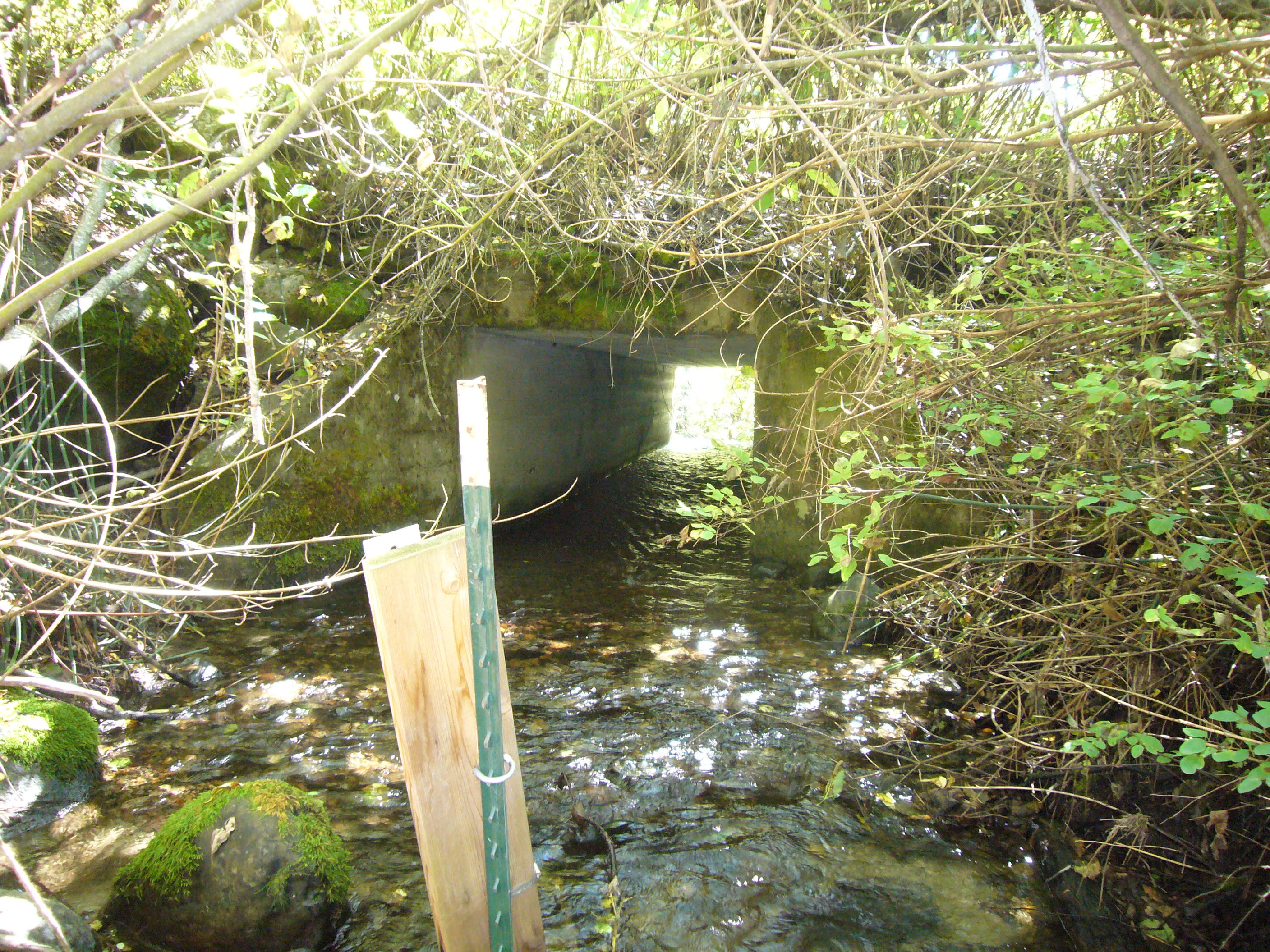

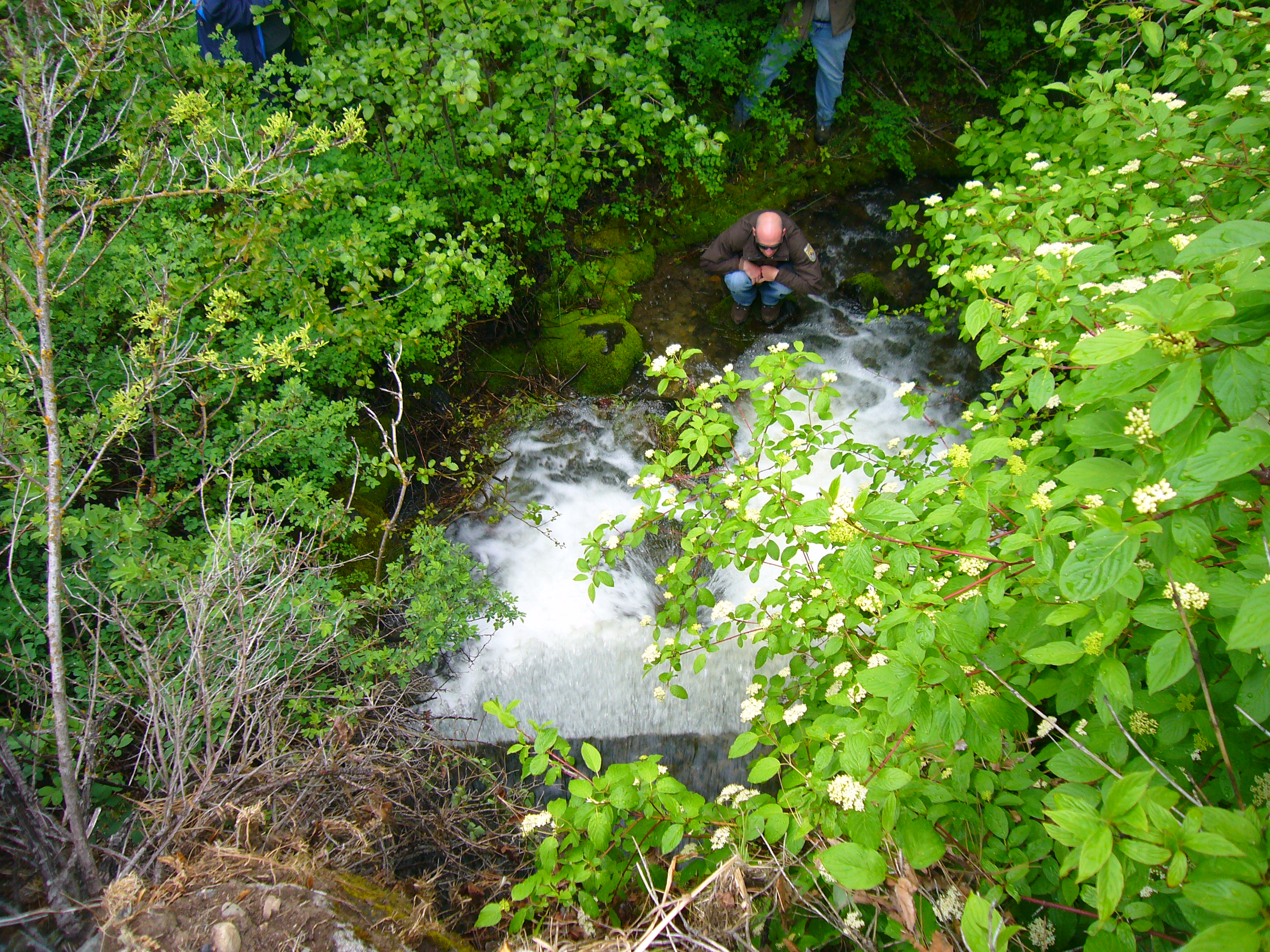

The objective of the Mill Creek Passage project is to open 2.2 miles of perennial stream to provide access to spawning and rearing habitat on Mill Creek. Mill creek is a tributary to Peshastin Creek near RM 5.2. Currently, a 4’x5’ box culvert with a 1.5% slope and 2’ outfall drop at RM 0.1 on Mill Creek creates a complete barrier to fish passage. The project would remove this structure and replace it with a bridge to allow access to spawning and rearing habitat for adult steelhead and possibly spring Chinook and bull trout.

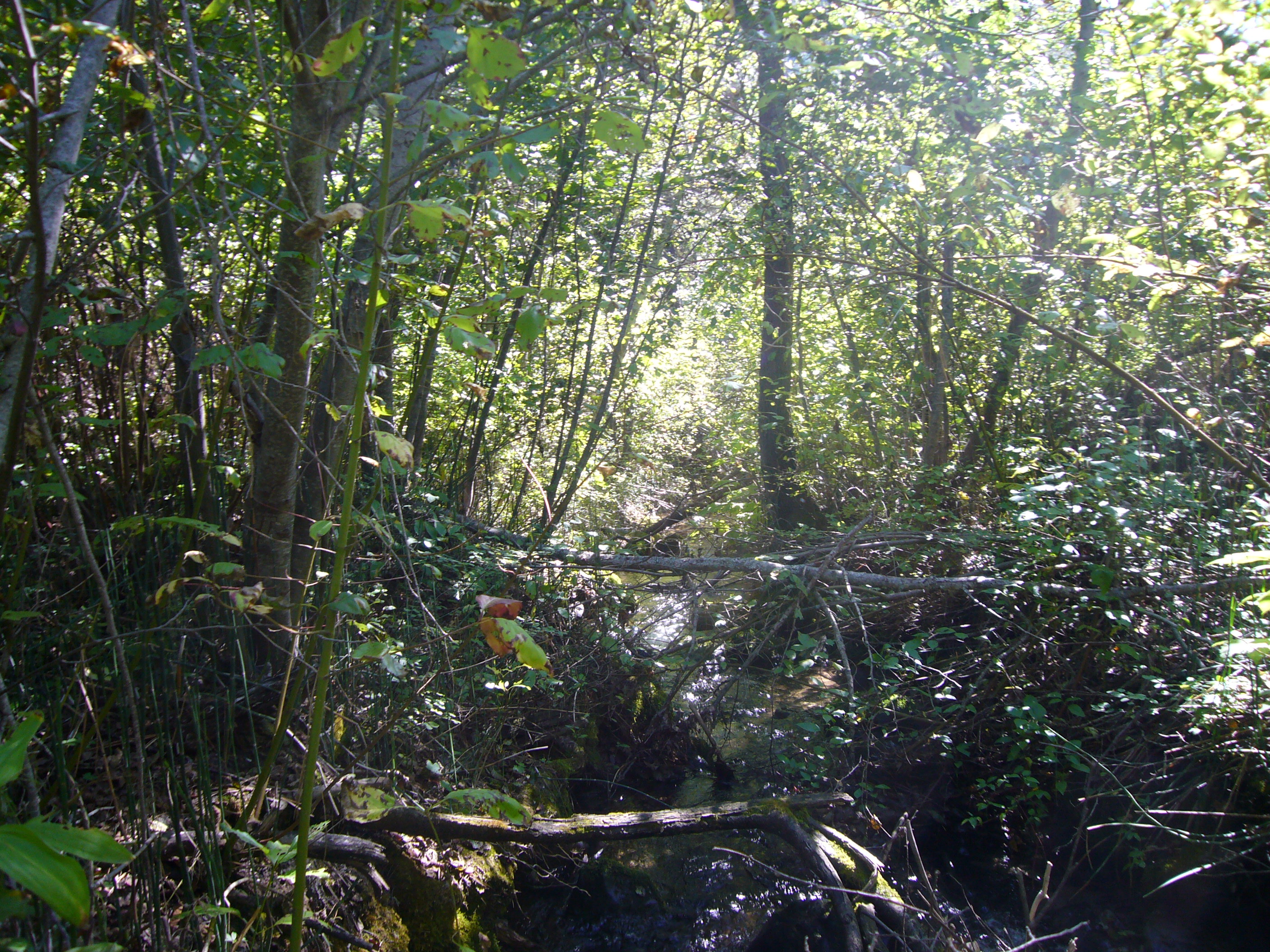

Peshastin Creek is a Category 2 watershed and a Major spawning area for steelhead and minor spawning area for spring Chinook and a bull trout core area. Mill Creek has perennial flow, drains a north and east facing basin, and has a relatively shallow stream gradient compared to nearby Allen, Hansel and Camas Creeks. Mill Creek offers a temperature refuge for fish in a section of Peshastin Creek that often reaches sub-lethal temperatures in late summer. Mill Creek has good riparian cover with few areas below 50% canopy cover, has moderate amounts of woody debris in the first 1.5 miles, numerous plunge pools of 1-2’ with some 3-4’ drops. Resident rainbow trout, O. mykiss gairdneri have been observed in Mill Creek. This application is the same as PRISM #11-1444 The project was not completed as the construction estimate far exceeds the available grant funding.
|

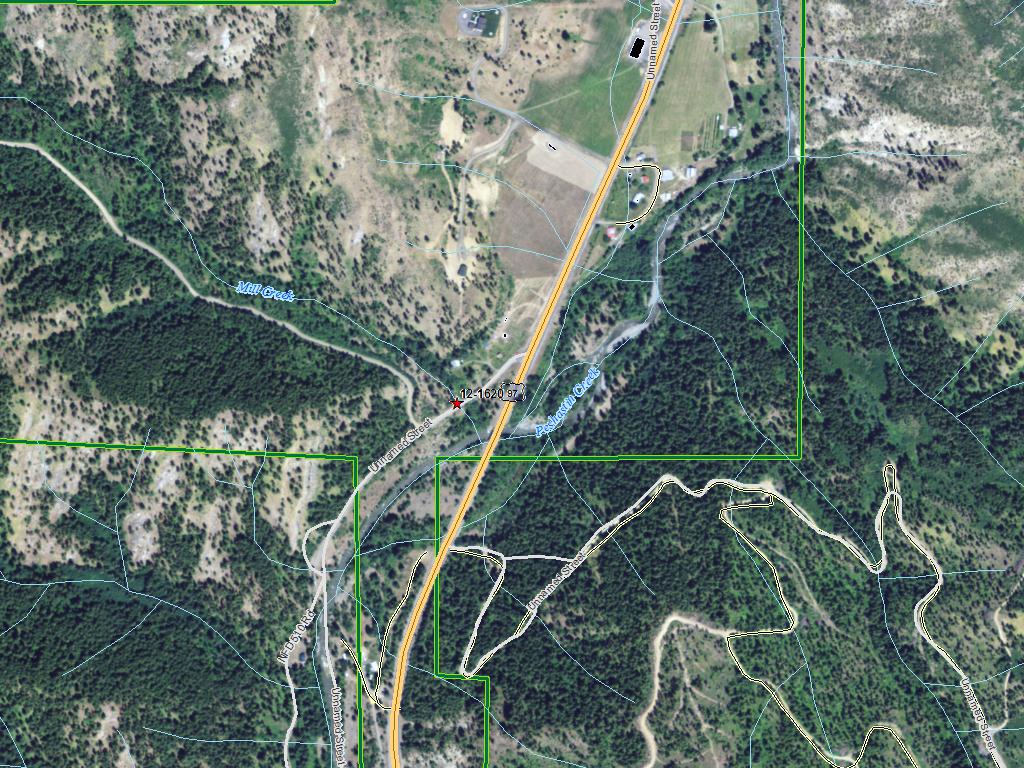

General Area:
|
|
Off US 97 near US 2 intersection
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Mt Stuart
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
06
|
Township:
|
|
T23NR18E
|
Coordinates:
|
|
47.51104985 -120.63232606
|
|
|
Worksite Name | Scope of Work | Proposed Restoration Cost |
Mill Creek culvert Mountain Home Ranch R (#1)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Cultural resources, Obtain permits
|
$303,942
|
| Total | $303,942 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Mill Creek culvert Mountain Home Ranch R (#1)
|
|
Property 1 - Mill Creek Culvert
|
Local Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Estimated |
Restoration Metrics (rolled up from Worksite level) |
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
3
|
Fish Passage Improvement |
Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
2.20
|
|
Number of bridges (C.2.g.2)
|
1
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
1
|
Permit Type | Applied Date | Received Date | Expiration Date | Permit Number |
Archeological & Cultural Resoures (EO 05-05)
|
|
05/15/2013
|
|
|
Cultural Assessment [Section 106]
|
|
05/15/2013
|
|
|
Endangered Species Act Compliance [ESA]
|
|
05/13/2013
|
|
2013-10103
|
Hydraulics Project Approval [HPA]
|
04/18/2013
|
06/21/2013
|
06/20/2018
|
130014-1
|
Nationwide Permit
|
|
07/29/2013
|
03/18/2017
|
NWS-2013-356
|
Water Quality Certification [Section 401]
|
|
|
|
|
Shoreline Permit
|
|
04/30/2013
|
|
SE 2013-058
|
Milestone Name | Target Date | Description |
Project Start
|
12/06/2012
|
|
Applied for Permits
|
04/01/2013
|
|
Cultural Resources Complete
|
06/01/2013
|
|
Progress Report Due
|
06/15/2013
|
|
Annual Project Billing Due
|
07/31/2013
|
|
Permits Complete
|
08/31/2013
|
|
Progress Report Due
|
12/15/2013
|
|
Preliminary Design to RCO
|
01/29/2014
|
Attached in PRISM.
|
Progress Report Due
|
06/15/2014
|
|
Bid Awarded/Contractor Hired
|
07/01/2014
|
|
Landowner Agreement to RCO
|
08/31/2014
|
|
Restoration Started
|
10/01/2014
|
|
Restoration Complete
|
10/31/2014
|
|
RCO Final Inspection
|
11/30/2014
|
|
Progress Report Due
|
12/15/2014
|
|
Agreement End Date
|
01/31/2015
|
|
Final Report Due
|
04/30/2015
|
|
Final Design to RCO
|
04/30/2015
|
|
Final Billing Due
|
04/30/2015
|
|
