Nason Creek Upper White Pine Reconnection
|
    Funding |
  |
|
    Links |
  |
|
|
The primary project objectives are to conduct an alternatives analysis (US Bureau of Reclamation), coordinate with the US Forest Service and Chelan PUD, and prepare conceptual designs in order to remove or selectively breach a levee to reconnect 25 acres of off-channel habitat and floodplain in the Upper White Pine Reach of Nason Creek. This reconnection will lead to increased refuge and rearing habitat, increased floodplain connectivity, and the restoration of natural channel processes in the project reach.
|

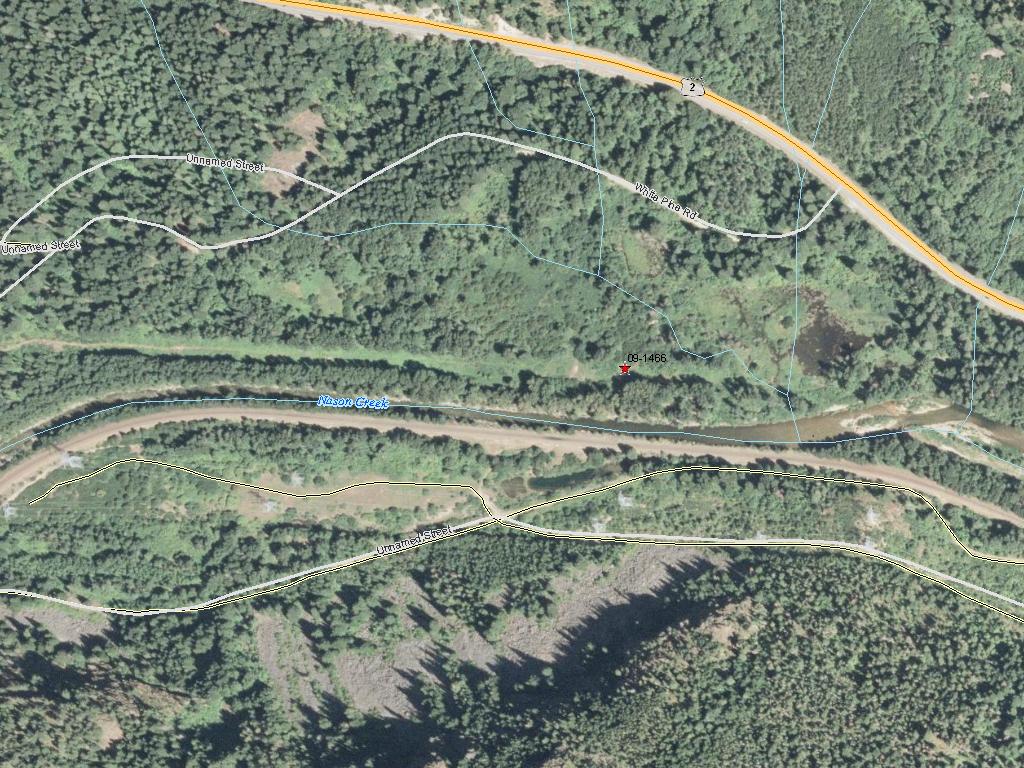

General Area:
|
|
Drive east from Leavenworth, WA approximately 18 miles on US 2 to White Pine Road (immediately after the Ray Rock Springs Knife Shop). Drive approximately 1 mile to the Chelan PUD powerlines crossing. Park here. Walk .5 mi down to the project site.
|
Waterbody:
|
|
Nason Creek, Wenatchee River
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Upper Nason
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
04
|
Township:
|
|
T26NR16E
|
Coordinates:
|
|
47.78735270 -120.86433840
|
|
|
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Nason Creek Upper White Levee Breach (#1)
|
|
Property 1 - Nason Creek UWP
|
Federal Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
3
|
Milestone Name | Target Date | Description |
Project Start
|
12/10/2009
|
|
Bid Awarded/Consultant Hired
|
05/31/2010
|
|
Data Gathering Started
|
06/01/2010
|
|
Progress Report Due
|
07/31/2010
|
|
Annual Project Billing Due
|
07/31/2010
|
|
Progress Report Due
|
12/01/2010
|
|
Annual Project Billing Due
|
07/31/2011
|
|
Progress Report Due
|
07/31/2011
|
|
Draft Rpt Reviewed by Mgmt Agy
|
12/31/2011
|
First draft submitted 03-30-11
|
Agreement End Date
|
06/30/2012
|
|
Special Conditions Met
|
09/30/2012
|
design criteria outlined in special conditions of project agreement
|
Final Docs/Billing to Mgmt Agy
|
09/30/2012
|
|
Final Report Completed
|
09/30/2012
|
|
