Project Snapshot
PRISM Project #12-1282 (Completed)
Bear Creek Reach 6 Restoration
    Project Details
Adopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

Attachment #134338, Downstream project area.
Adopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282) Attachment #134338, Downstream project area.

Adopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

Attachment #134338, Downstream project area. Adopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

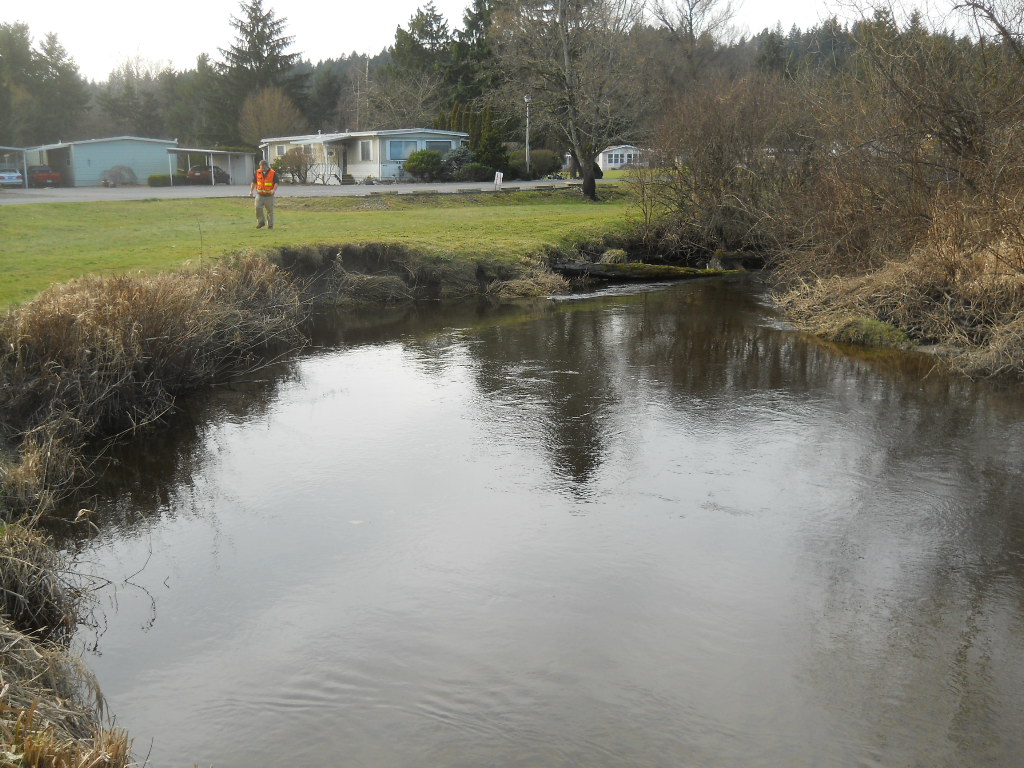

Attachment #134339, Downstream corner of work area.Adopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

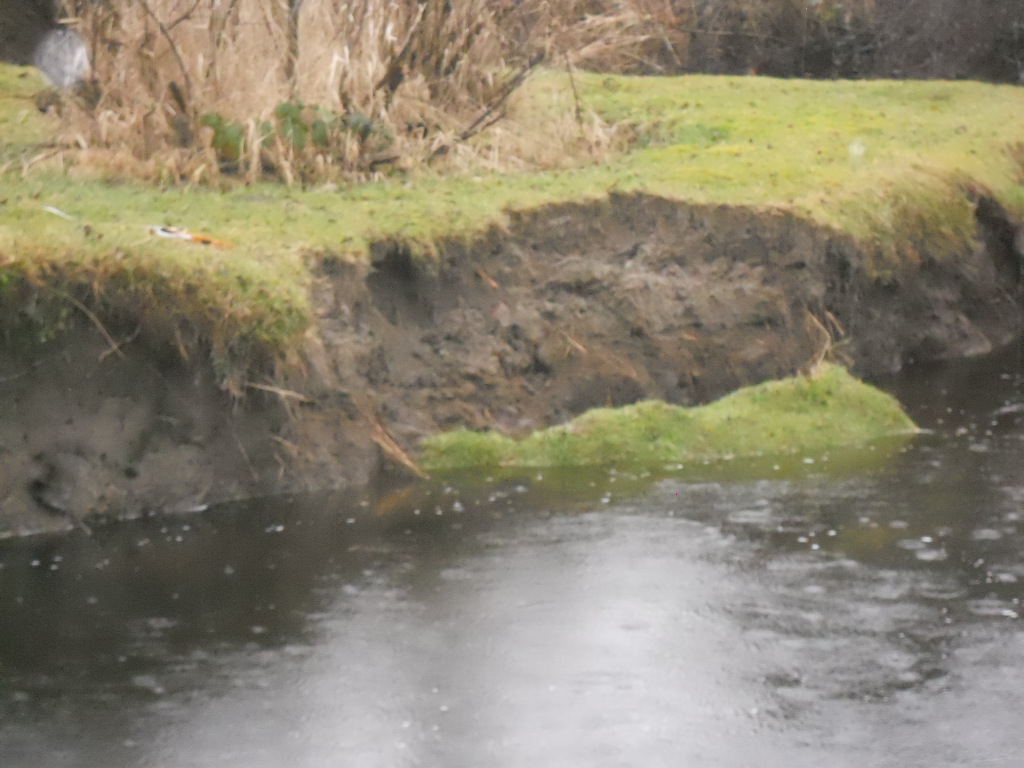

Attachment #134347, bank erosionAdopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

Attachment #134350, peninsula from upstreamAdopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

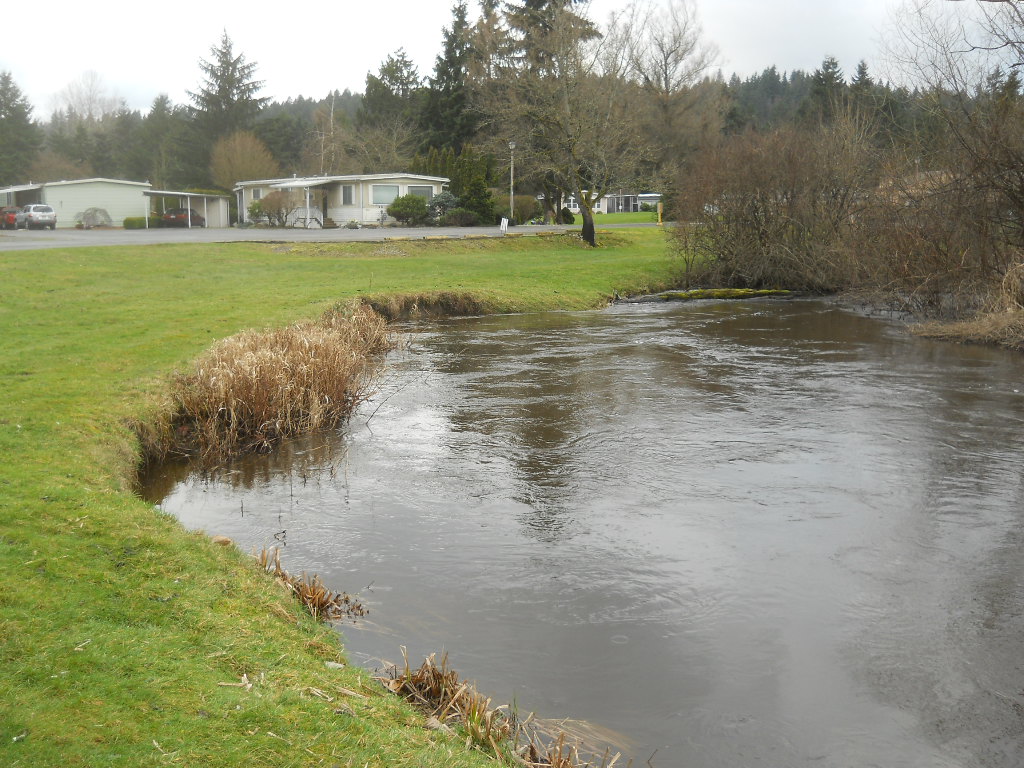

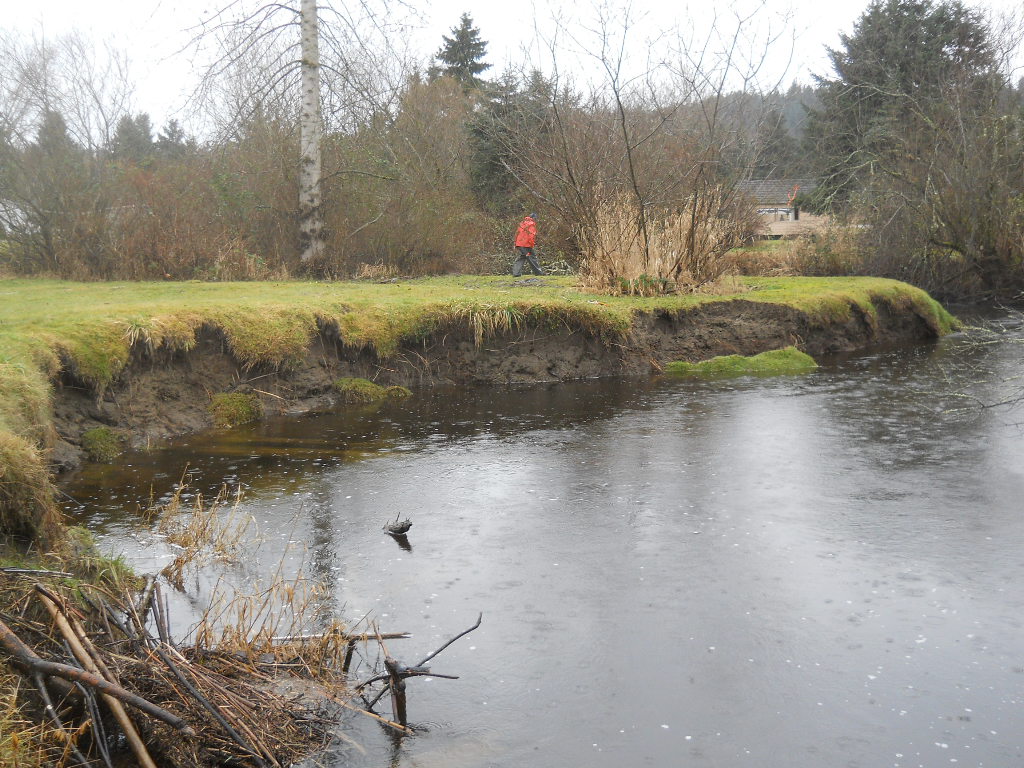

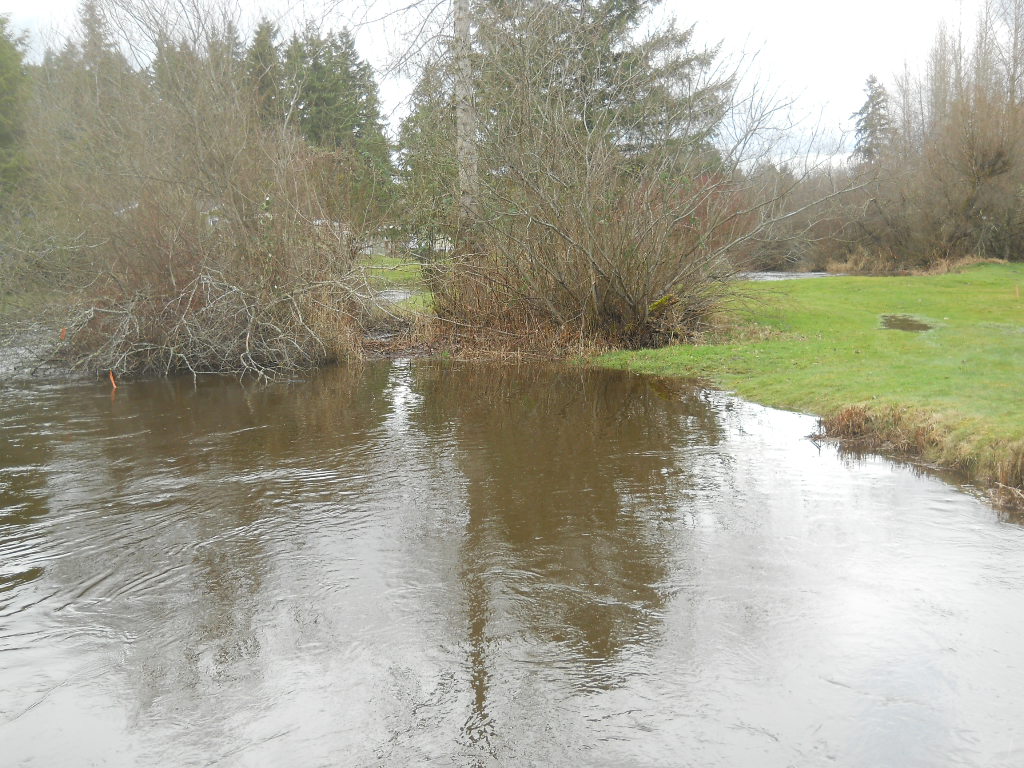

Attachment #134356, highwater at project siteAdopt A Stream Foundation; Bear Creek Reach 6 Restoration (#12-1282)

Attachment #134357, Highwater at project site.
Project Status:  Closed Completed since 01/28/2016

Project Type:  Restoration
Project Sponsor:  Adopt A Stream Foundation
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon Federal Projects: $73,723
Total RCO Grant: $73,723 (85%)
Sponsor Match: $13,008 (15%)
Total Agreement: $86,732 (100%)
              Links


    Project Description
Adopt A Stream Foundation (AASF) proposes to restore 370 linear feet of Bear Creek located in Friendly Village (18509 NE 95th Street) in the City of Redmond.
The proposed project will:
1) convert 0.3 acres of lawn to riparian habitat with 100 new native trees and 500 native shrubs,
2) widen the existing channel cross-section to reduce bank erosion, improve flood capacity, and create space for a seasonal inundated plant community,
3) install large wood to create fish habitat, reduce erosion, and protect existing infrastructure.

AASF is working with the landowners to develop a restoration strategy for the entire property while actively coordinating with the City of Redmond to assure that the work is compatible with future restoration efforts in the reach. Project deliverables will include those listed in Manual 18 Appendixes D-2, D-3 and D-4.

This proposal builds upon AASF's work with private property owners in the Bear Creek reach to restore riparian areas, increase in-channel complexity and add large wood. AASF uses King County's 1994 Bear Creek and Evans Creek Capital Improvement Program Projects report to identify potential projects. In particular, restoration is needed throughout Friendly Village development in the downstream end of reach and the equestrian center near the middle of the reach. AASF is currently under contract to scope and design stream restoration for the Friendly Village property owners. Degraded stream habitat conditions are found throughout the property.

    Project Contacts

Project Sponsor: Adopt A Stream Foundation Lead Entity: Lake Washington/Cedar/Sammamish Watershed (WRIA 8) Lead Entity
  Project Contact: Walter Rung
walterr@streamkeeper.org
(425) 316-8592 111


Funding Agency: Recreation and Conservation Office
  Project Manager: Sandy Dotts
sandra.dotts@rco.wa.gov
(360) 628-9487

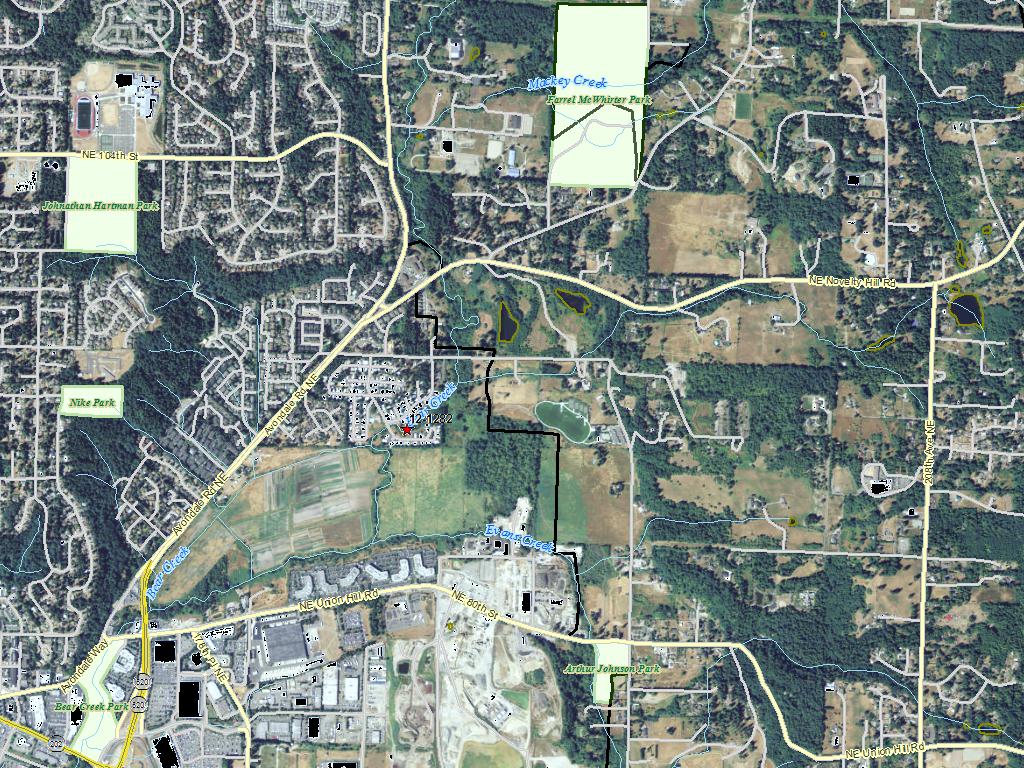

    Project Location
General Area:   Bear Creek, Redmond
County:   King
Legislative District:   48
Congressional District 2022:   01
Salmon Recovery Regions:   Puget Sound
Watershed Administrative Unit:   Sammamish River
HUC8:   Lake Washington (17110012)
WRIA:   Cedar - Sammamish
Sections:   06
Township:   T25NR06E
Coordinates:   47.68287744
-122.09161522

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Friendly Village (#1) Architectural & Engineering (A&E), Channel reconfiguration and connectivity (C.4.c.1), Cultural resources, Obtain permits, Planting (C.5.c.1), Streambank stabilization (C.4.e.1) $86,774
 Total$86,774
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Friendly Village (#1)   Property 1 - Friendly Village Private
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Instream Habitat Project
      Channel reconfiguration and connectivity (C.4.c.1)
Miles of Stream Treated for channel reconfiguration and connectivity (C.4.c.3) 0.06
Miles of Off-Channel Stream Created or Connected (C.4.c.4) 0.02
Acres Of Channel/Off-Channel Connected Or Added (C.4.c.5) 0.1
Instream Pools Created/Added (C.4.c.6) 4
      Streambank stabilization (C.4.e.1)
Miles of Streambank Stabilized (C.4.e.3) 0.06

Riparian Habitat Project
      Planting (C.5.c.1)
Acres Planted in riparian (C.5.c.3) 0.3

Permits
      Obtain permits
Number of permits required for implementation of project 3

Riparian Habitat Project
      Planting (C.5.c.1)
Miles of streambank planted (C.5.c.4) 0.07

    Project Milestones
Milestone NameTarget DateDescription
Project Start 12/06/2012 Eligible pre-agreement expenses listed in SRFB Manual 18 and Restoration Manual 5
Landowner Agreement to RCO 04/15/2013 For 2013. Will need another is construction deferred until 2014.
Progress Report Due 05/15/2013
Cultural Resources Complete 06/28/2013 CRA circulated to DAHP, Tulalip, Snoqualmie, 7/29/13. Need a Notice to Proceed from RCO
Applied for Permits 06/28/2013
Bid Awarded/Contractor Hired 06/30/2013 To be constructed by Sponsor
Annual Project Billing Due 07/31/2013
Preliminary Design to RCO 08/30/2013 Special Condition B.1, Manual 18 Appendix D-2
Progress Report Due 11/15/2013
Progress Report Due 05/15/2014
Permits Complete 05/31/2014
Final Design to RCO 05/31/2014 Special Condition B.2, Manual 18 Appendix D-3
Restoration Started 07/01/2014 In-Stream Work
Restoration Started 10/15/2014 Riparian Planting
Restoration Complete 10/31/2014 In-Stream
Progress Report Due 11/15/2014
Funding Acknowl Sign Posted 04/30/2015
Final Report Due 10/30/2015
Final Design to RCO 10/30/2015 Special Condition B.3 As-built Design (described in Appendix D-4) (Need Planting Plan)
Restoration Complete 10/31/2015 Riparian Planting
Stewardship Plan to RCO 11/13/2015 NOT REQUIRED
RCO Final Inspection 11/30/2015 Visited in Nov 2014. Final again in 2015.
Agreement End Date 11/30/2015 Project Closing: All expenditures must be incurred before this date. If restoration work is finished early, final invoice and deliverables will be submitted within 3 months of restoration work completion.
Final Billing Due 01/30/2016 Within 2 months of project end date, unless finish ahead of schedule.


    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State 12-1282 Project Agreement.pdf 02/14/2013
Amendment - State 12-1282 Amend #1 Special Conditions Change.pdf 02/04/2016
Amendment - State 12-1282 Amend #2 Time Extension.pdf 12/05/2014
Billing forms Volunteer Jake timesheet.pdf 01/14/2016
Billing forms Mulch receipt.pdf 01/14/2016
Billing forms Earthcorps invoice.pdf 01/14/2016
Certification of Applicant Match Volunteer sign-in sheet.pdf 04/15/2015
Certification of Applicant Match EarthCorps Match Letter.pdf 04/15/2015
Correspondence Response to preprosal SRFB comments .docx 08/09/2012
Cost Estimate Cost Estimate (2 wkshts).xls 09/04/2012
Design document Final Designs.pdf 01/13/2015
Design document FVFinalDesignReport_Edited.docx 08/06/2014
Design document Final Preliminary Design Report.pdf 03/11/2014
Design document Draft Project Design.pdf 03/22/2013
Design document Preliminary Design.pdf 04/05/2012
Design document (as built) FV Planting As-Built.pdf 10/30/2015
Design document (as built) Explanation for design changes As-built .docx 01/13/2015
Design document (as built) FV As-built.pdf 01/13/2015
Design document (as built) As-Built Friendly village.pdf 11/26/2014
Final project report Final Report 01/28/2016.pdf 01/28/2016
Inspection Photos 2020.08.27 12-1282 Site Visit.pptx.pptx 06/29/2021
Inspection Photos Final Inspection Photos.pptx 12/24/2015
Inspection Photos Bear Creek Reach 6 Restoration.pptx 11/06/2014
Inspection Report Inspection Report, #2829 (Accepted 12/29/21 15:09:18).pdf 12/29/2021
Map 12-1282 Air Photo.pdf 03/30/2012
Map Vicinity Map 12-1282.pdf 03/28/2012
Photo Volunteer event photo.jpg 04/15/2015
Photo DSCN1262.jpg 12/17/2014
Photo DSCN1260.jpg 12/17/2014
Photo DSCN1525.jpg 11/14/2014
Photo DSCN1523.jpg 11/14/2014
Photo DSCN1518.jpg 11/14/2014
Photo DSCN1510.jpg 11/14/2014
Photo DSCN1477.jpg 11/14/2014
Photo DSCN1474.jpg 11/14/2014
Photo DSCN0907.jpg 10/06/2014
Photo DSCN0906.jpg 10/06/2014
Photo DSCN0904.jpg 10/06/2014
Photo DSCN0903.jpg 10/06/2014
Photo Highwater at project site..jpg 03/30/2012
Photo highwater at project site.jpg 03/30/2012
Photo peninsula from upstream.jpg 03/30/2012
Photo bank erosion.jpg 03/30/2012
Photo Downstream corner of work area..jpg 03/30/2012
Photo Downstream project area..jpg 03/30/2012
Progress report Progress Report 05/05/2015.pdf 05/05/2015
Progress report Progress Report 11/14/2014.pdf 11/14/2014
Progress report Progress Report 05/22/2014.pdf 05/22/2014
Progress report Progress Report 12/17/2013.pdf 12/17/2013
Project presentation (12-1282) Bear Creek Reach 6 Restoration.pdf 05/15/2012
Salmon Project Proposal FV_Final.docx 08/23/2012
SRFB Review Panel Comment Form 12-1282 Bear Creek Reach 6 Restoration.docx 03/25/2013
Visuals FV Final Photos End of Summer 2015.pptx 10/30/2015
Visuals High Walter Pictures.pdf 01/15/2015
Visuals US Army Corps Nationwide Permit.pdf 07/23/2014
Visuals HPA from WDFW.pdf 05/12/2014
Visuals application site visit 2012.pptx 10/07/2012

Back to top Date of last change: 06/30/2023
