Icicle Boulder Field Passage Design
|
Trout Unlimited-WA Water Proj; Icicle Boulder Field Passage Design (#13-1342)
06/05/2013, Attachment #169855, Falls
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
Trout Unlimited - Washington Water Project's (TU-WWP) Icicle Creek Boulder Field Passage Design Project proposes to complete preliminary designs for fish passage at the boulder field in Icicle Creek and assess spawning and rearing habitat above the barrier. Icicle Creek is the major fish-bearing tributary to the Wenatchee River, in WRIA 45. This project will build on TU-WWP's recent work of assessing the potential for fish distribution in the 23 miles above the boulder field prominently present on Icicle Creek. The design will focus on habitat connectivity for listed salmonids, addressing a documented limiting factor as further described in the attached proposal.
|
General Area:
|
|

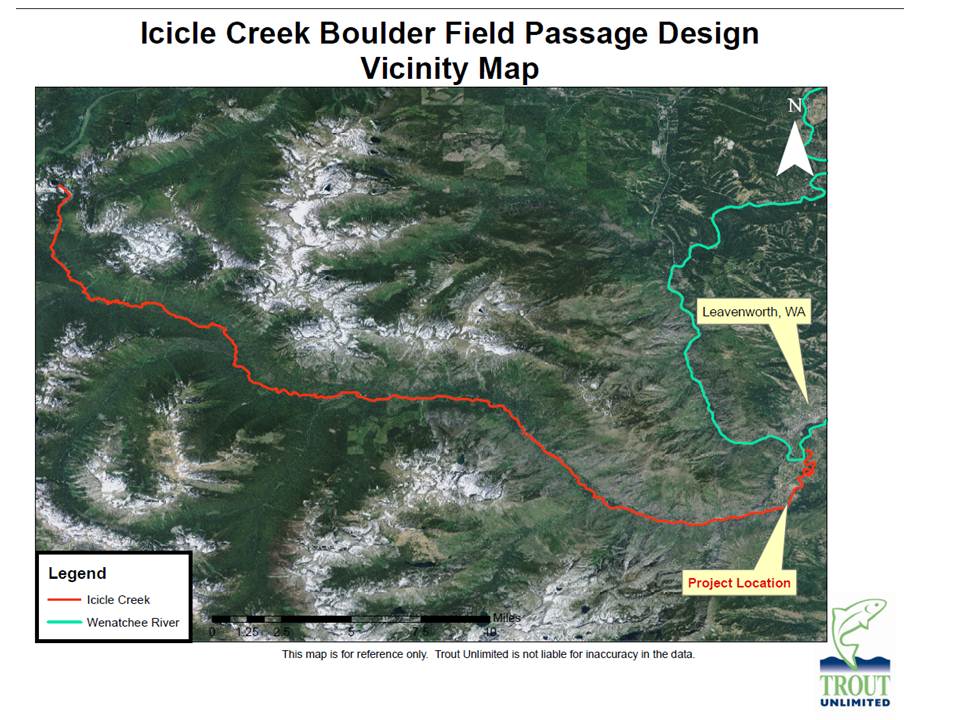

Southwest of Leavenworth
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Enchantment
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
28
|
Township:
|
|
T24NR17E
|
Coordinates:
|
|
47.54407963 -120.71237429
|
|
|
Worksite Name | Scope of Work | Actual Planning Cost |
Icicle Boulder Field (#1)
|

Preliminary design (B.1.b.11.a RCO)
|
$213,190
|
| Total | $213,190 |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
|
|
|
Area Encompassed (acres) (B.0.b.1)
|
21.9
|
|
Miles of Stream and/or Shoreline Affected (B.0.b.2)
|
0.32
|
Milestone Name | Target Date | Description |
Project Start
|
12/04/2013
|
|
RFP Complete/Consultant Hired
|
03/01/2014
|
|
Data Gathering Started
|
04/15/2014
|
|
Progress Report Due
|
06/30/2014
|
|
Annual Project Billing Due
|
07/31/2014
|
|
Progress Report Due
|
12/31/2014
|
|
Preliminary Design to RCO
|
06/30/2015
|
30% Design; Need for peer review by technical team.
|
Cultural Resources Complete
|
06/30/2015
|
Consultation is complete, but requires onsite observation during geotechnical digging.
|
Annual Project Billing Due
|
07/31/2015
|
|
Preliminary Design to RCO
|
03/31/2016
|
80% Design
|
Special Conditions Met
|
10/14/2016
|
|
Agreement End Date
|
10/14/2016
|
|
Final Design to RCO
|
12/30/2016
|
|
Final Report Due
|
12/30/2016
|
|
Final Billing Due
|
12/30/2016
|
|
