Project Snapshot
PRISM Project #09-1461 (Completed)
Tepee Creek Restoration - Phase 2 Construction
    Project Details
Yakama Nation; Tepee Creek Restoration - Phase 2 Construction (#09-1461)

Attachment #77250, Tepee Ck Restoration - Phase 2 Existing Conditions
Yakama Nation; Tepee Creek Restoration - Phase 2 Construction (#09-1461) Attachment #77250, Tepee Ck Restoration - Phase 2 Existing Conditions

Yakama Nation; Tepee Creek Restoration - Phase 2 Construction (#09-1461)

Attachment #77250, Tepee Ck Restoration - Phase 2 Existing Conditions Yakama Nation; Tepee Creek Restoration - Phase 2 Construction (#09-1461)

Attachment #77251, Tepee Ck Restoration - Phase 2 Existing Conditions (2)Yakama Nation; Tepee Creek Restoration - Phase 2 Construction (#09-1461)

Attachment #79354, Tepee2_location map
Project Status:  Closed Completed since 02/21/2014

Project Type:  Restoration
Project Sponsor:  Confederated Tribes and Bands of the Yakama Nation
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon Federal Projects: $366,073
Total RCO Grant: $366,073 (82%)
Sponsor Match: $82,092 (18%)
Total Agreement: $448,164 (100%)
              Links


    Project Description
Tepee Creek, a tributary to White Creek in the Klickitat River subbasin, provides important spawning and rearing habitat for ESA-listed Middle Columbia River steelhead. The White Creek watershed as a whole is the most important steelhead spawning and rearing tributary watershed within the Klickitat subbasin, accounting for up to 40% of the observed steelhead spawning in the entire Klickitat subbasin in some years. Tepee Creek has accounted for up to 21% of the observed spawning in the Klickitat subbasin in recent years, however in most years it likely accounts for between 5 and 10%. Extensive reaches of Tepee Creek have become incised and are now intermittent in many places that anecdotal evidence suggests were once perennial. Flood plain connectivity will be reestablished between river miles 4.5 to 5.3 with the ultimate goal of increasing floodplain storage, reducing severity of active channel hydraulic conditions during high flows, enhancing instream habitat, and potentially restoring baseflows to this and downstream reaches. In order to restore overbank flow frequency to the pre-disturbance floodplain, gravels will be imported and pool-riffle sequences will be constructed. In addition, LWD jams will be constructed along channel margins to maintain pool depths, provide cover, and restrict bank erosion. The approach to be used has been successfully implemented as part the Tepee Creek - IXL Meadows Restoration Project (constructed in 2006 and 2007).

Project timeline: July 15, 2010 - November 15, 2011

    Project Contacts

Project Sponsor: Confederated Tribes and Bands of the Yakama Nation Lead Entity: Klickitat Lead Entity
  Project Contact: Will Conley

(509) 369-3183


Funding Agency: Recreation and Conservation Office
  Project Manager: Kay Caromile
kay.caromile@rco.wa.gov
(360) 867-8532


    Project Location
General Area:   Tepee Creek, tributary of the Klickitat River
Waterbody:   Tepee Creek, White Creek
County:   Yakima
Legislative District:   14
Congressional District 2022:   04
Salmon Recovery Regions:   Middle Columbia River
Watershed Administrative Unit:   Tepee Creek
HUC8:   Klickitat (17070106)
WRIA:   Klickitat
Sections:   22
Township:   T08NR14E
Coordinates:   46.17266156
-121.03271221

    Worksites
Worksite NameScope of WorkActual Restoration Cost
RM 4.5-5.3 (#1) Architectural & Engineering (A&E), Channel reconfiguration and connectivity (C.4.c.1), Channel structure placement (C.4.d.1), Fencing (C.5.d.1), Obtain permits, Riparian Plant removal / control (C.5.h.1), Streambank stabilization (C.4.e.1) $504,116
 Total$504,116
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
RM 4.5-5.3 (#1)   Property 1 - Tepee Creek Tribal Government
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Instream Habitat Project
      Channel reconfiguration and connectivity (C.4.c.1)
Miles of Stream Treated for channel reconfiguration and connectivity (C.4.c.3) 0.70
Miles of Off-Channel Stream Created or Connected (C.4.c.4) 0.03
Acres Of Channel/Off-Channel Connected Or Added (C.4.c.5) 1.0
Instream Pools Created/Added (C.4.c.6) 26
      Channel structure placement (C.4.d.1)
Miles of Stream Treated for channel structure placement (C.4.d.3) 0.70
Acres Of Streambed Treated for channel structure placement (C.4.d.4) 0.4
Pools Created through channel structure placement (C.4.d.5) 26
Number of structures placed in channel (C.4.d.7) 26
      Streambank stabilization (C.4.e.1)
Miles of Streambank Stabilized (C.4.e.3) 0.70

Riparian Habitat Project
      Fencing (C.5.d.1)
Miles of Fence Along Stream (C.5.d.2) 1.60
Acres of Riparian Area Protected by fencing (C.5.d.3) 4.0
      Riparian Plant removal / control (C.5.h.1)
Acres of riparian treated for plant removal/control (C.5.h.3) 4.0

Permits
      Obtain permits
Number of permits required for implementation of project 3

    Project Milestones
Milestone NameTarget DateDescription
Project Start 12/10/2009
Annual Project Billing Due 07/31/2010
Cultural Resources Complete 12/10/2010 Already completed
Progress Report Due 12/30/2010
Progress Report Due 06/30/2011
Annual Project Billing Due 07/31/2011
Construction Started 10/17/2011 originally 9/9/2010
Progress Report Due 12/31/2011
Progress Report Due 06/30/2012
Annual Project Billing Due 07/31/2012
Progress Report Due 12/30/2012
Progress Report Due 05/31/2013
Annual Project Billing Due 07/31/2013
Progress Report Due 11/18/2013
Construction Complete 12/16/2013
Agreement End Date 03/01/2014
Final Docs/Billing to Mgmt Agy 05/01/2014


    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State Agreement 6-24-10.pdf 06/28/2010
Amendment - State Amendment 1 Internal Scope Change 2-20-14.pdf 09/03/2014
Amendment - State Amendment 1 Approval form 1-16-13.pdf 09/03/2014
Amendment - State Amendment 1 Time Extension 1-16-13.pdf 09/03/2014
Final project report Final Report 02/21/2014.pdf 02/21/2014

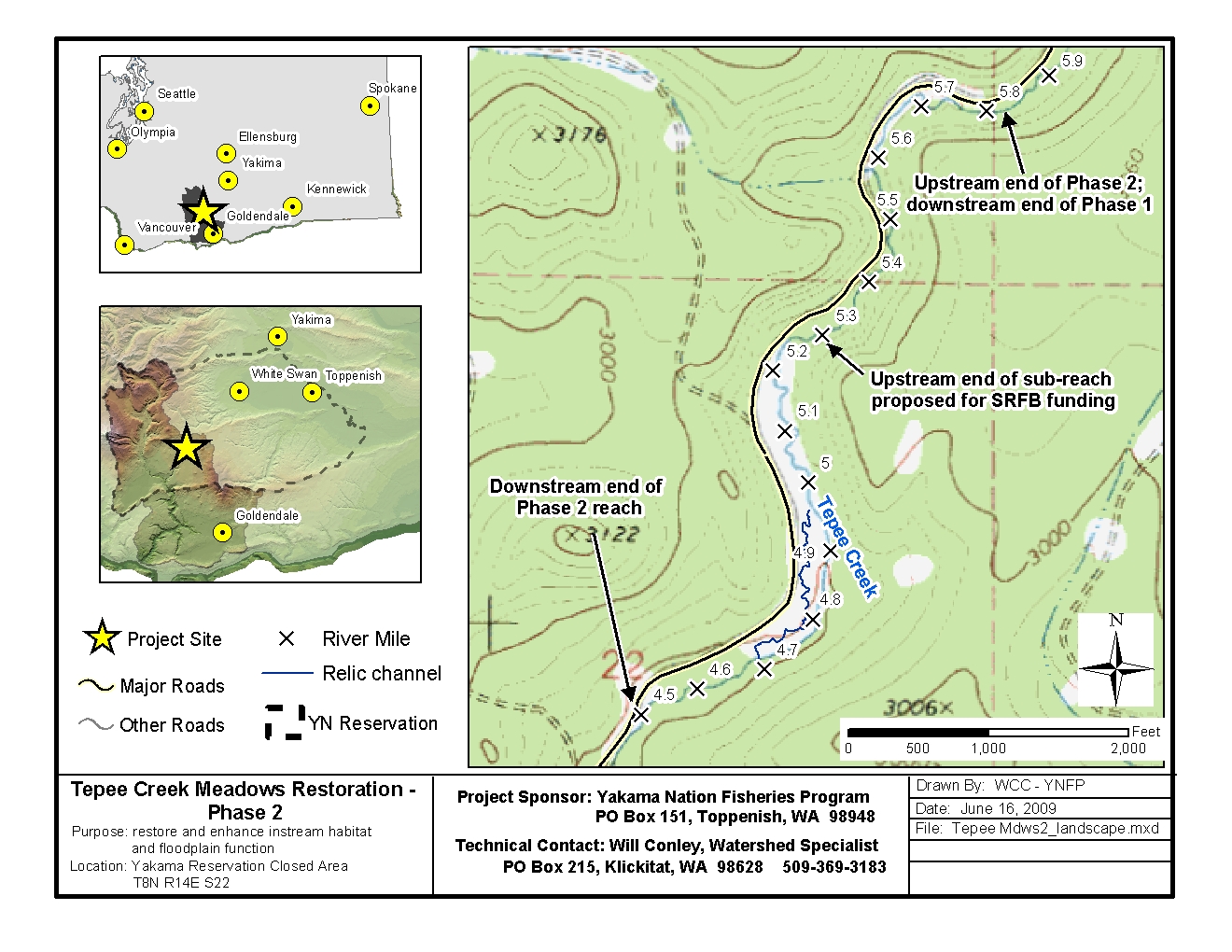

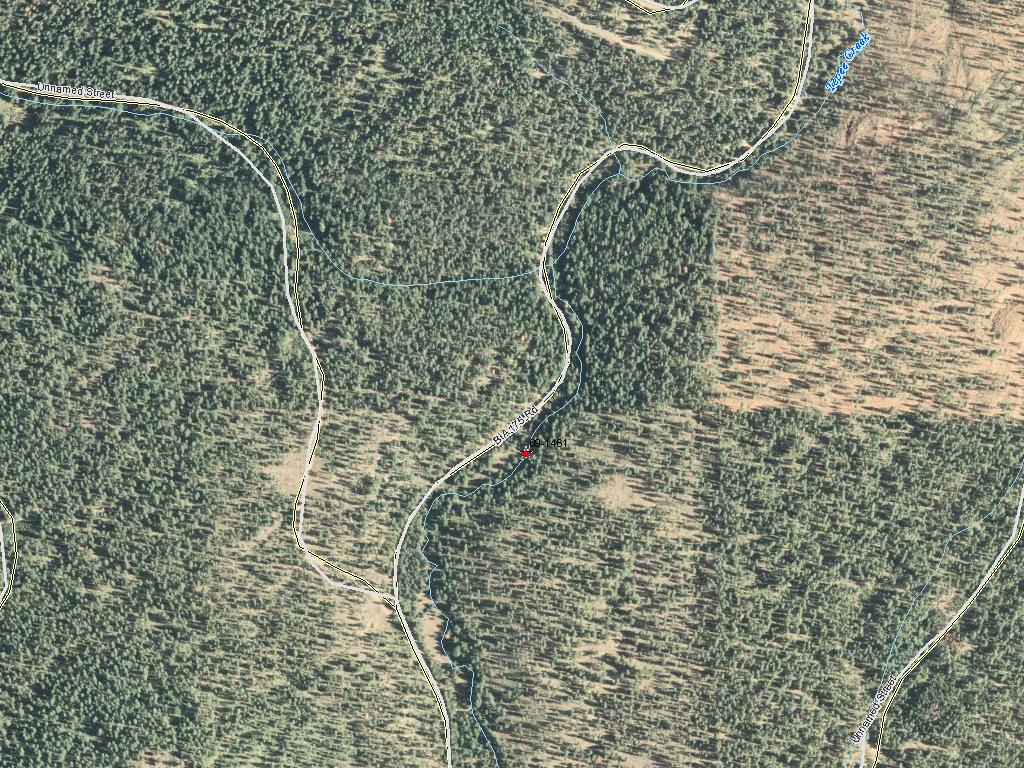

Map Tepee2_location map.jpg 06/17/2009

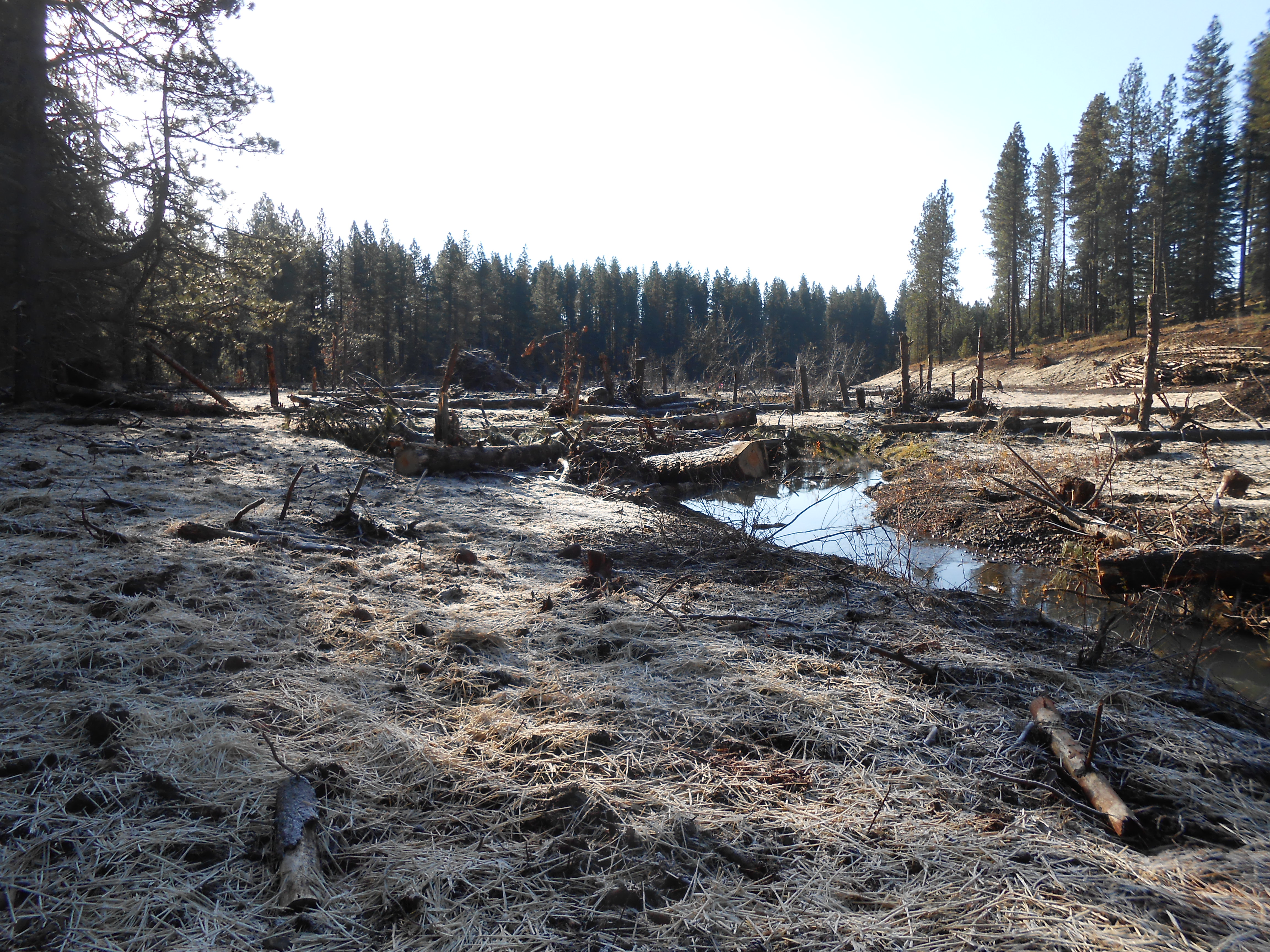

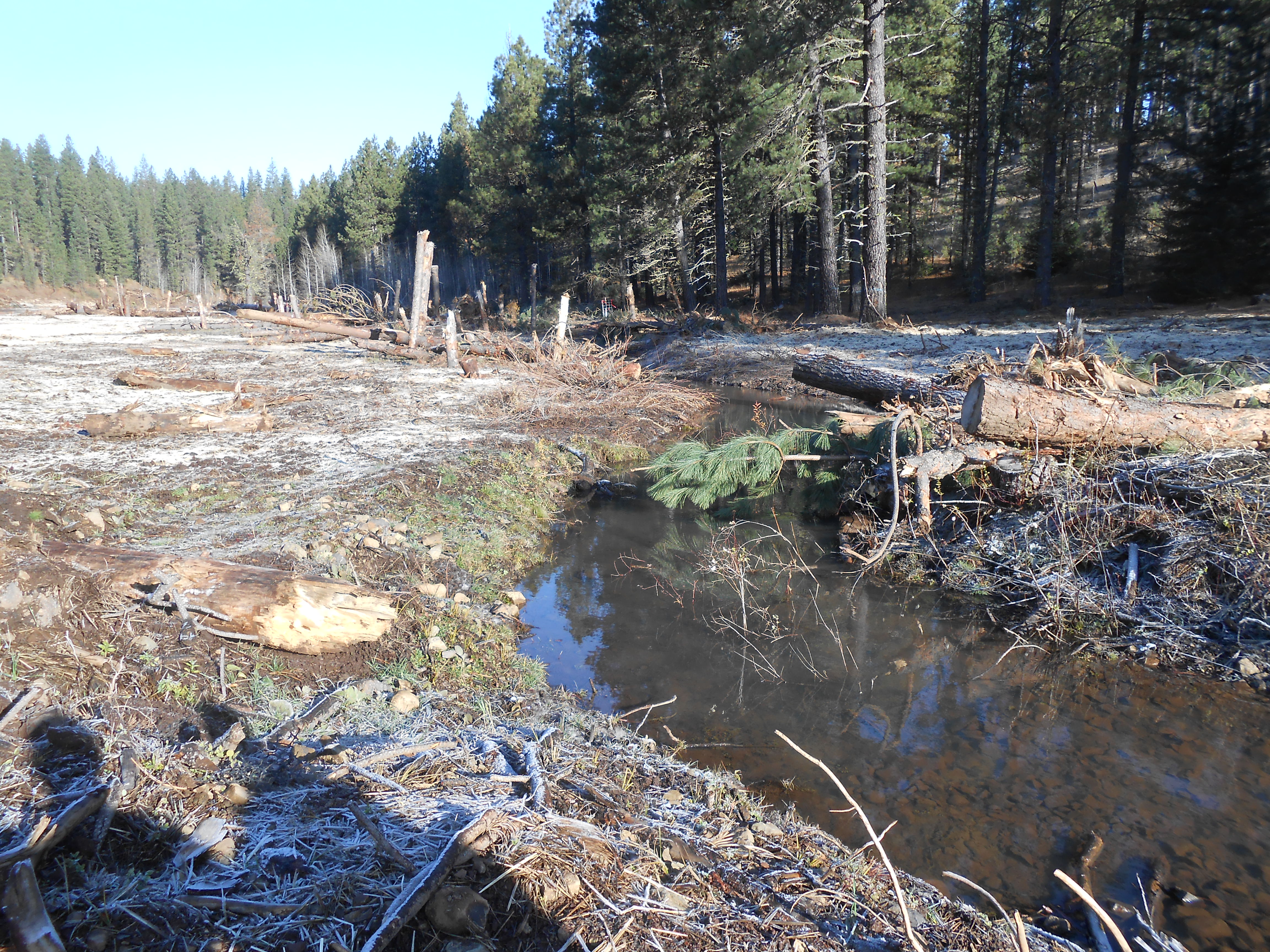

Photo Teepee II #8.jpg 02/19/2014

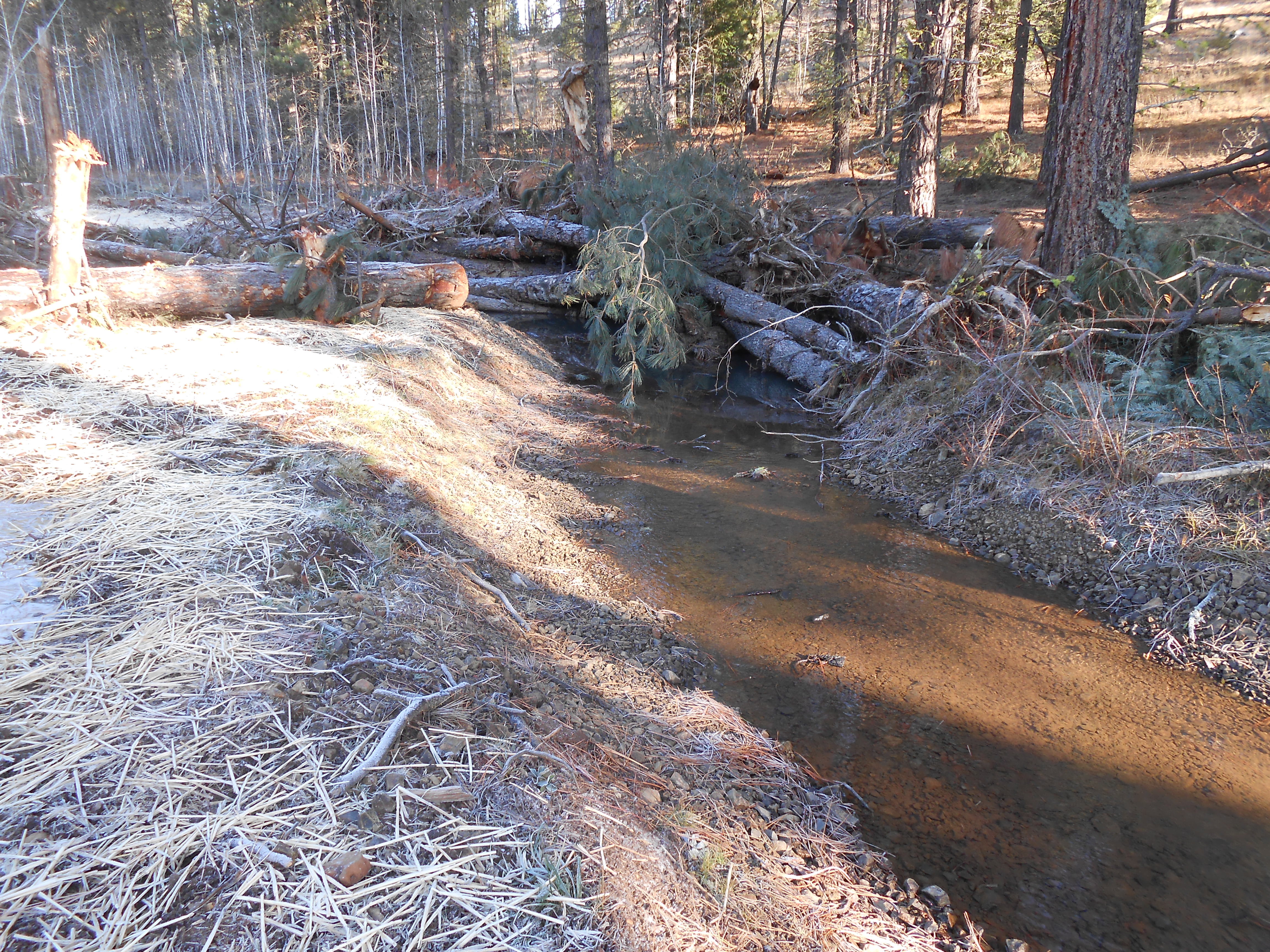

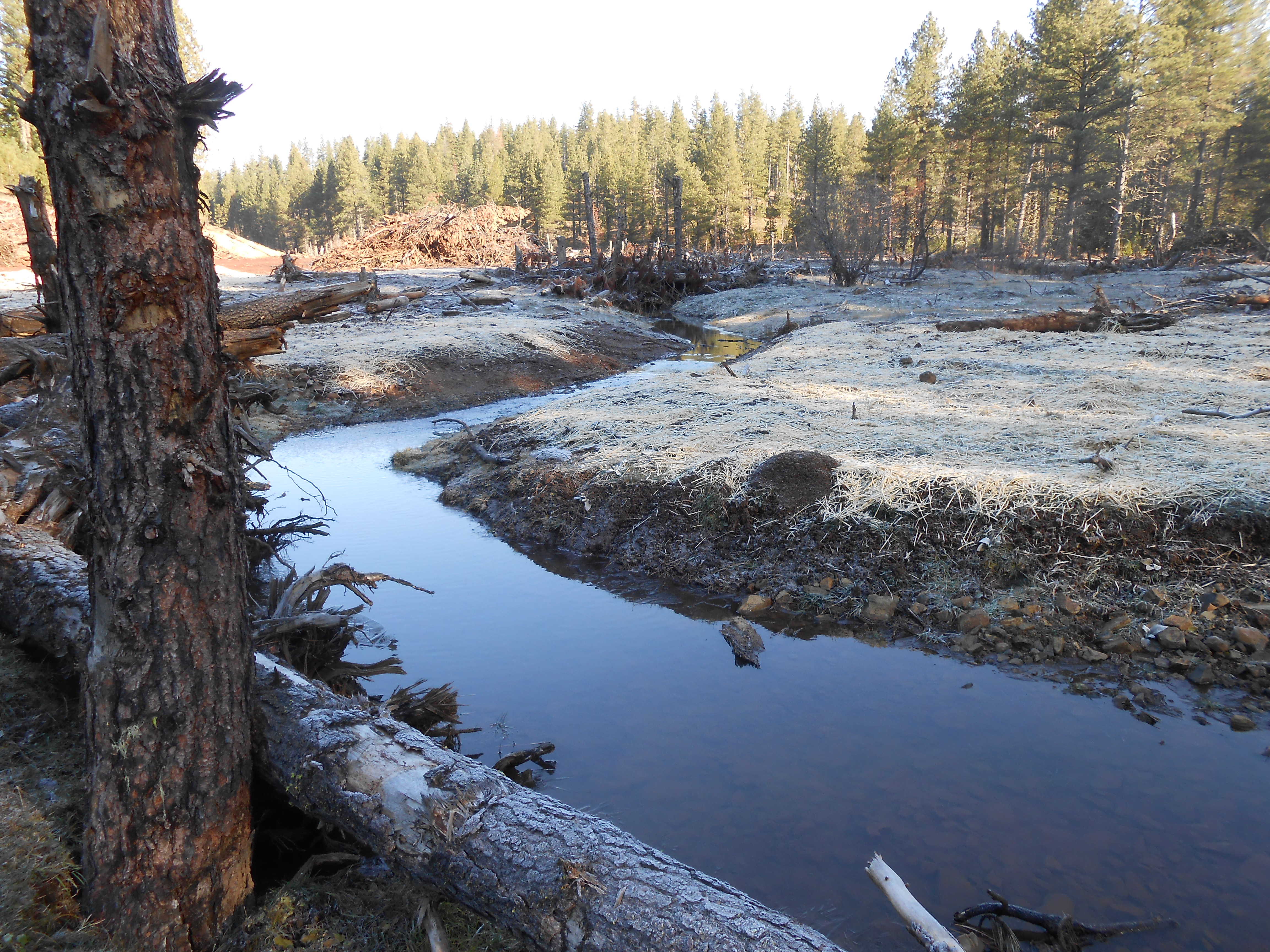

Photo Teepee II #7.jpg 02/19/2014

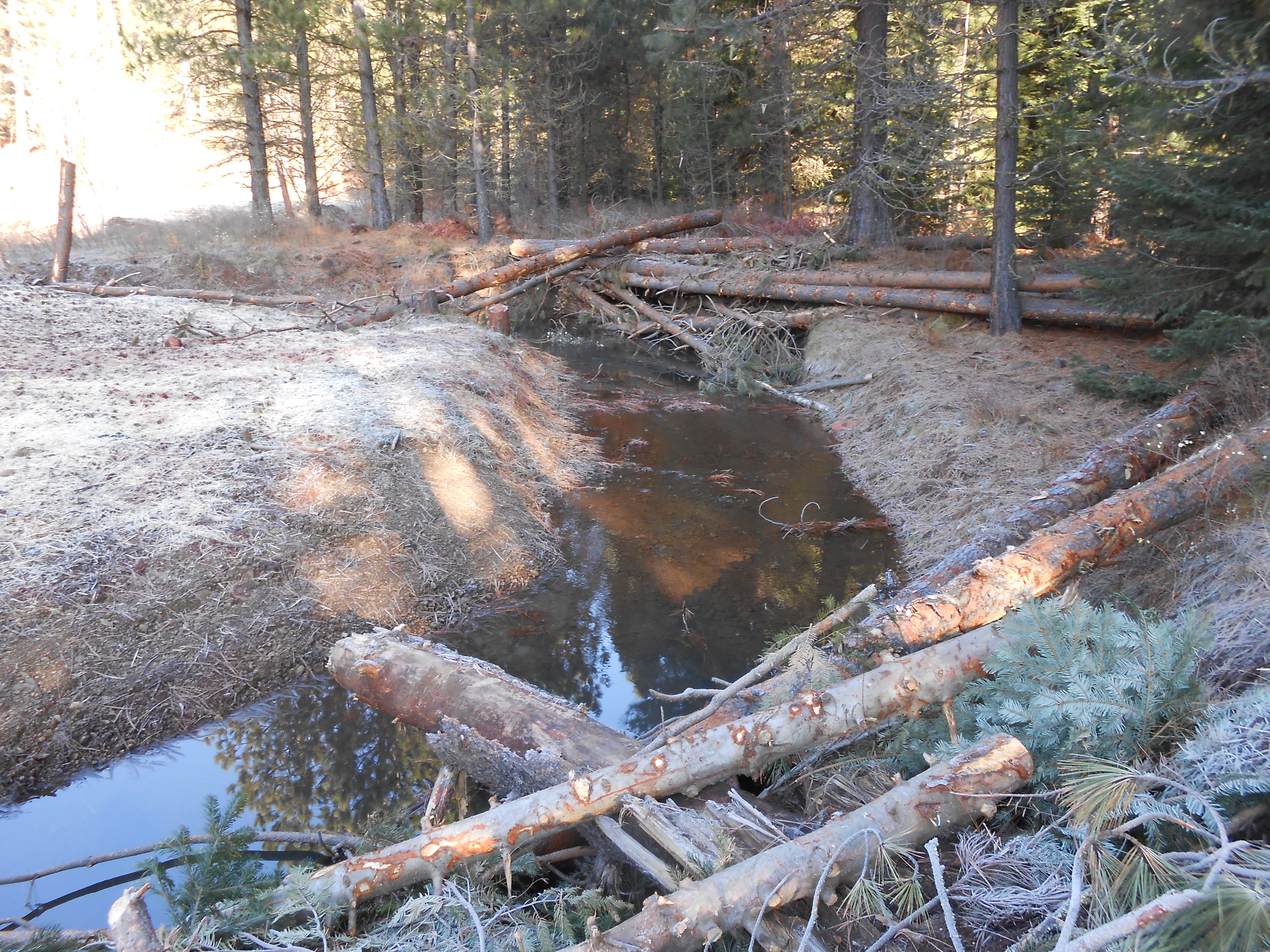

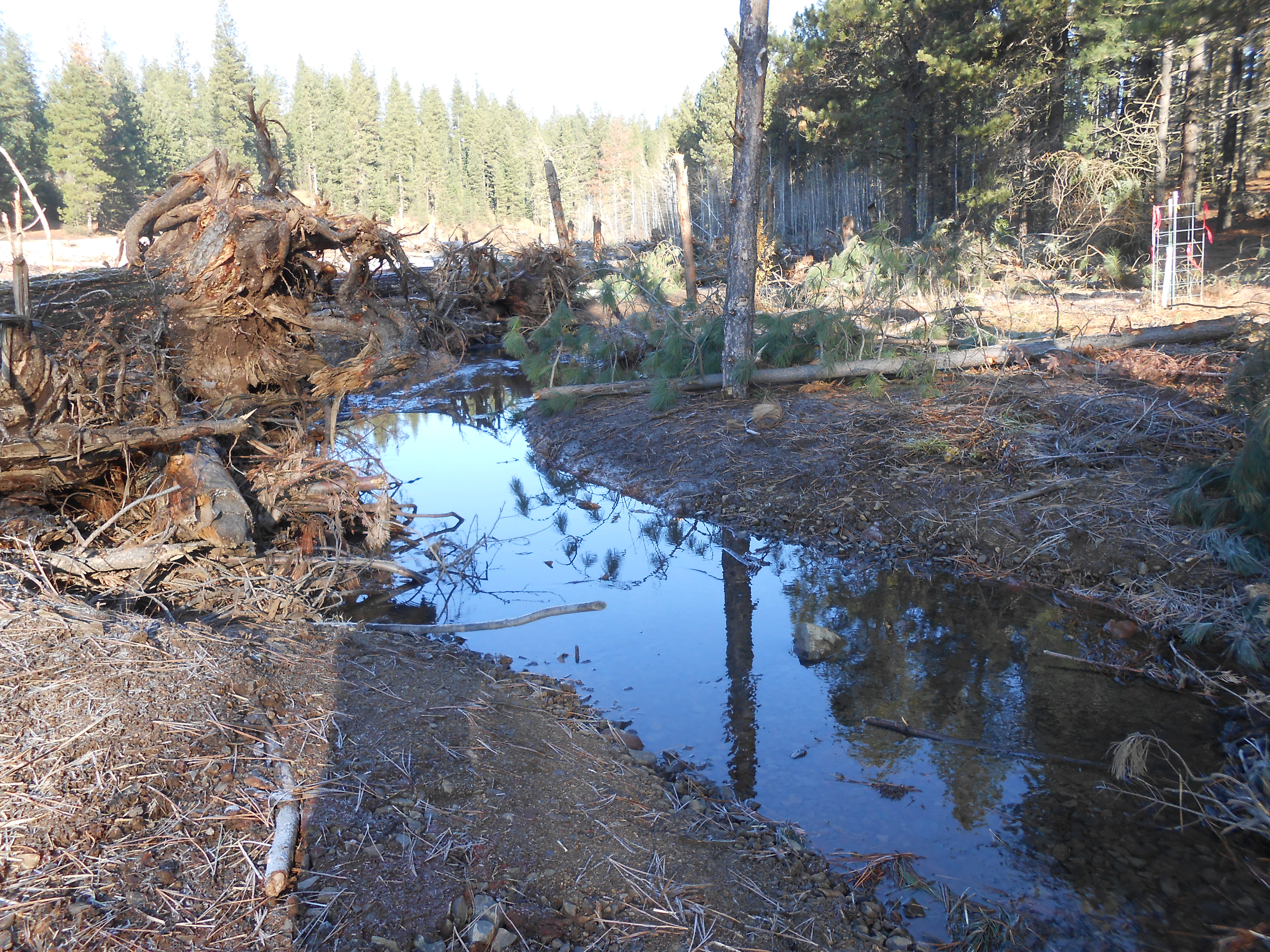

Photo Teepee II #6.jpg 02/19/2014

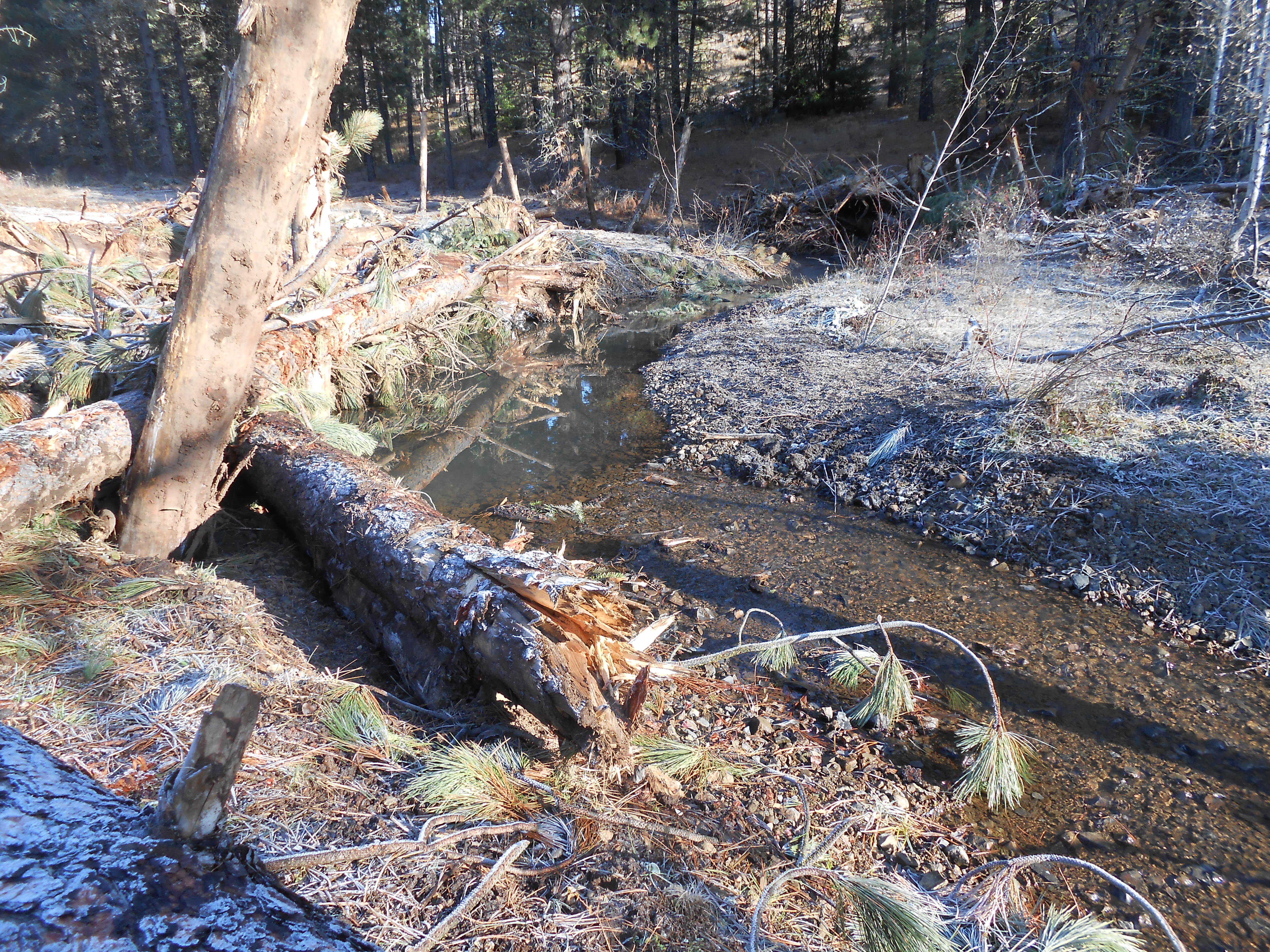

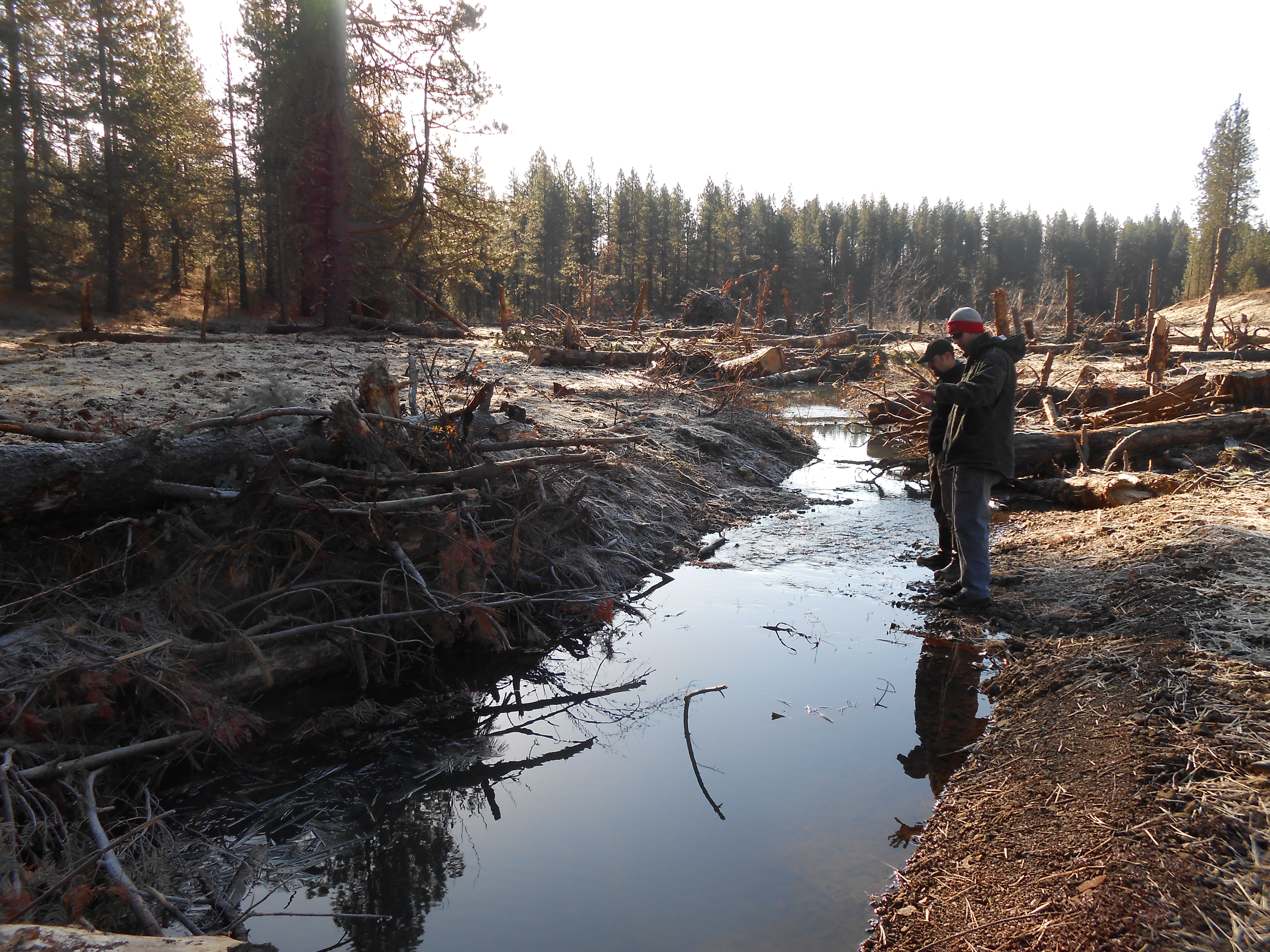

Photo Teepee II #5.jpg 02/19/2014
Photo Teepee II #4.jpg 02/19/2014
Photo Teepee II #3.jpg 02/19/2014
Photo Teepee II #2.jpg 02/19/2014
Photo Teepee II #1.jpg 02/19/2014

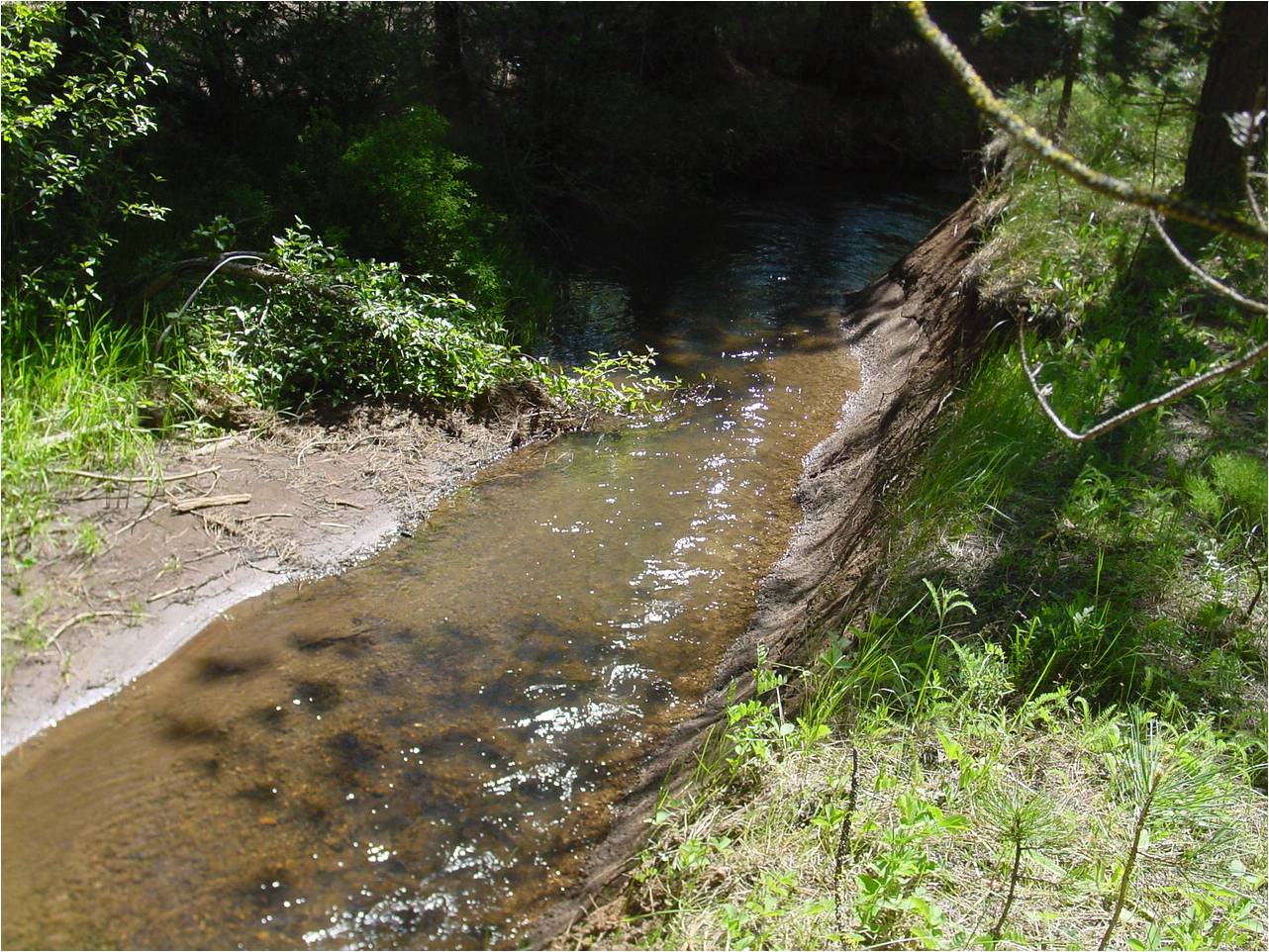

Photo Tepee Ck Restoration - Phase 2 Existing Conditions (2).jpg 05/07/2009

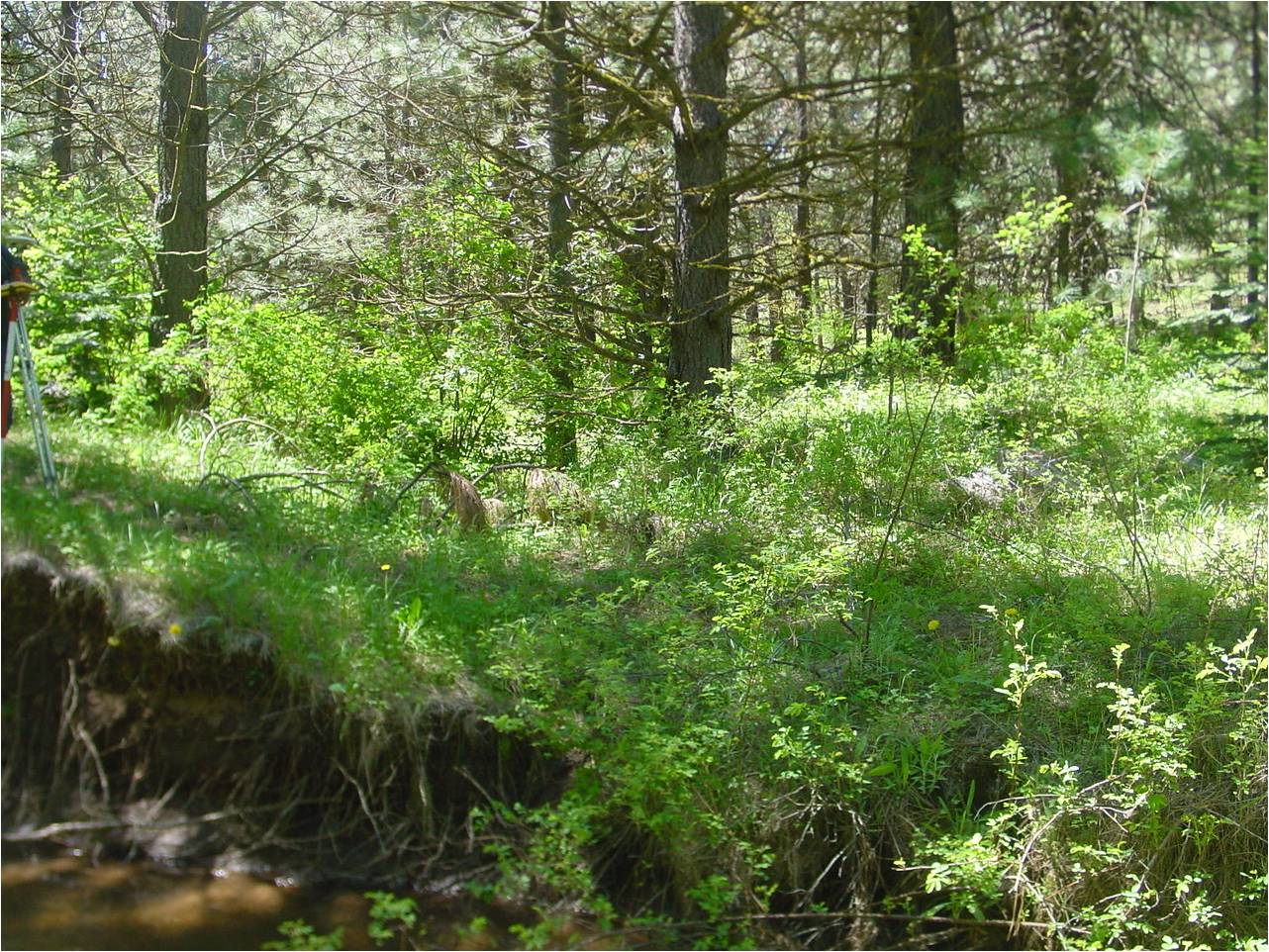

Photo Tepee Ck Restoration - Phase 2 Existing Conditions.jpg 05/07/2009
Progress report Progress Report 11/19/2013.pdf 11/19/2013
Progress report Progress Report 01/09/2013.pdf 01/09/2013
Progress report Progress Report 10/12/2012.pdf 10/12/2012
Salmon Project Proposal TepeeCk_Restoration-Phase2.pdf 06/25/2009
SRFB Review Panel Comment Form Post Application Individual Project Comments.pdf 12/11/2009
Stewardship plan Tepee Ck Phase 2 Stewardship Plan 12-16-13.pdf 12/17/2013
Visuals Tepee2_061609.ppt 06/25/2009
