Clear Creek Passage Program
|
    Funding |
  |
|
    Links |
  |
|
|
Three barrier culverts occur in Clear Creek, within in the Chiwawa River Catagory 1 watershed, that are partial or complete passage barriers to juvenile and adult ESA listed Upper Columbia summer steelhead (WFDW 2005). Up to 30 steelhead redds a year have been found below culvert #1 located on private land (Personal Communication, Cameron Thomas 2006). By replacing the fish barrier culverts with modular steel bridges in Clear Creek will provide approximately 2.7 additional linear mile of stream habitat. Clear Creek culverts #1, #2 and #3 were given a "high" priority for replacement by the Upper Columbia Regional Technical Team ( UCRTT 2006). In addition, Beaver Creek culverts are included in the Salmon Recovery Plan Implementation Schedule for construction in years 1-3 (UCSRB 2006).
|
General Area:
|
|

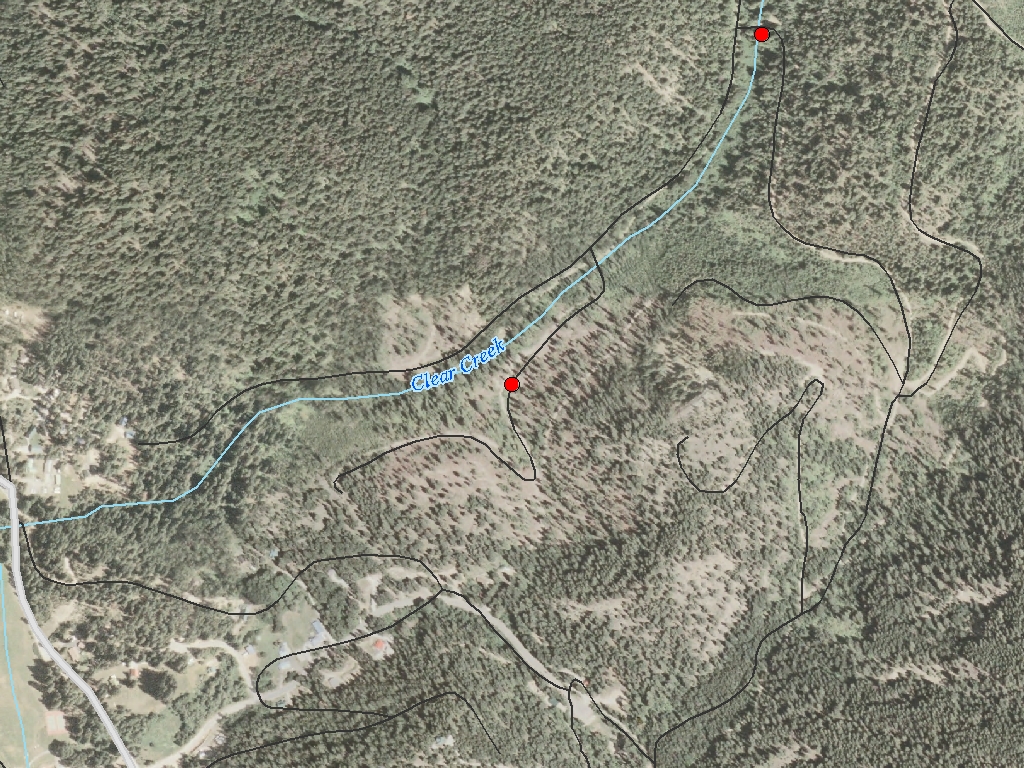

Clear Creek, tributary of Chiwawa
|
Waterbody:
|
|
Chiwawa River, Clear Creek, Clear Creek, barrier #1
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Lower Chiwawa
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
32
|
Township:
|
|
T27NR18E
|
Coordinates:
|
|
47.80138853 -120.62056891
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |

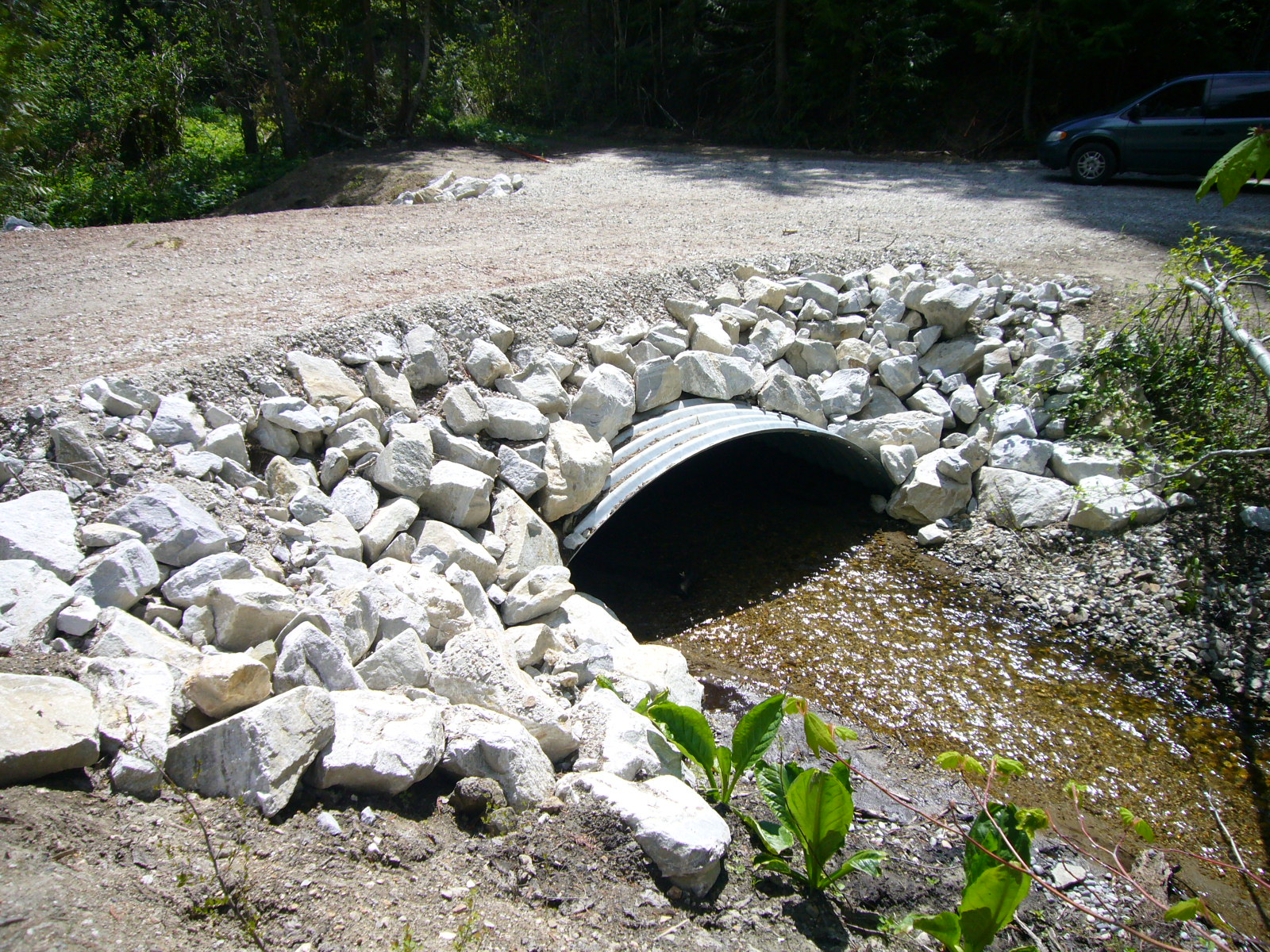

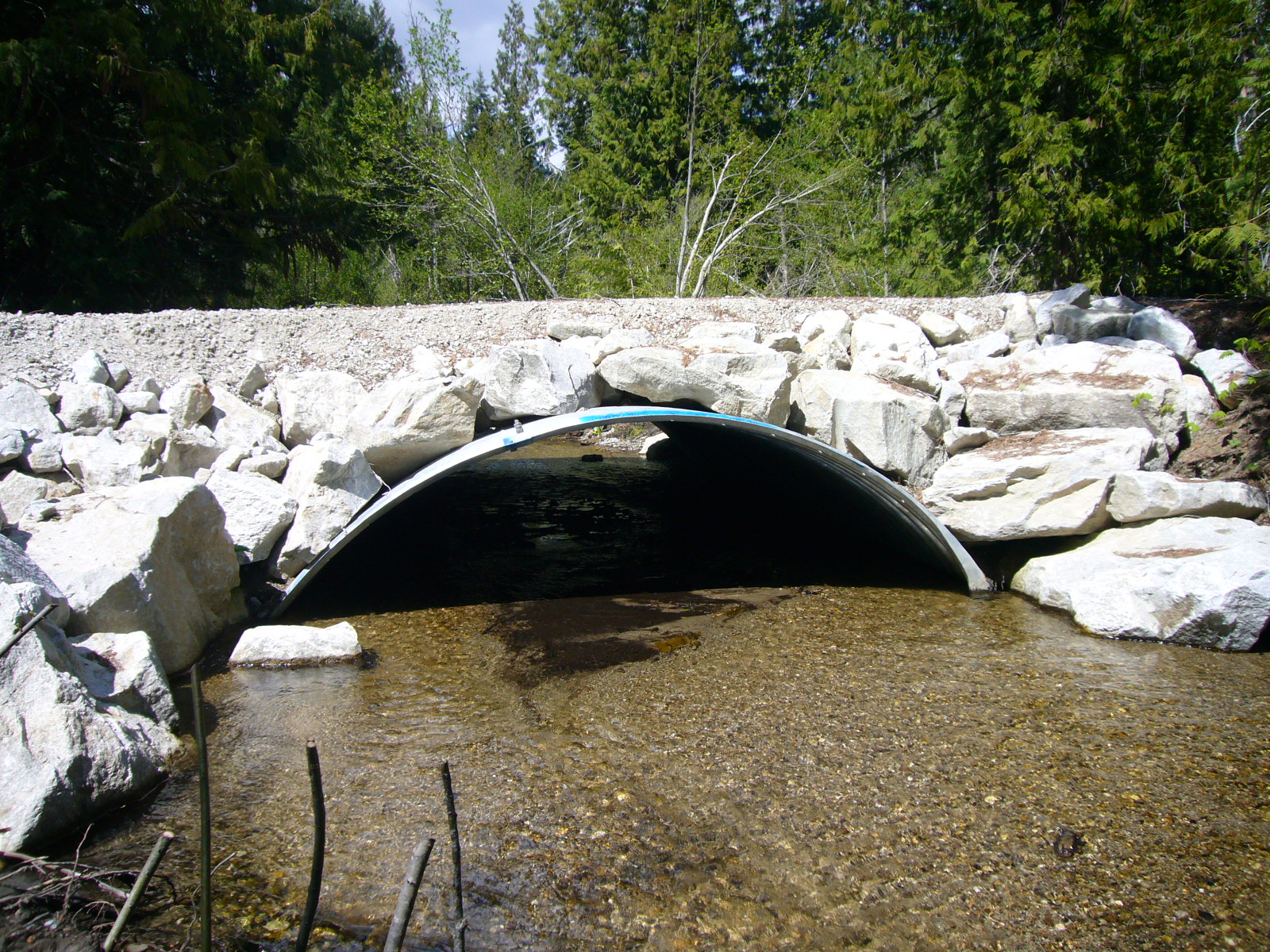

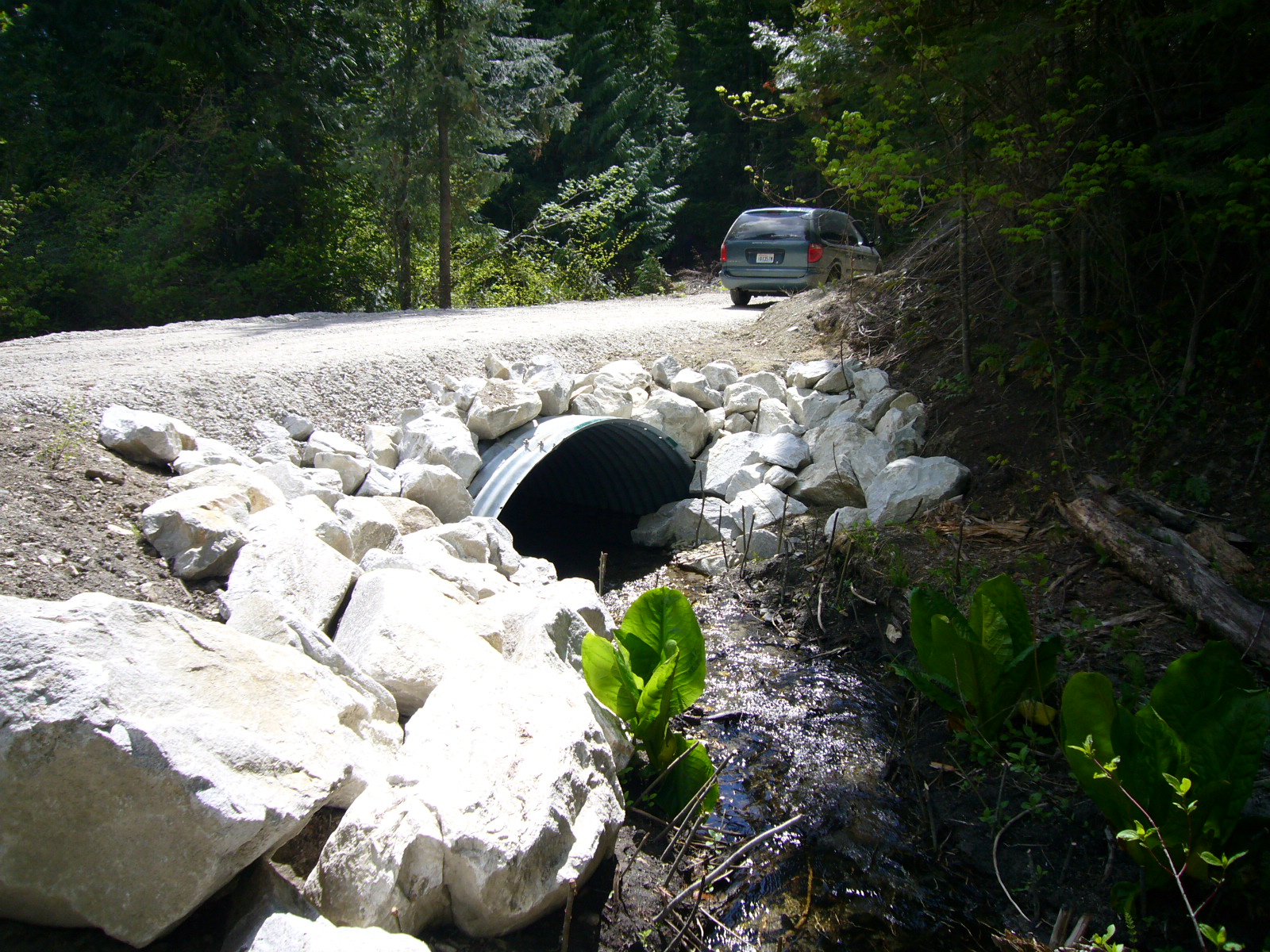

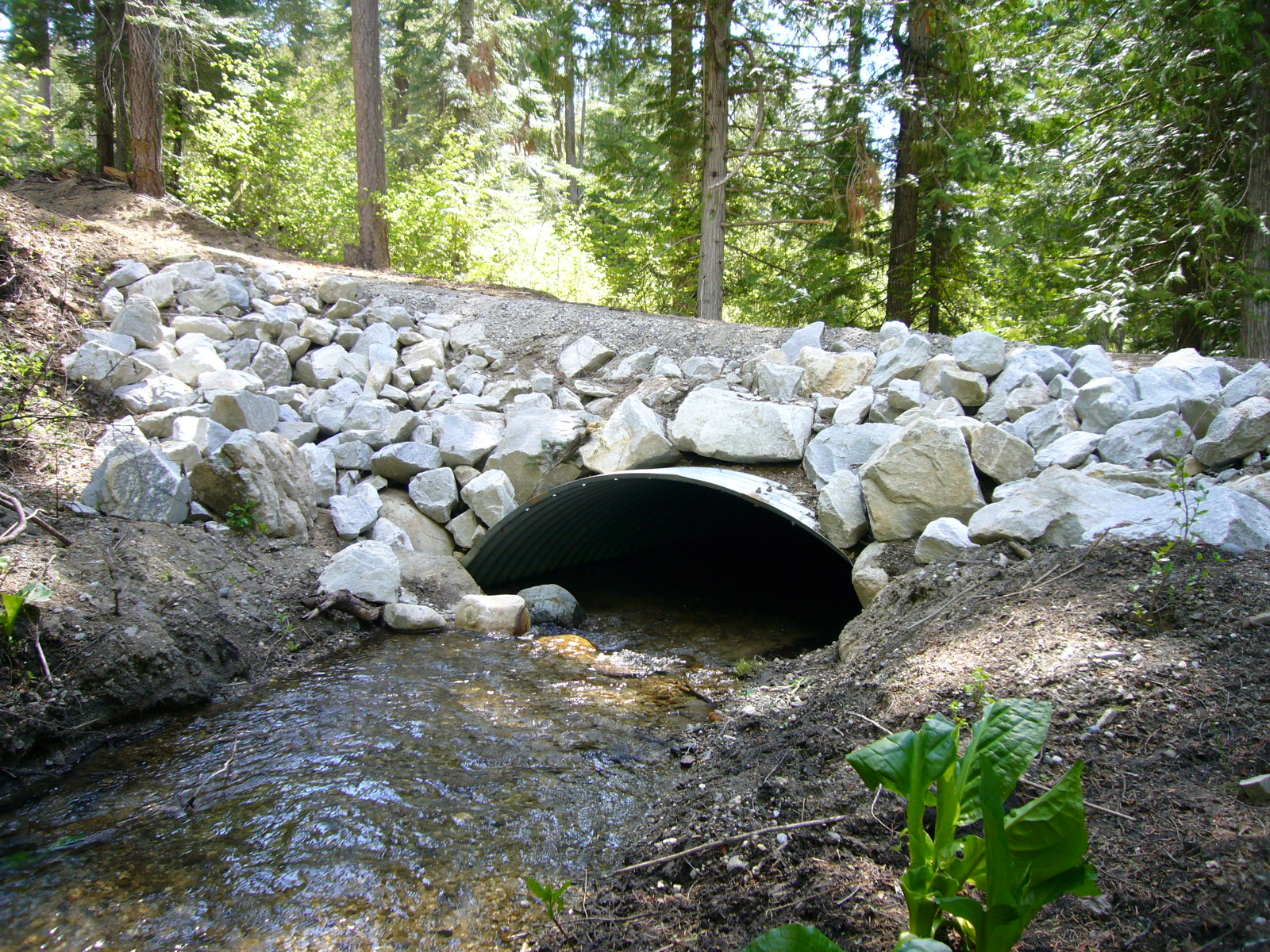

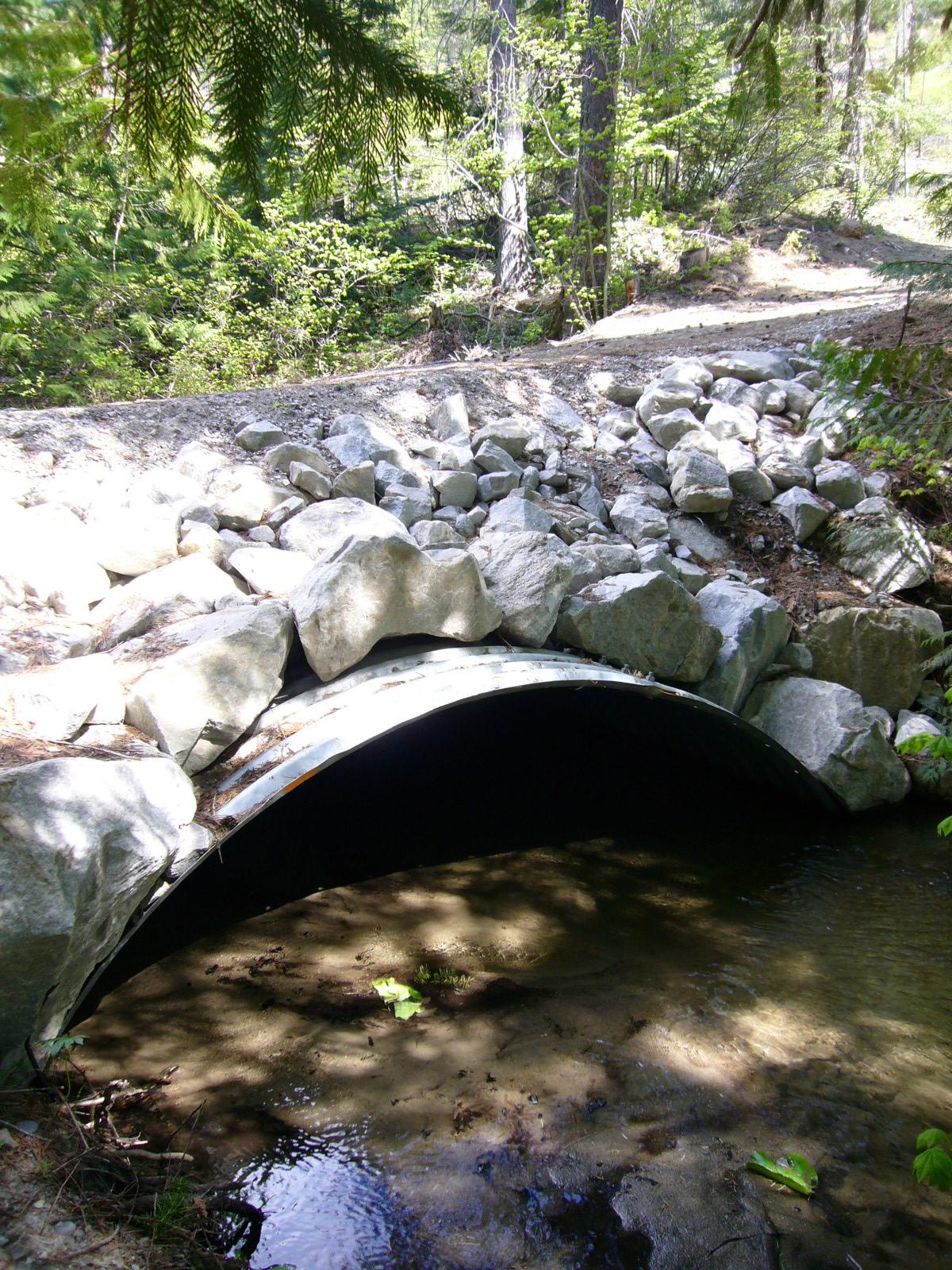

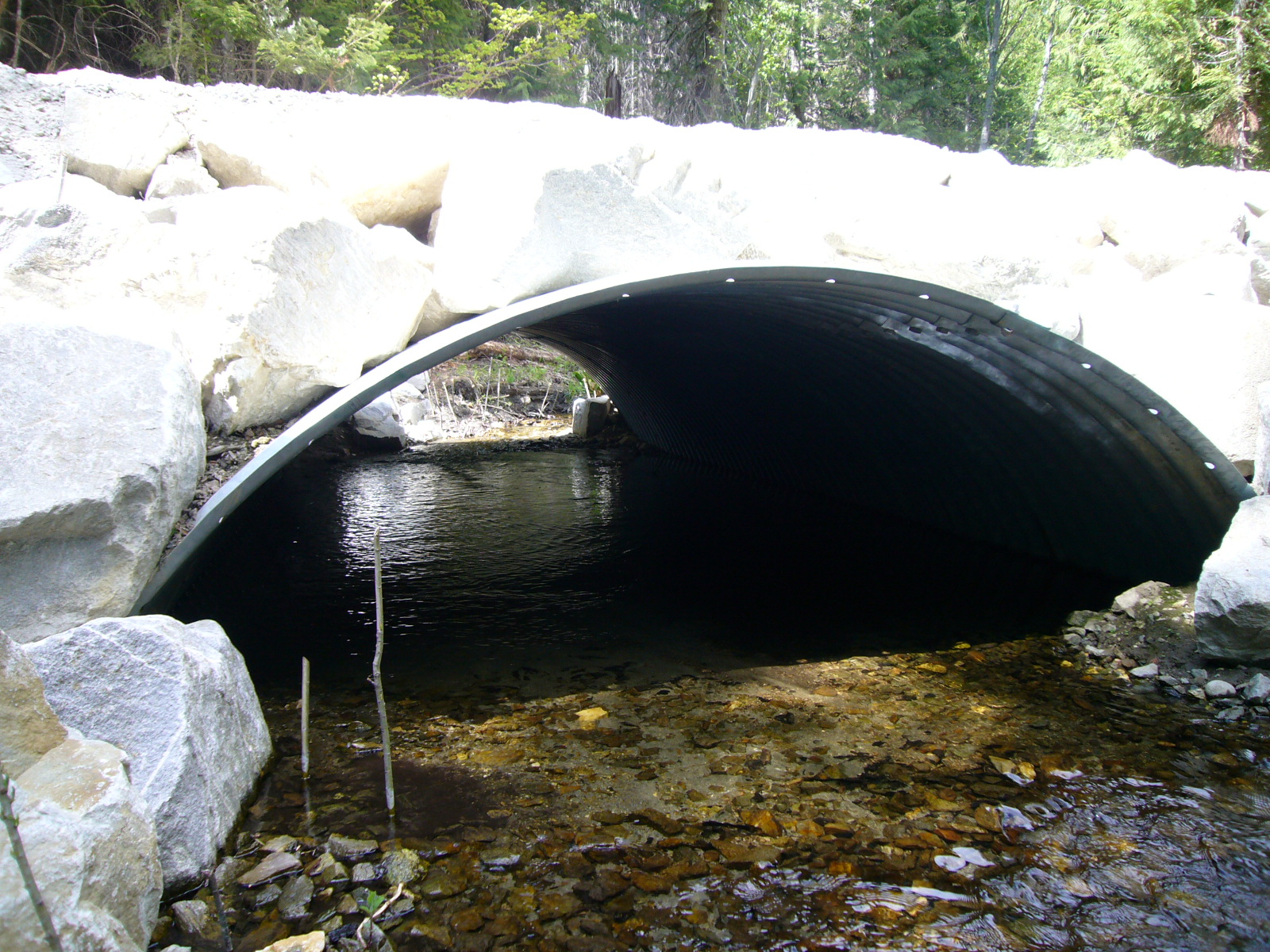

Clear Creek Passage (#1)
|
Architectural & Engineering (A&E), Channel structure placement (C.4.d.1), Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1), Fishway chutes or pools installed (C.2.d.1), Restoration signs, Traffic control, Utility relocation / reconnection
|
$165,830
|
| Total | $165,830 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Clear Creek Passage (#1)
|
|
Property 1 - Property - Worksite #1
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Fish passage blockages removed or altered (C.2.c.1) |
|
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2)
|
3
|
Culvert installed or improved (C.2.f.1) |
|
Miles of stream made accessible by culvert installation/repair (C.2.f.3)
|
1.00
|
|
Number of culverts (C.2.f.2)
|
3
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
3
|
Milestone Name | Target Date | Description |
Project Start
|
12/20/2006
|
|
Applied for Permits
|
02/05/2007
|
|
A&E Plans Submitted
|
05/11/2007
|
|
Bid Awarded/Consultant Hired
|
06/18/2007
|
|
Annual Project Billing Due
|
07/15/2007
|
|
Construction Started
|
08/01/2007
|
|
Construction Complete
|
08/30/2007
|
|
Agreement End Date
|
11/30/2007
|
|
Final Docs/Billing to Mgmt Agy
|
01/31/2008
|
|
