Beaver Creek Passage Program
|
    Funding |
  |
|
    Links |
  |
|
|

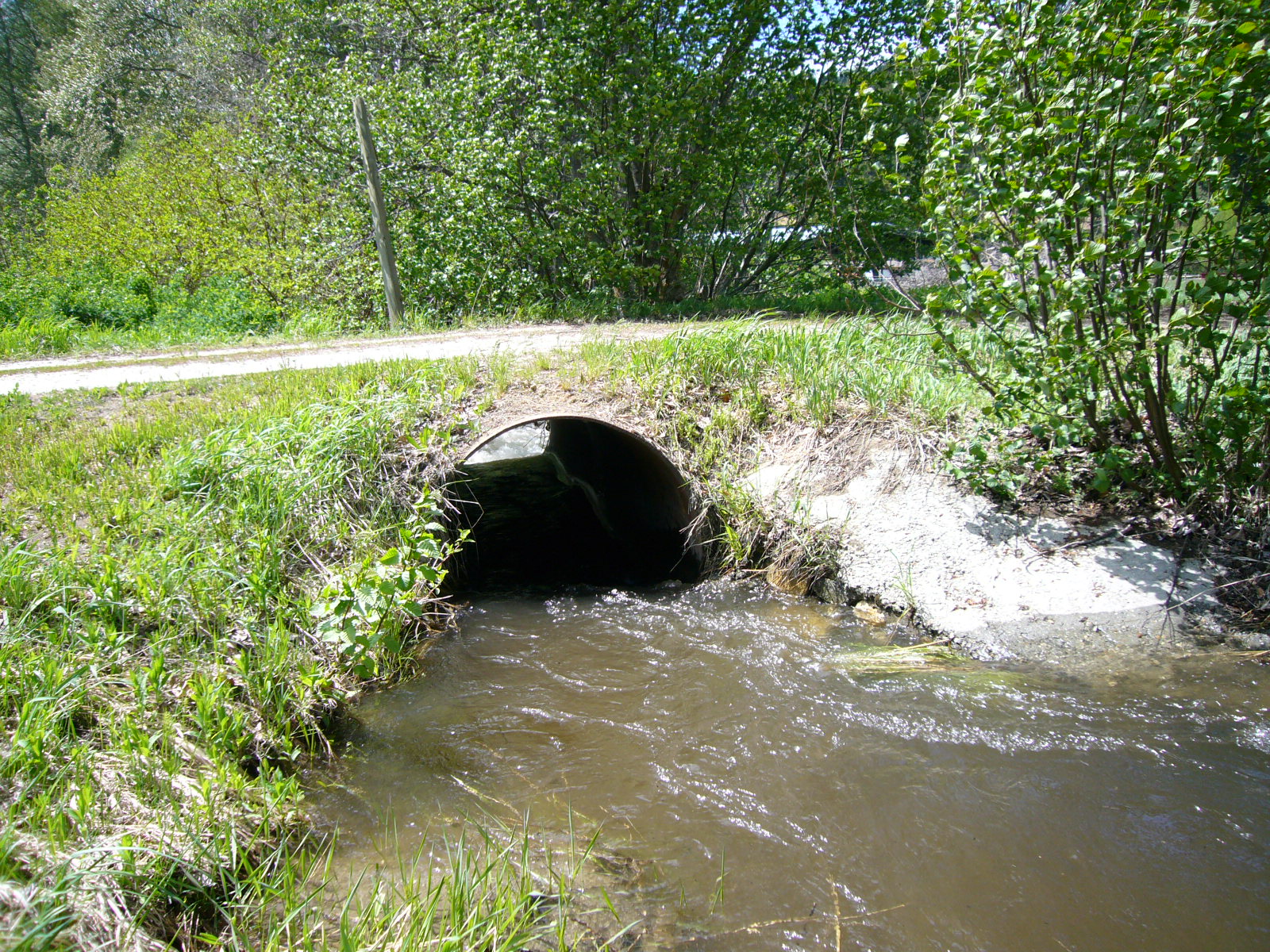

The Beaver Passage Program addresses 4 passage barriers within a 0.6 mile reach of the Beaver Creek sub-basin. Chelan County Natural Resources Department proposes to replace the three passage barrier culverts with modular steel bridge structures and to remove one small timber dam. Beaver Creek is a tributary of the Wenatchee River at RM 46.2, a few miles below the junction of the Wenatchee and Chiwawa River. All sites are located on private property and are similar with respect to topography and proposed solution. The Chelan County Public Works Department is also scheduled to replace a barrier culvert at RM 0.3 during the 2007 construction season.
Providing access in Beaver Creek will directly benefit ESA listed summer steelhead for at a least one life stage and will add 2.0 linear miles of habitat. Summer steelhead are known to be present to the first barrier; in 2004 during steelhead surveys, 15 steelhead reds were found in Beaver Creek by the Forest Service near the mouth. Beaver Creek also has a known presence of coho and bulltrout (WFDW 2005). Summer steelhead are the target species; however, some life stages of spring Chinook, bulltrout and coho may likely derive some benefit from this program.
|
General Area:
|
|

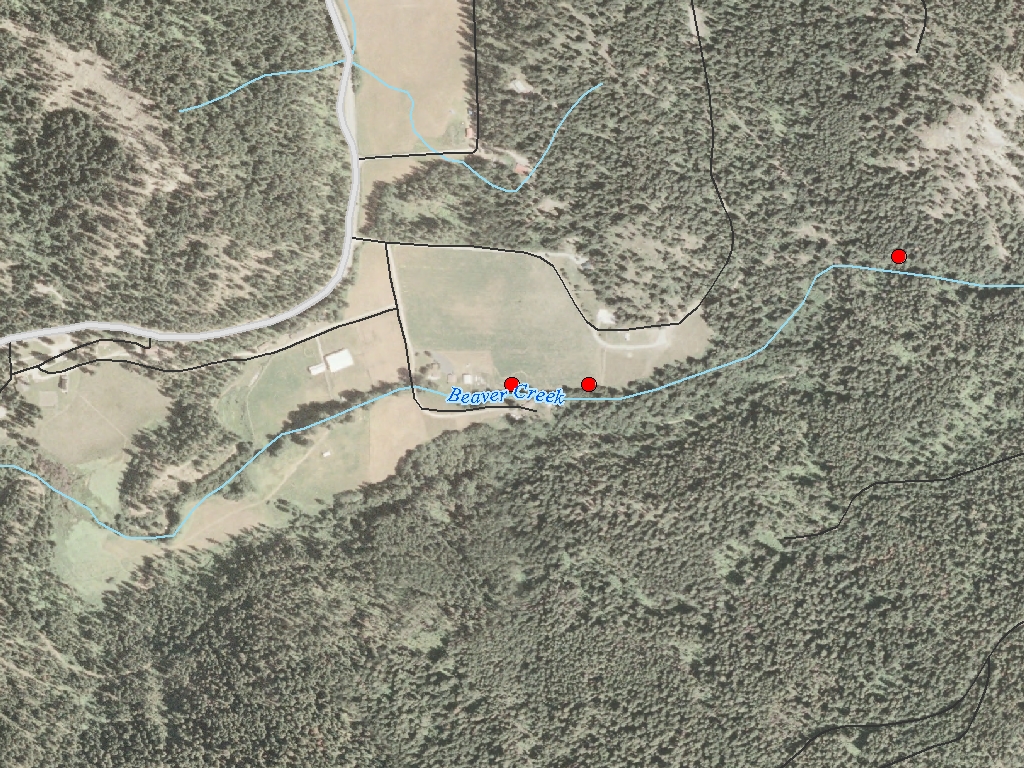

Beaver Creek, a tributary of the Wenatchee at RM 46.2
|
Waterbody:
|
|
Beaver Creek, Wenatchee River
|
County:
|
|
Chelan
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Upper Columbia River
|
Watershed Administrative Unit:
|
|
Tumwater Canyon
|
HUC8:
|
|
Wenatchee (17020011)
|
WRIA:
|
|
Wenatchee
|
Sections:
|
|
05
|
Township:
|
|
T26NR18E
|
Coordinates:
|
|
47.77521147 -120.62606081
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Beaver Creek Passage Program (#1)
|

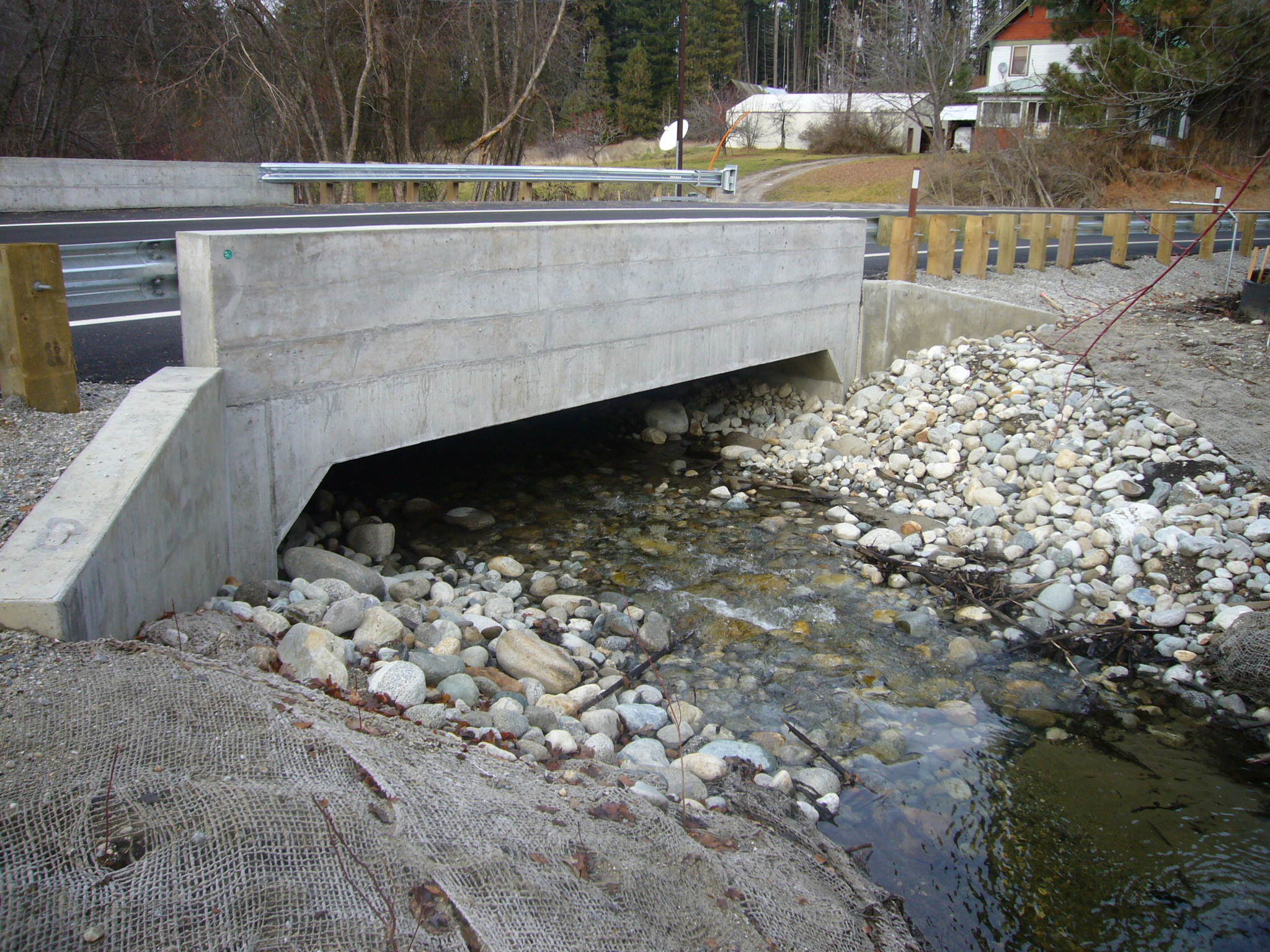

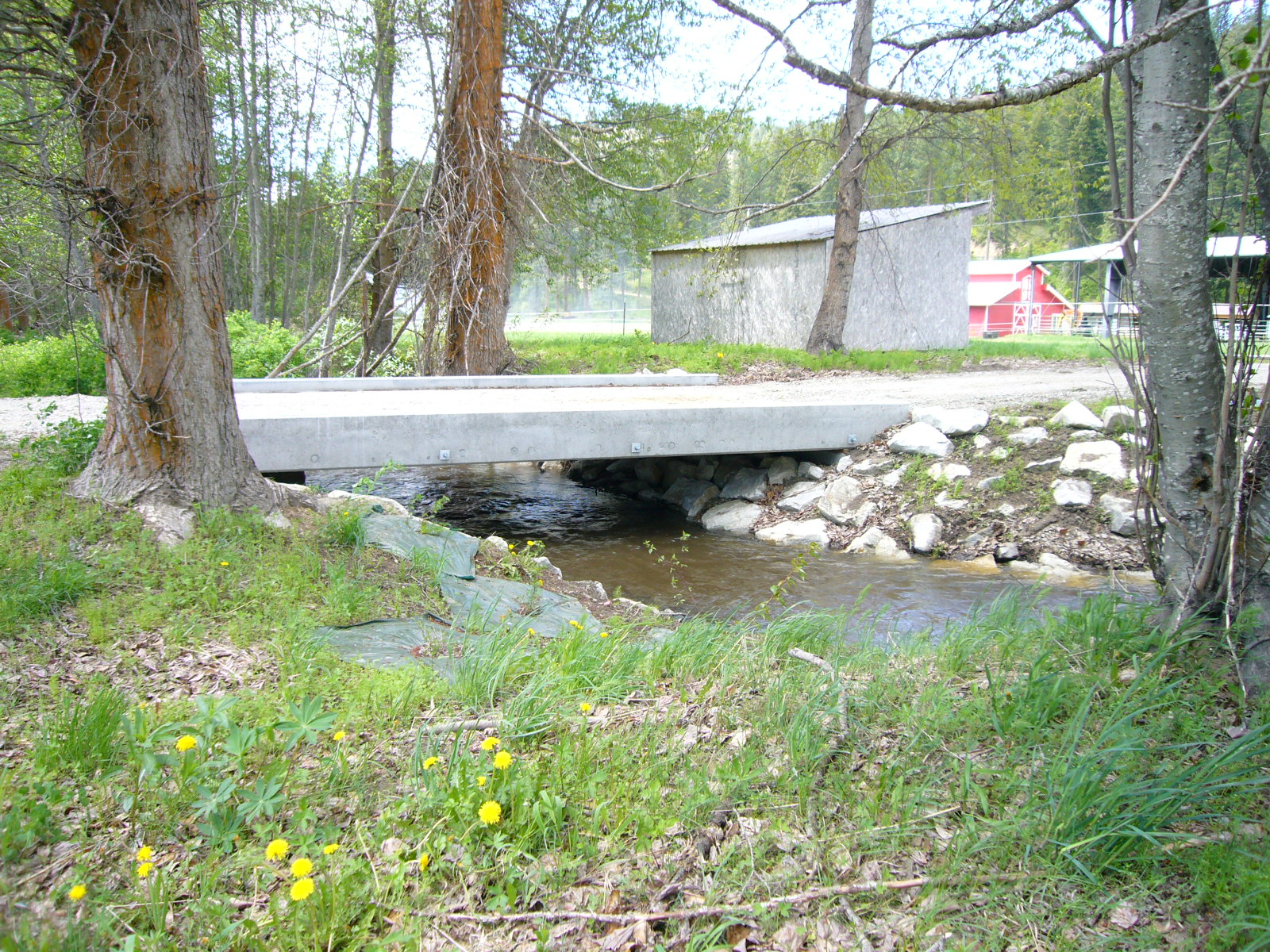

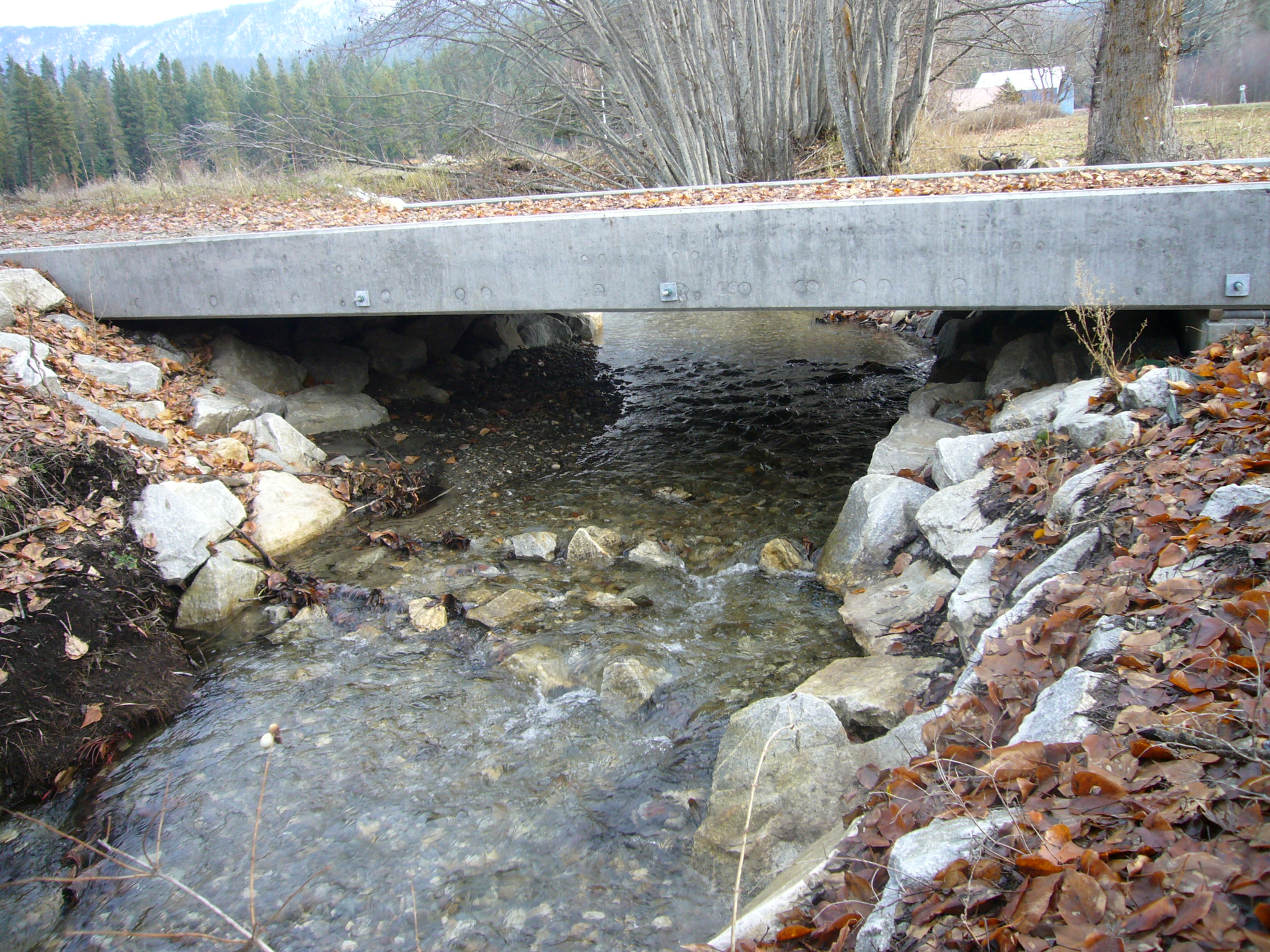

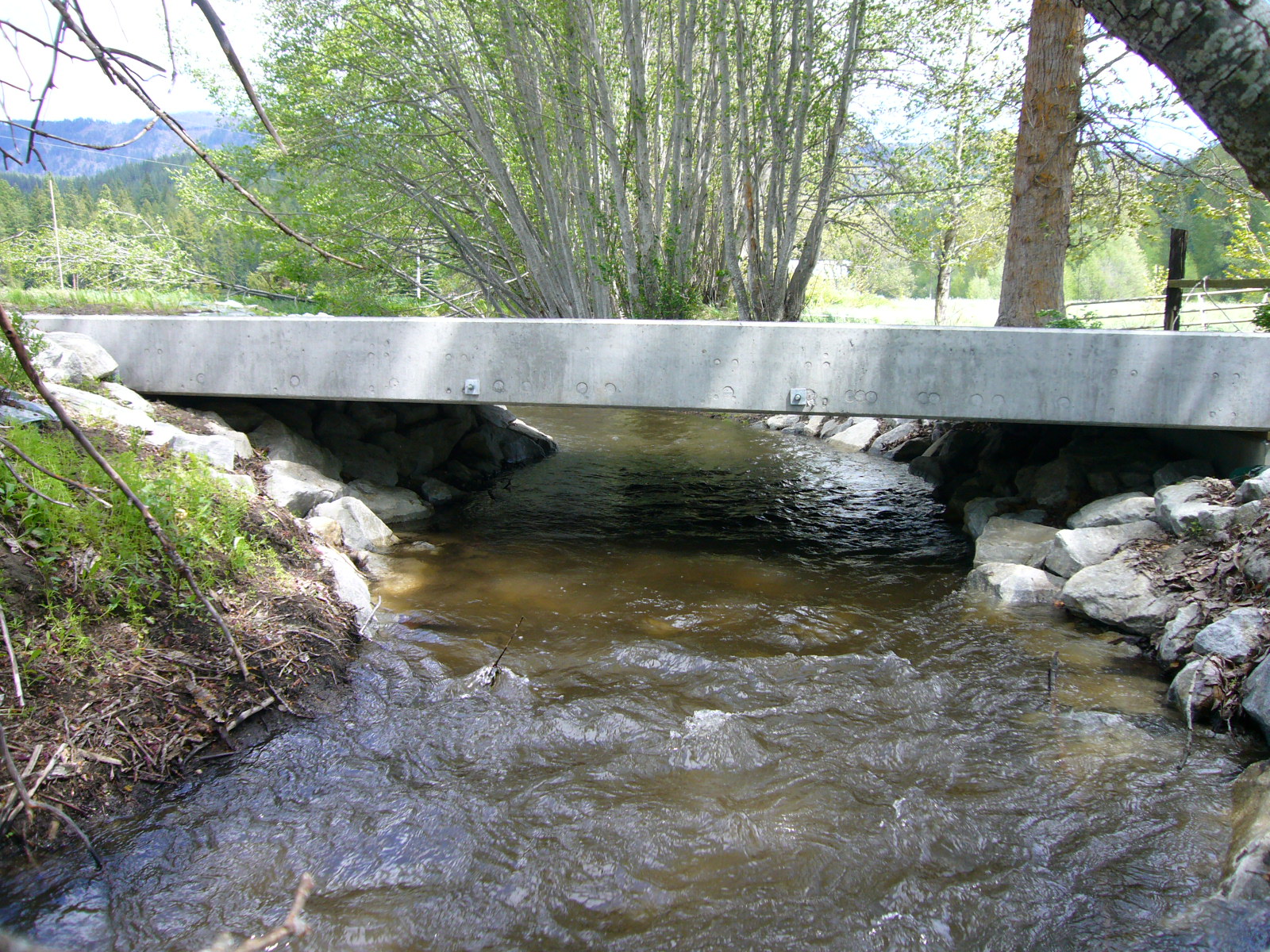

Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Channel structure placement (C.4.d.1), Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1), Fishway chutes or pools installed (C.2.d.1), Other restoration activities, Restoration signs, Restored land maintained (C.11.c.1), Road-crossing removal (C.2.i.1), Traffic control, Utility relocation / reconnection
|
$285,391
|
| Total | $285,391 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Beaver Creek Passage Program (#1)
|
|
Property 1 - Youth Dynamics
|
Private
|
Beaver Creek Passage Program (#1)
|
|
Property 2 - Kemper
|
Private
|
Beaver Creek Passage Program (#1)
|
|
Property 3 - Campbell
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Fish passage blockages removed or altered (C.2.c.1) |
|
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2)
|
3
|
Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
3.00
|
Road-crossing removal (C.2.i.1) |
|
Miles of stream made accessible by road crossing removal (C.2.i.3)
|
3.00
|
Bridge installed or improved (C.2.g.1) |
|
Number of bridges (C.2.g.2)
|
3
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
3
|
Milestone Name | Target Date | Description |
Project Start
|
12/20/2006
|
|
Applied for Permits
|
02/05/2007
|
|
A&E Plans Submitted
|
05/11/2007
|
|
Bid Awarded/Consultant Hired
|
06/18/2007
|
|
Annual Project Billing Due
|
07/15/2007
|
|
Construction Started
|
08/01/2007
|
|
Construction Complete
|
11/30/2007
|
|
Annual Project Billing Due
|
07/31/2008
|
|
Agreement End Date
|
11/30/2008
|
|
Final Docs/Billing to Mgmt Agy
|
01/31/2009
|
|
