Project Snapshot
PRISM Project #99-1611 (Completed)
Omak Creek Restoration
    Project Details
Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

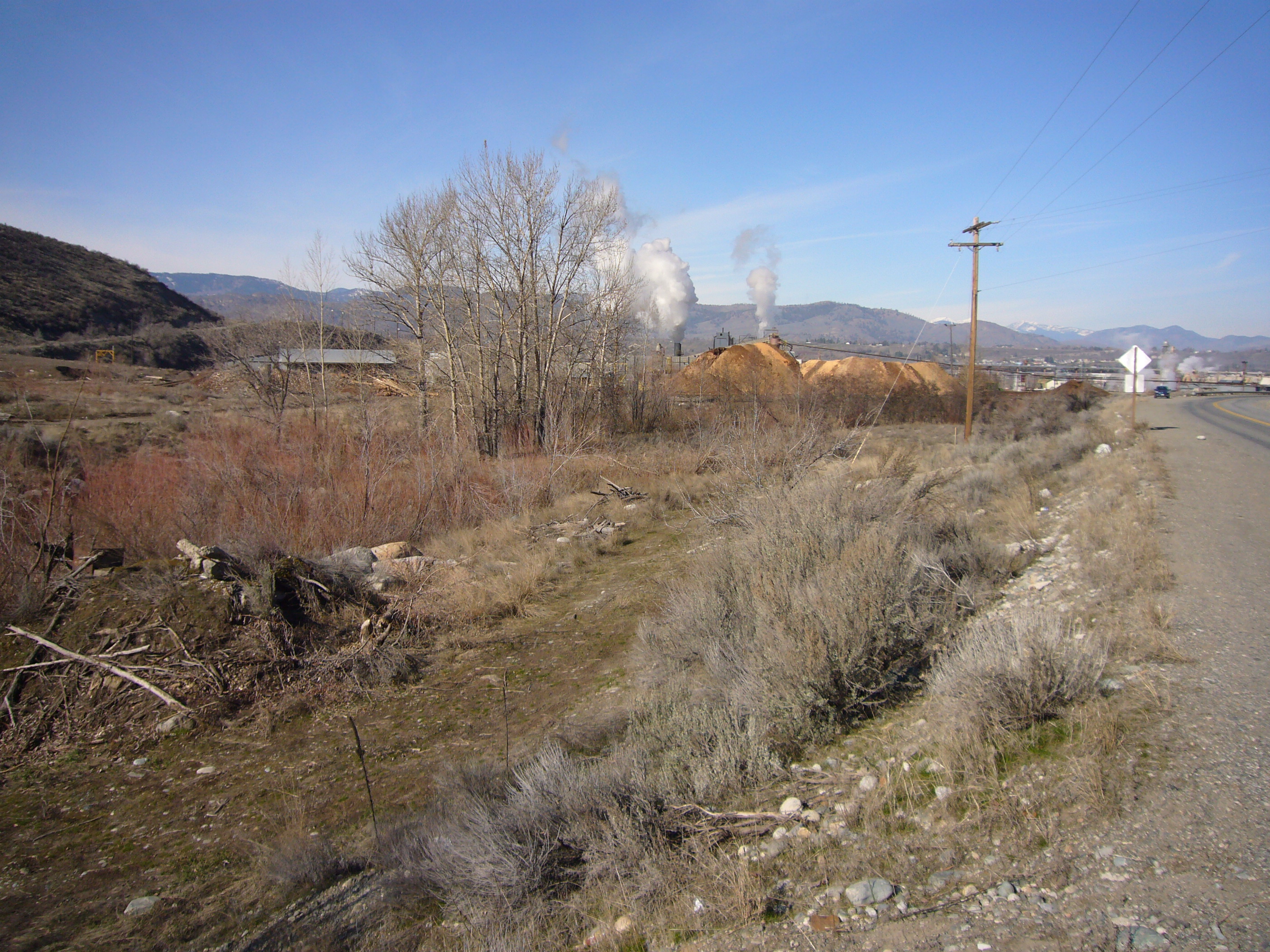

Attachment #243176, P1060807

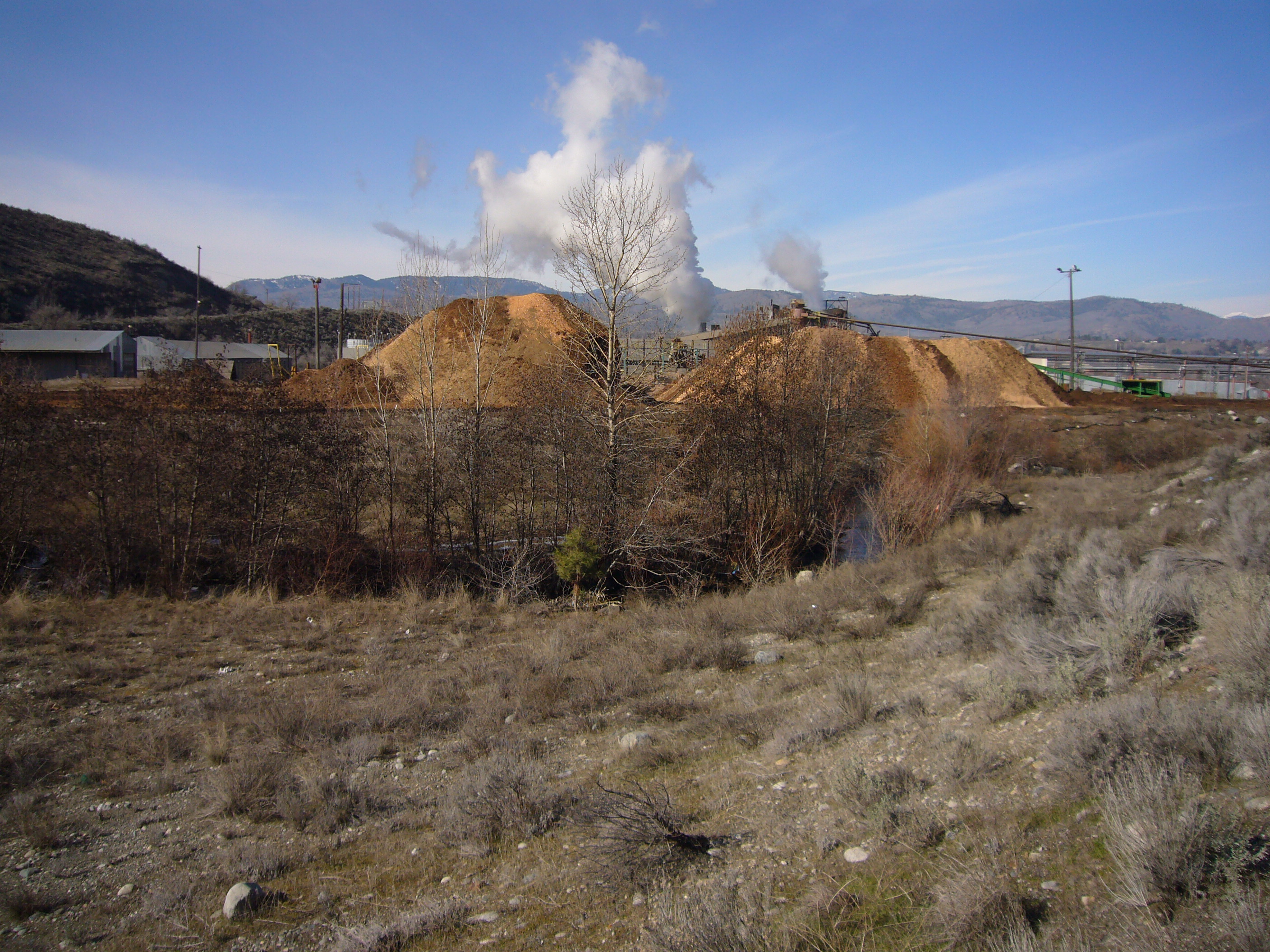

Colville Confederated Tribes; Omak Creek Restoration (#99-1611) Attachment #243176, P1060807

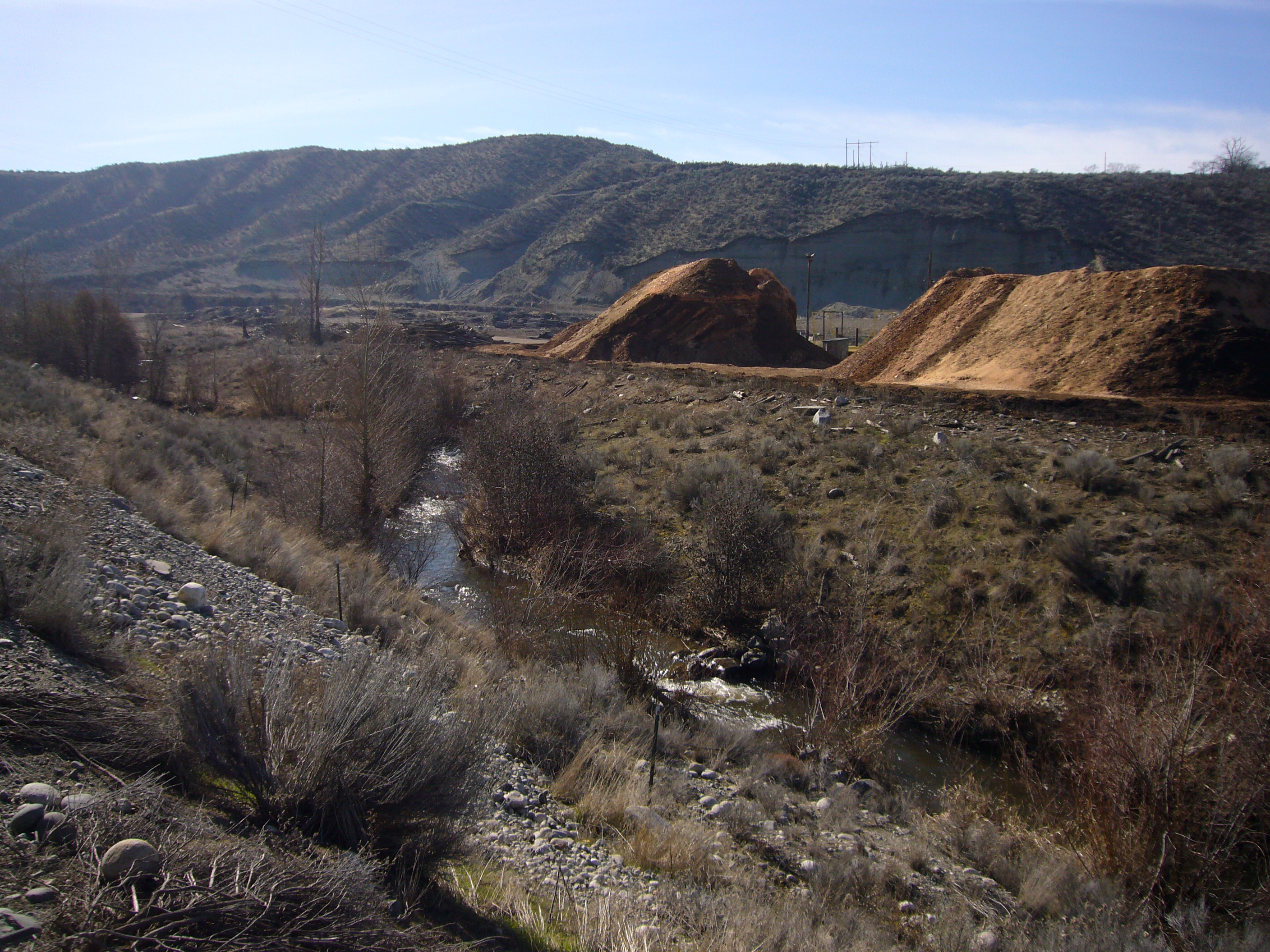

Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

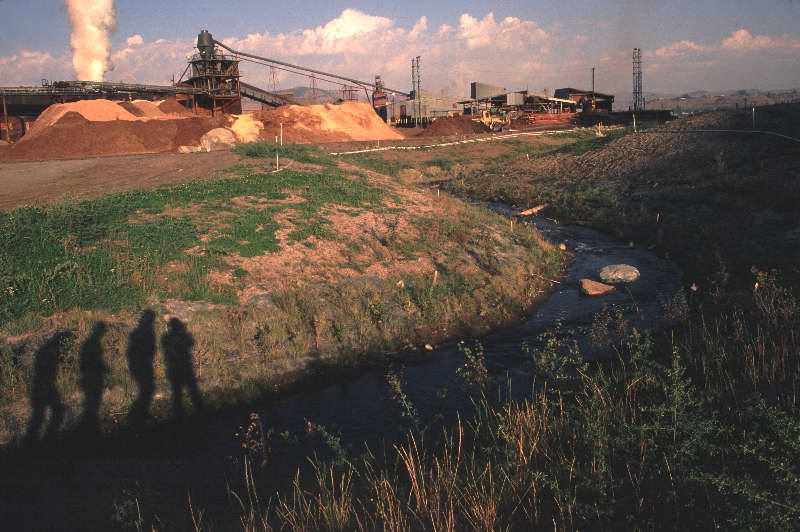

Attachment #243176, P1060807 Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

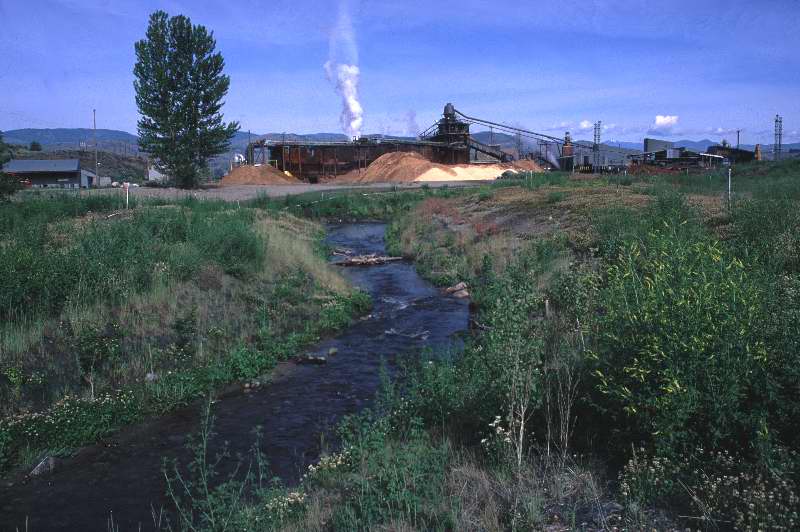

10/05/1999, Attachment #2367, AfterColville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243177, P1060824Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243178, P1060820Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243179, P1060817Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243180, P1060828Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243181, P1060808Colville Confederated Tribes; Omak Creek Restoration (#99-1611)

Attachment #243182, P1060832
Project Status:  Closed Completed since 10/14/1999

Project Type:  Restoration
Project Sponsor:  Confederated Tribes of the Colville Reservation
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon Federal Projects: $130,000
Total RCO Grant: $130,000 (22%)
Sponsor Match: $472,010 (78%)
Total Agreement: $602,010 (100%)
              Links


    Project Description
This project will restore riparian habitat and reduce surface and bank erosion to a new stream channel. Omak Creek, a tributary to the Okanogan River and historically fished by the members of the Colville Confederated Tribes (CCT), has been identified as a priority for restoration in the Mid-Columbia Habitat Conservation Plan (HCP). During the 1920's Omak Creek was routed under a timber mill site via an 1800 foot section of corrugated metal pipe (cmp), which created a velocity barrier to migrating salmonids. Adult steelhead, an endangered species, have been observed at the outlet of this section of cmp (G. Marco, CCT-Fish and Wildlife, personal communication). In 1998 the timber mill was purchased by Quality Veneer and Lumber. Owners decided to relocate Omak Creek away from the mill. The new open channel is approximately 3,000 ft. in length and includes meanders and "step" pools. The new channel will consist of one 200 ft. section of bottomless arch culvert which will not impede fish migration. Complications and increased cost during the construction of the channel and installation of the culvert have postponed certain restoration practices (erosion control methods, vegetation planting, in-stream structures). If not completed, the new channel and adjacent land surfaces would be susceptible to erosion and bank instability and the result would adversely impact in-stream habitat in Omak Creek and the Okanogan River.

    Project Contacts

Project Sponsor: Confederated Tribes of the Colville Reservation Lead Entity: Upper Columbia Salmon Recovery Board Lead Entity
  Project Contact: Chris Fisher
chris.fisher@colvilletribes.com
(509) 422-7427


Funding Agency: Recreation and Conservation Office
  Project Manager: Amee Bahr
Amee.Bahr@rco.wa.gov
(360) 867-8585


    Project Location
County:   Okanogan
Legislative District:   07
Congressional District 2022:   04
Salmon Recovery Regions:   Upper Columbia River
Watershed Administrative Unit:   Mission
HUC8:   Okanogan (17020006)
WRIA:   Okanogan
Sections:   36
Township:   T34NR26E
Coordinates:   48.40015110
-119.50560669

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Omak Creek (FFSH) (#1) Channel reconfiguration and connectivity (C.4.c.1), Channel structure placement (C.4.d.1), Streambank stabilization (C.4.e.1) $602,010
 Total$602,010
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Omak Creek (FFSH) (#1)   Property 1 - Property - Worksite #1 Private
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Instream Habitat Project
      Streambank stabilization (C.4.e.1)
Miles of Streambank Stabilized (C.4.e.3) 1.14

    Project Milestones
Milestone NameTarget DateDescription
Project Start 05/01/1999
Estimated Billing Schedule 06/01/1999
Design & Engineering Complete 06/01/1999
Permits Complete 10/01/1999
Plans Reviewed by Mgmt Agy 11/01/1999
Bid Awarded 12/01/1999
Construction Started 01/01/2000
100% Construction Complete 07/01/2000
Sept 30th Annual Report 09/30/2000
Agreement End Date 09/30/2000
Final Docs/Billing to Mgmt Agy 12/30/2000
