Project Snapshot
PRISM Project #04-1716 (Completed)
Tepee Creek Fish Passage Restoration
    Project Details
Yakama Nation; Tepee Creek Fish Passage Restoration (#04-1716)

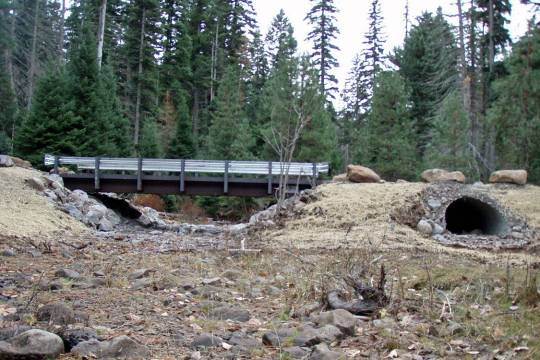

Attachment #153220, White Creek - IXL Road after
Yakama Nation; Tepee Creek Fish Passage Restoration (#04-1716) Attachment #153220, White Creek - IXL Road after

Yakama Nation; Tepee Creek Fish Passage Restoration (#04-1716)

Attachment #153220, White Creek - IXL Road after Yakama Nation; Tepee Creek Fish Passage Restoration (#04-1716)

Attachment #153222, White Creek - IXL Road before
Project Status:  Closed Completed since 04/29/2009

Project Type:  Restoration
Project Sponsor:  Confederated Tribes and Bands of the Yakama Nation
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon Federal Projects: $176,713
Total RCO Grant: $176,713 (70%)
Sponsor Match: $75,804 (30%)
Total Agreement: $252,517 (100%)
              Links

    Project Description
Tepee Creek, a tributary to White Creek in the Klickitat River subbasin, provides important spawning and rearing habitat for ESA-listed Mid Columbia River steelhead. The White Creek watershed as a whole is likely the most important spawning and rearing tributary watershed within the Klickitat subbasin. In recent years, the White Creek watershed has accounted for up to 40% of the observed steelhead spawning in the entire Klickitat subbasin. Tepee Creek has accounted for up to 21% of the observed spawning in the Klickitat subbasin in recent years, however in most years it likely accounts for between 5% and 10%. This project will replace 3 partial barriers to restore juvenile access to 8.7 miles of upstream habitat. Because of the very low to nonexistent base flow conditions at many spawning areas, post-emergence movement by steelhead fry and juveniles is critical to their survival. Access to refugia (in the form of perennially-flowing stream reaches or remnant pools in otherwise dry reaches) is necessary for successful rearing within this watershed.

    Project Contacts

Project Sponsor: Confederated Tribes and Bands of the Yakama Nation Lead Entity: Klickitat Lead Entity
  Project Contact: Will Conley

(509) 369-3183

Funding Agency: Recreation and Conservation Office
  Project Manager: Kay Caromile
kay.caromile@rco.wa.gov
(360) 867-8532

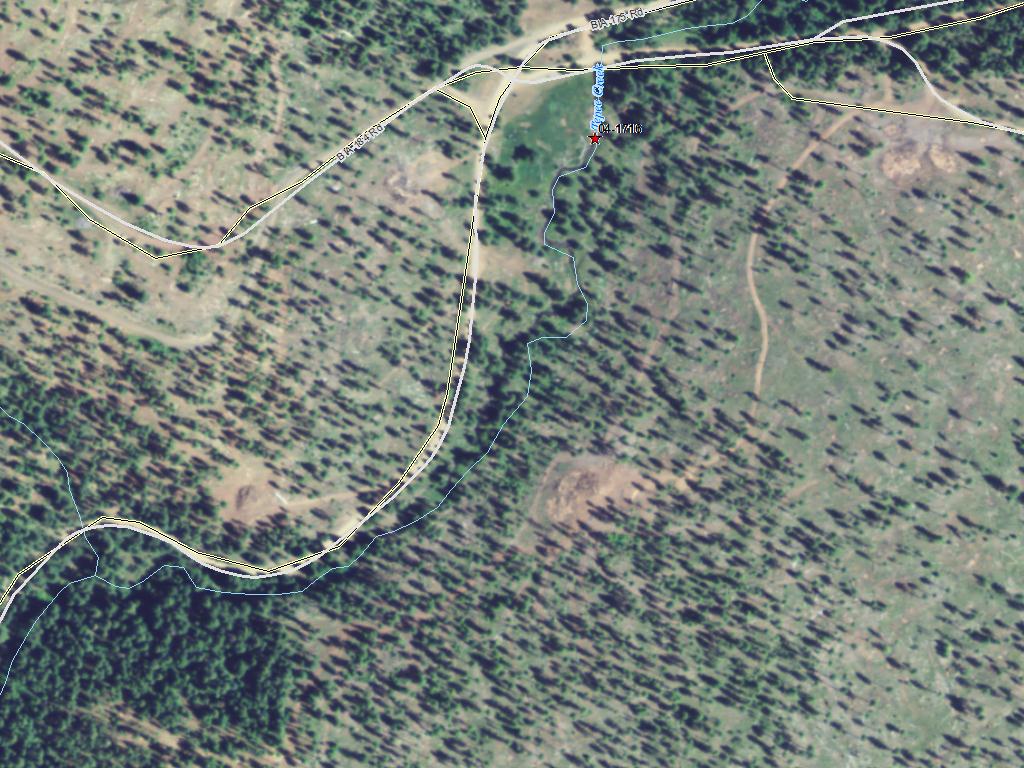

    Project Location
General Area:   Tepee Creek, a tributary of White Creek in the Klickitat River subbasin.
Waterbody:   East Fork Tepee Creek, Tepee Creek, White Creek
County:   Yakima
Legislative District:   14
Congressional District 2022:   04
Salmon Recovery Regions:   Middle Columbia River
Watershed Administrative Unit:   Tepee Creek
HUC8:   Klickitat (17070106)
WRIA:   Klickitat
Sections:   14
Sections:   22
Sections:   27
Township:   T08NR14E
Coordinates:   46.18066044
-121.02412727

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Tepee Ck. Fish Passage Rest., upper site (#1) Architectural & Engineering (A&E), Culvert installed or improved (C.2.f.1) $19,376
Tepee Ck. Fish Passage Rest.,middle site (#2) Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1) $152,383
Tepee Ck. Fish Passage Rest.,lower site (#3) Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1), Streambank stabilization (C.4.e.1) $152,382
White Creek-IXL Road Crossing (#4) Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1), Streambank stabilization (C.4.e.1) $152,382
 Total$476,523
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Tepee Ck. Fish Passage Rest., upper site (#1)   Property 1 - Property - Worksite #1 Tribal Government
Tepee Ck. Fish Passage Rest.,middle site (#2)   Property 2 - Property - Worksite #2 Tribal Government
Tepee Ck. Fish Passage Rest.,lower site (#3)   Property 3 - Property - Worksite #3 Tribal Government
White Creek-IXL Road Crossing (#4)   Property 4 - White Creek/IXL road crossing Tribal Government
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Fish Passage Improvement
      Fish passage blockages removed or altered (C.2.c.1)
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2) 4

Instream Habitat Project
      Streambank stabilization (C.4.e.1)
Miles of Streambank Stabilized (C.4.e.3) 0.02

Fish Passage Improvement
      Culvert installed or improved (C.2.f.1)
Miles of stream made accessible by culvert installation/repair (C.2.f.3) 6.27
Number of culverts (C.2.f.2) 4

Number of blockages / impediments / barriers impeding passage (C.2.b.4) 4

    Project Milestones
Milestone NameTarget DateDescription
Project Start 12/03/2004
Construction Started 09/01/2006
Annual Project Billing Due 07/31/2008 Annual billing required
Construction Complete 12/01/2008
Agreement End Date 12/01/2008
Final Docs/Billing to Mgmt Agy 02/15/2009

    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State Agreement.pdf 04/08/2011
Correspondence TeePee Fish Passage Evaluation.pdf 08/26/2004
Correspondence TepeeCulverts_photos.pdf 08/10/2004
Evaluation proposal Tepee Creek Eval Proposal 12c.pdf 07/16/2004
Final project report SRFB_TepeePassage_Final.ppt 09/13/2012
Final project report Tepee Creek Final Report..pdf 04/06/2009
Map 052009-Tepee Creek Fish.pdf 04/06/2009
Map Tepe Creek Map.pdf 07/16/2004
Photo White Creek - IXL Road before.jpg 10/05/2012
Photo White Creek - IXL Road after.jpg 10/05/2012
SRFB Review Panel Comment Form 04-1716 SRFB Comment Form.pdf 07/29/2015
WDFW barrier & screening forms Tepee Creek Barrier Eval 12e 12f 3.pdf 07/16/2004
WDFW barrier & screening forms Tepee Creek Barrier Eval 12e 12f 2.pdf 07/16/2004
WDFW barrier & screening forms Tepee Creek Barrier Eval 12e 12f 1.pdf 07/16/2004

Back to top Date of last change: 05/16/2024
