Project Snapshot
PRISM Project #00-1144 (Completed)
Salmon Creek: Instream Flows
    Project Details
Okanogan Irrigation District; Salmon Creek:  Instream Flows (#00-1144)

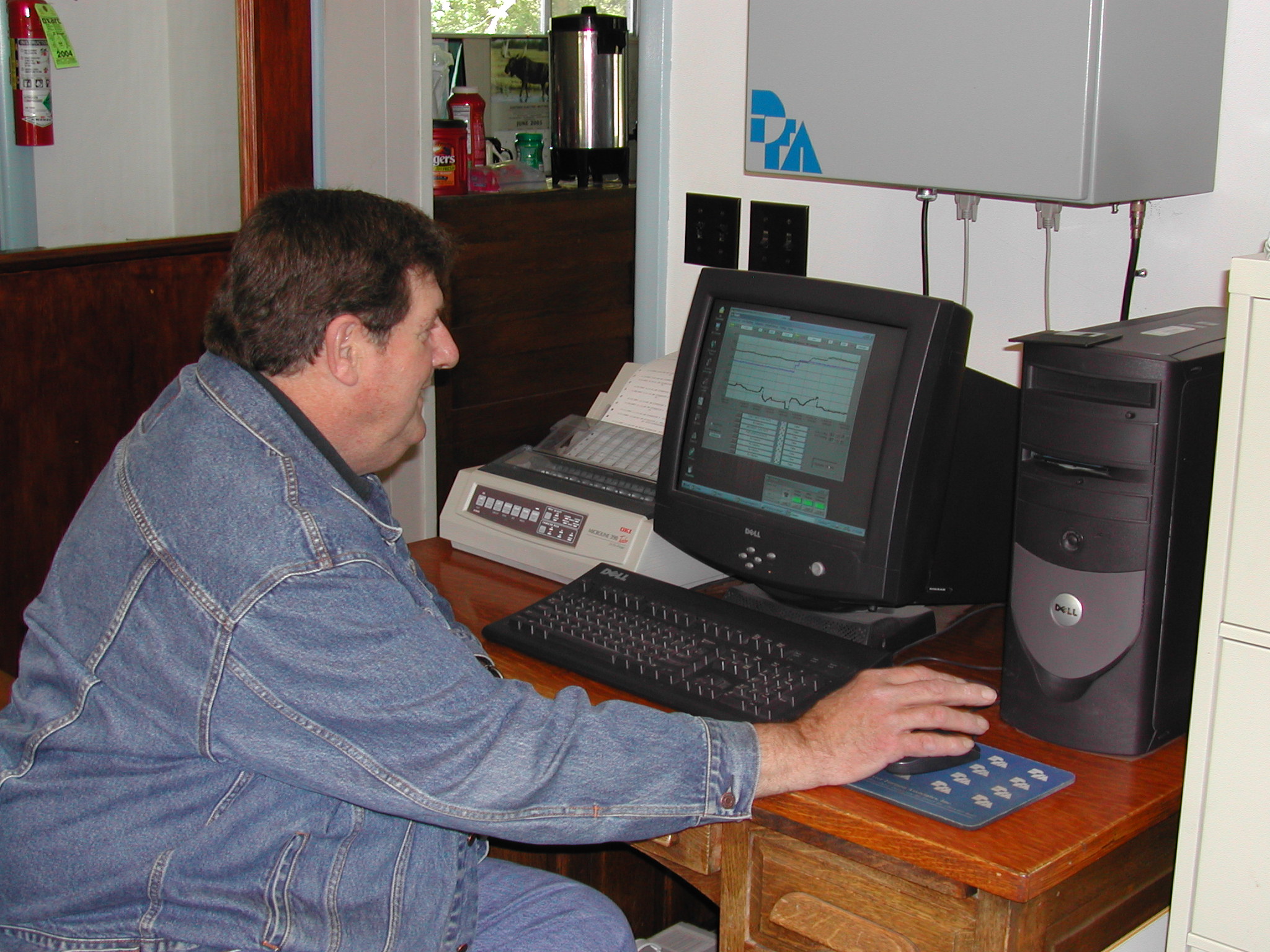

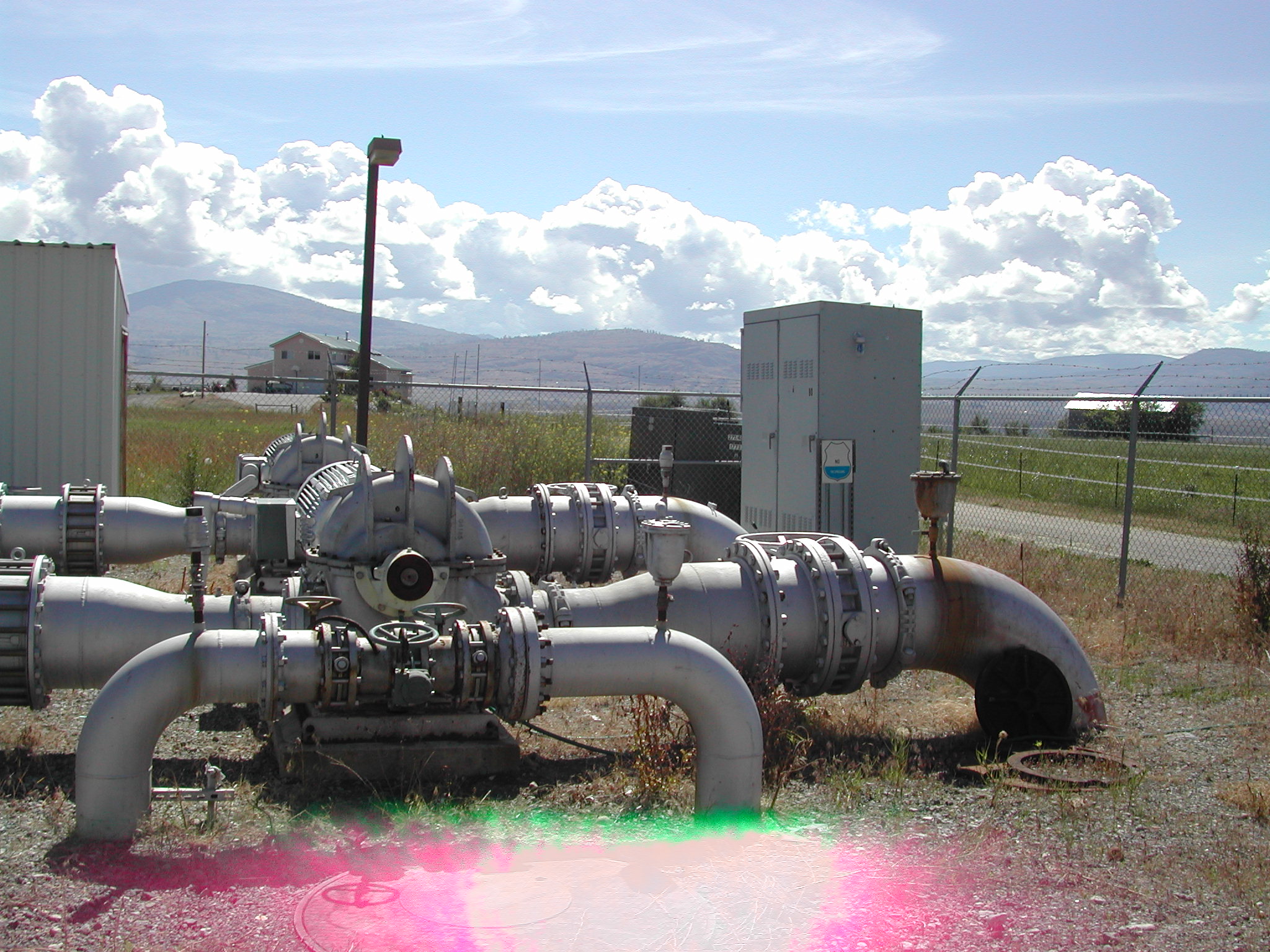

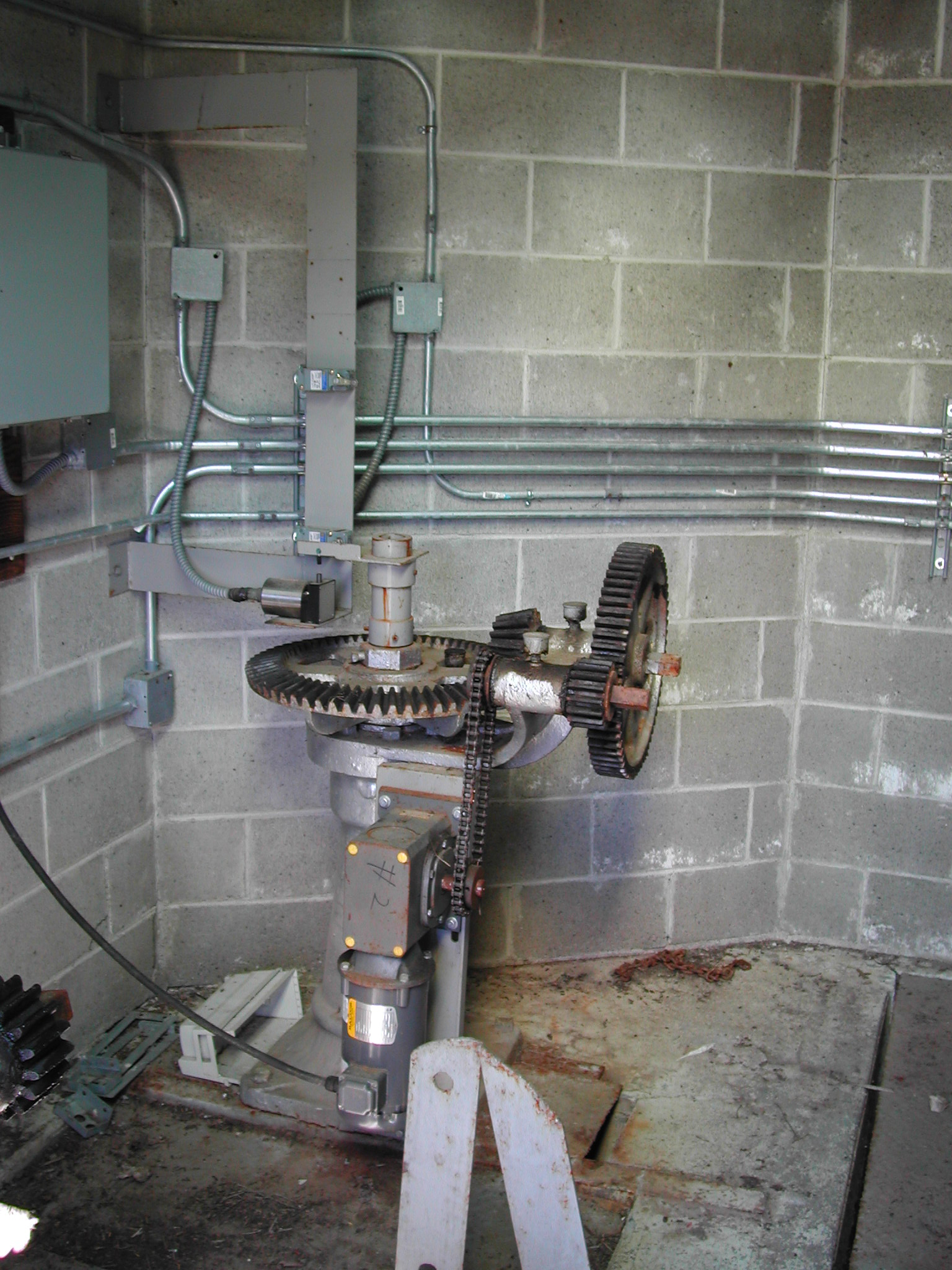

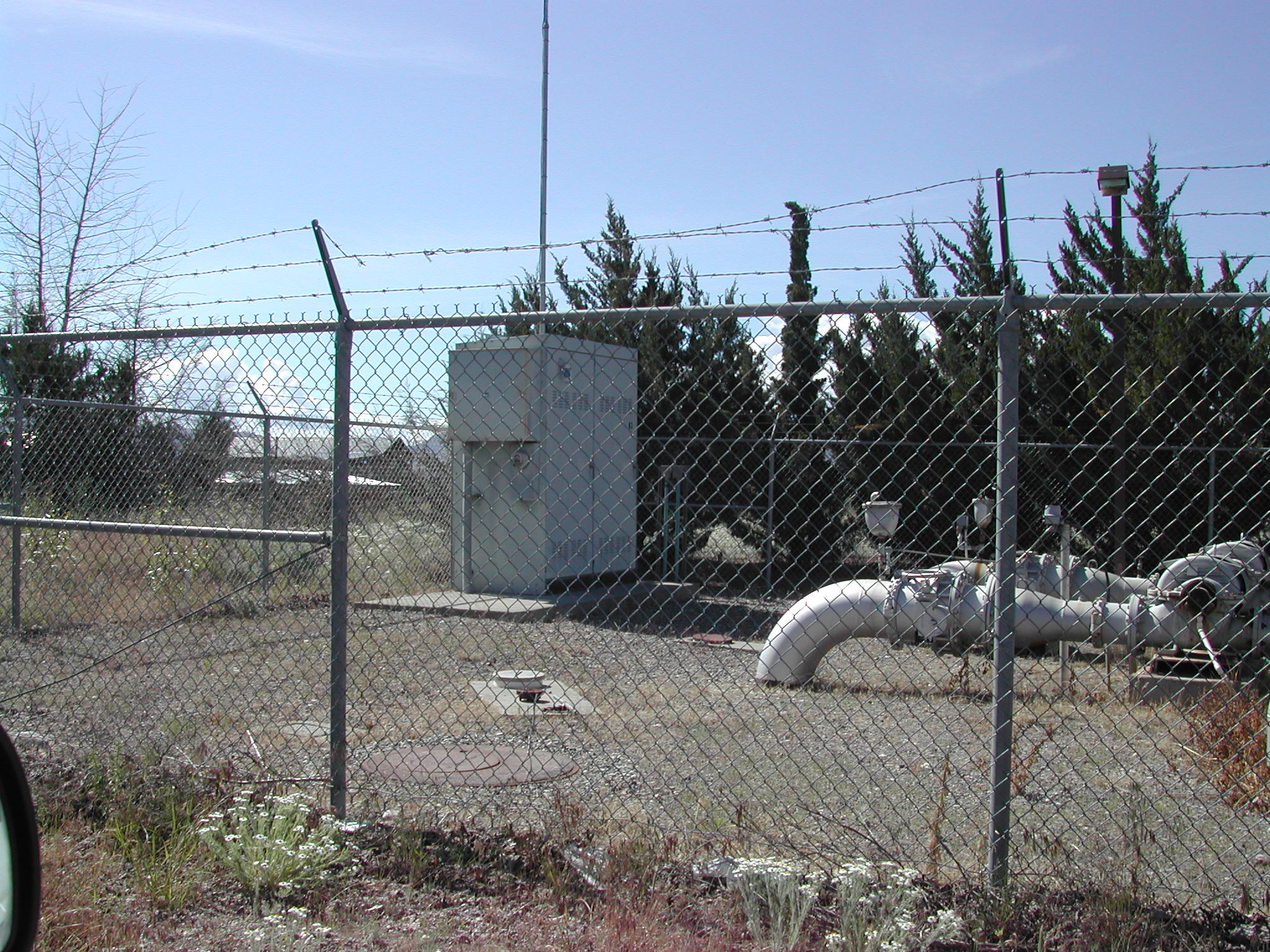

06/15/2005, Attachment #16342, Cunningham Pump Station
Okanogan Irrigation District; Salmon Creek: Instream Flows (#00-1144) 06/15/2005, Attachment #16342, Cunningham Pump Station

Okanogan Irrigation District; Salmon Creek:  Instream Flows (#00-1144)

06/15/2005, Attachment #16342, Cunningham Pump Station Okanogan Irrigation District; Salmon Creek:  Instream Flows (#00-1144)

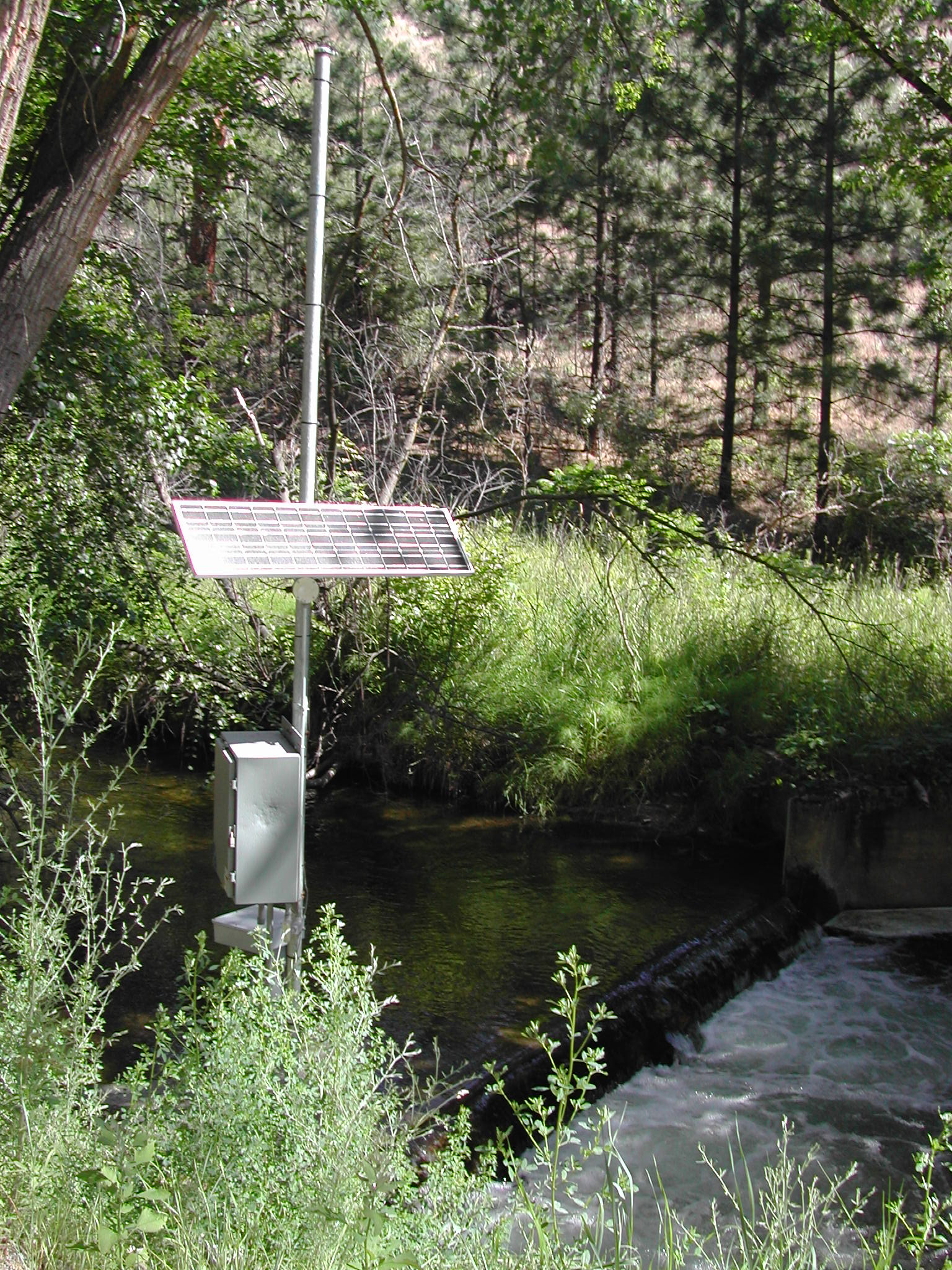

06/15/2005, Attachment #16343, Flow meter on Salmon Creek, above main diversion
Project Status:  Closed Completed since 07/06/2005

Project Type:  Restoration
Project Sponsor:  Okanogan Irrigation District
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon State Projects: $218,407
Total RCO Grant: $218,407 (77%)
Sponsor Match: $66,472 (23%)
Total Agreement: $284,879 (100%)
              Links


    Project Description
The Okanogan Irrigation District (OID) requests $230,000 to undertake agricultural water conservation throughout the district in order to save 600 acre ft of water annually which would be dedicated to instream flows for endangered steelhead & chinook. Presently the OID achieves an 86 % efficiency rate. District-wide conservation measures would be achieved by 1) installation of flow meters & flow measurement devices, 2) software for water budgeting, accounting & tracking of conserved water, 3) improvements to booster stations & variable speed drives, & 4) an automated system for water delivery. Inadequate instream flows obstruct access to 12 mi. of high quality spawning & rearing habitat above the OID diversion dam. Results of a limiting factors analysis in the lower 4.3 miles of Salmon Creek indicate that passage flows of 15-20 cfs are required below the diversion dam. A study undertaken by the OID & Colville Tribes identified alternatives to provide these flows. Conservation & six other alternatives are being implemented-together that would provide year-round flows to support the life cycles of steelhead & chinook. Salmon Creek is identified in 3 independent studies as having the greatest potential for supporting anadromous fish populations in the Okanogan Basin. A fish ladder has been constructed at the OID diversion dam & the District's fish screen has been upgraded to NMFS' criteria. To date, $2 million have been spent towards fish recovery in Salmon Creek.

    Project Contacts

Project Sponsor: Okanogan Irrigation District Lead Entity: Upper Columbia Salmon Recovery Board Lead Entity
  Project Contact: Tom Sullivan

(509) 826-1250


Funding Agency: Recreation and Conservation Office
  Project Manager: Amee Bahr
Amee.Bahr@rco.wa.gov
(360) 867-8585


    Project Location
General Area:   Salmon Creek west of Okanogan
Waterbody:   Okanogan, Salmon Creek
County:   Okanogan
Legislative District:   07
Congressional District 2022:   04
Salmon Recovery Regions:   Upper Columbia River
Watershed Administrative Unit:   Lower Salmon Creek
HUC8:   Okanogan (17020006)
WRIA:   Okanogan
Sections:   17
Township:   T33NR26E
Coordinates:   48.36307423
-119.58781054

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Salmon Cr. (#1) Irrigation practice improvement (C.3.e.1), Water flow gauges (C.3.d.1) $284,879
 Total$284,879
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Salmon Cr. (#1)   Property 1 - Property - Worksite #1 Local Government
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Instream Flow Project
      Water flow gauges (C.3.d.1)
Number of Water Flow Gauges (C.3.d.2) 10

    Project Milestones
Milestone NameTarget DateDescription
Project Start 08/01/2000
RFP Complete/Consultant Hired 09/01/2000
A&E Complete/Permits Submitted 03/01/2001
Monitor/Steward Plan Complete 03/01/2001
Monitoring Started 03/01/2001
Construction Started 04/01/2001
Construction Complete 09/15/2001
Monitoring Complete 05/31/2005 Ongoing
Agreement End Date 05/31/2005
Final Docs/Billing to Mgmt Agy 06/30/2005
